The Gateway - Construction Updates

Spanning four residential towers in the UK’s largest regeneration zone, The Gateway is an exciting new-build development offering a five-star living experience. Accompanying a range of high-end apartments are unrivalled onsite amenities such as a serene wellness spa, private dining area and fully fitted podcasting studio. Here are the latest construction updates for The Gateway.

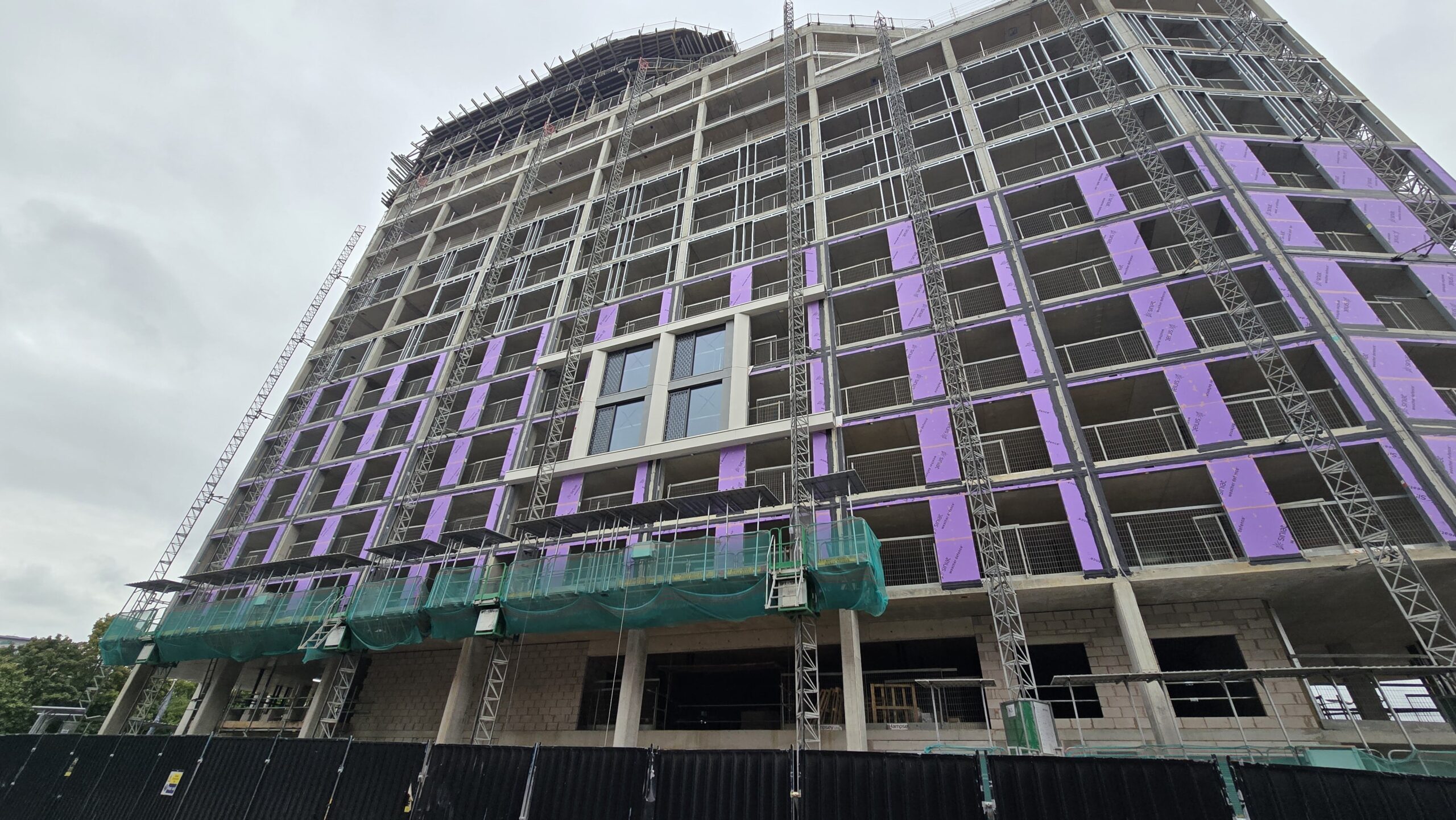

Q1 2024 Update

Video Thumbnail
19 Apr, 2024

The Gateway Q1 2024

January, February & March Construction Progress

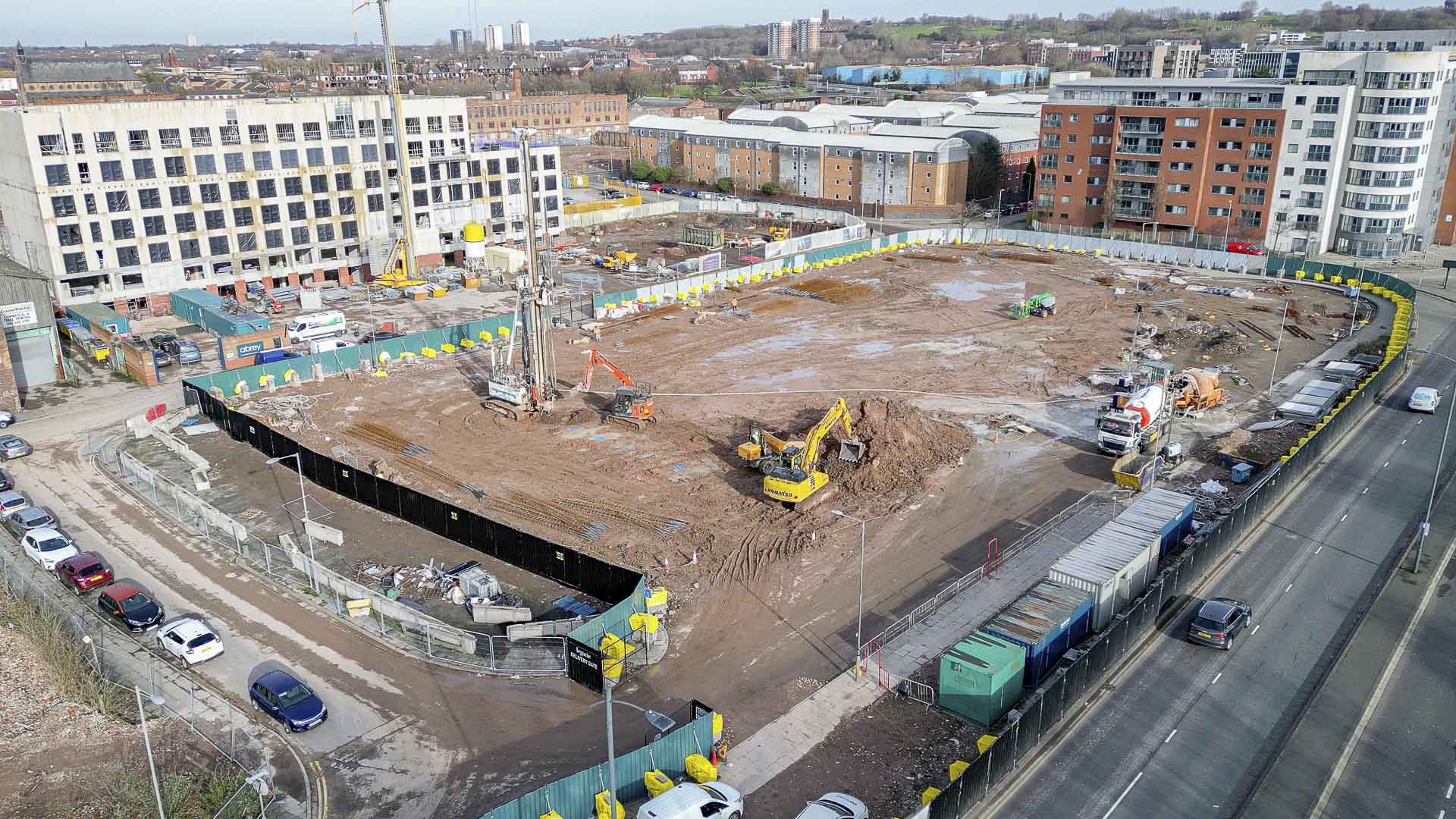

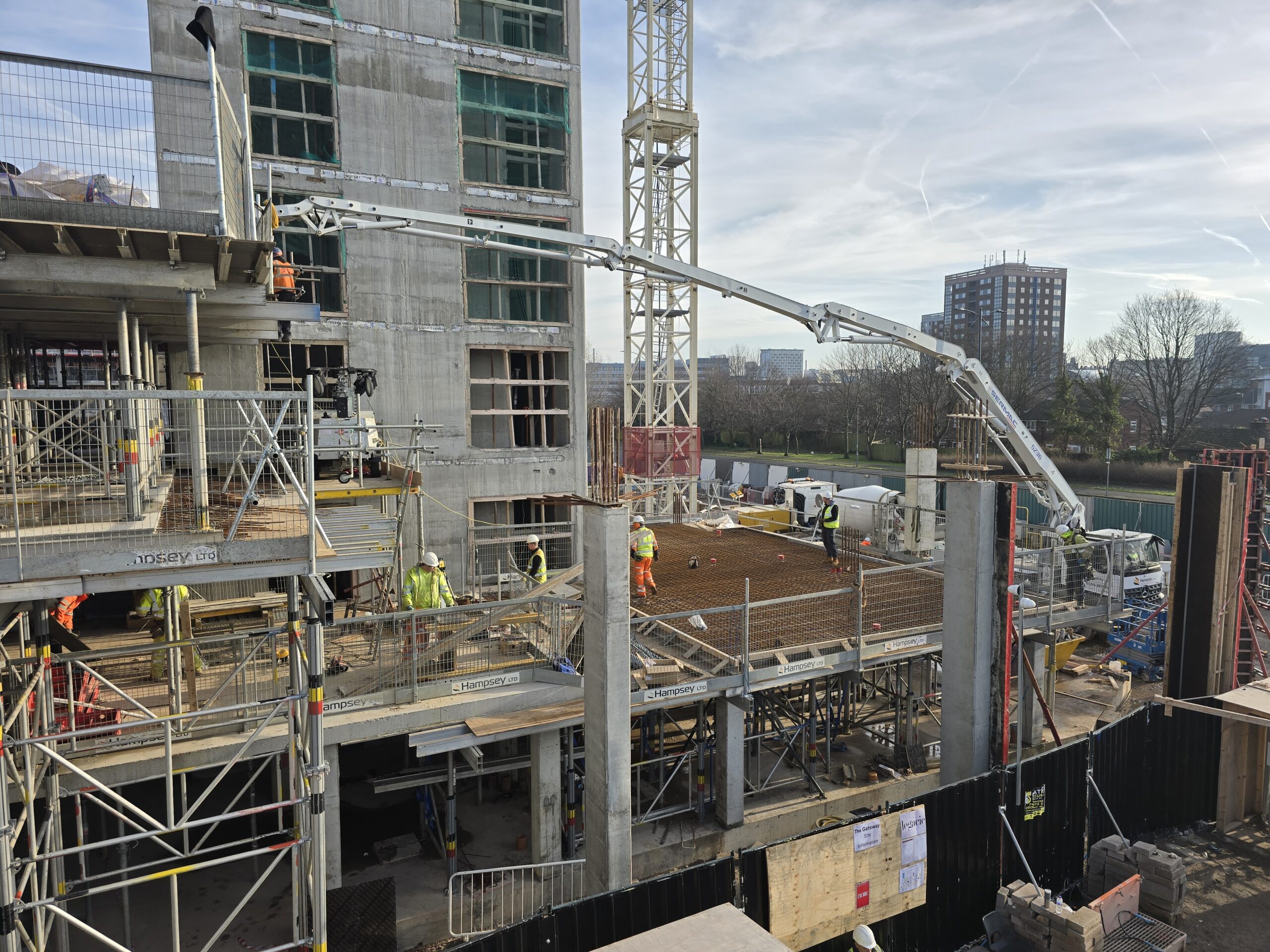

Q1 2024

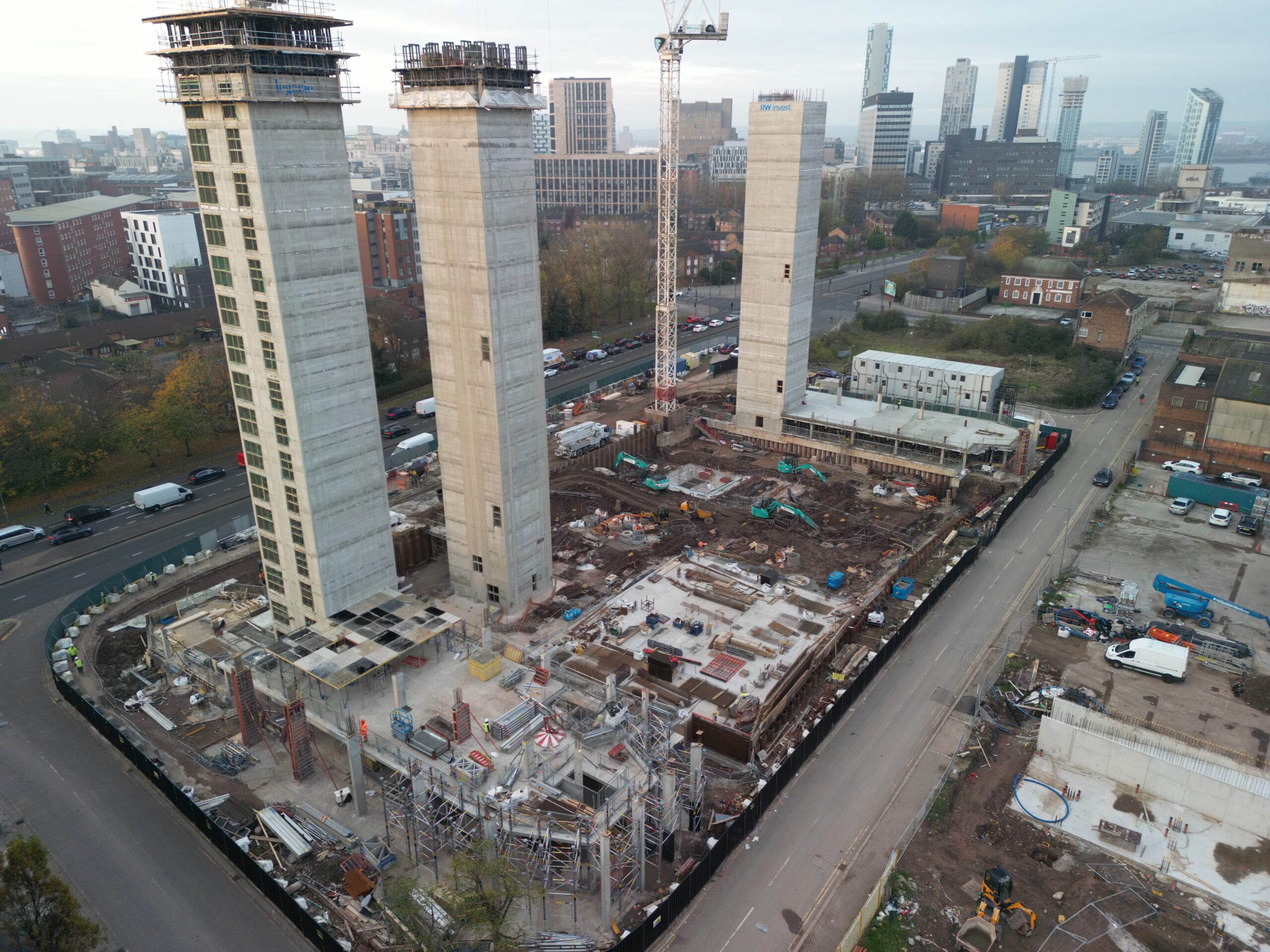

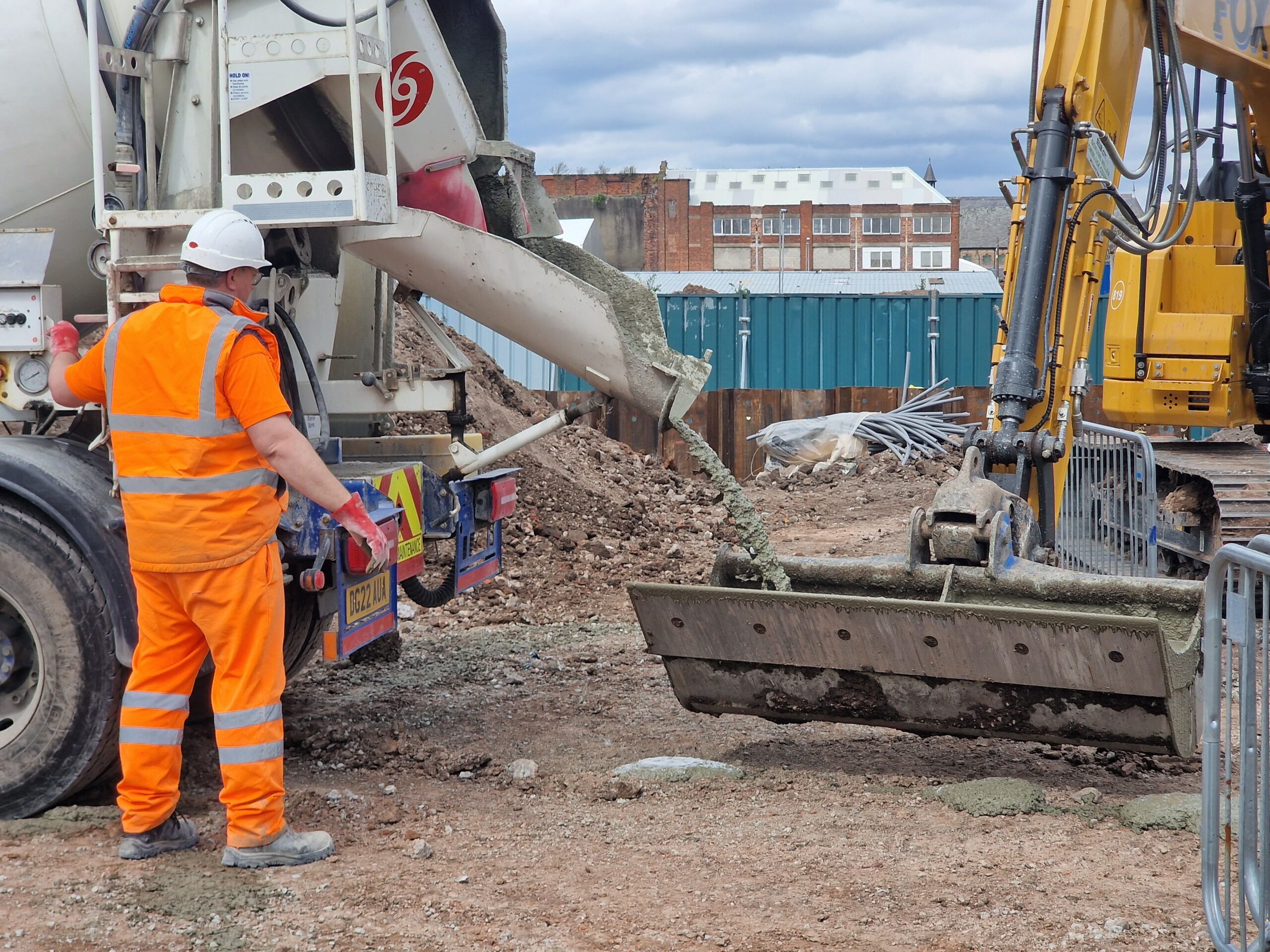

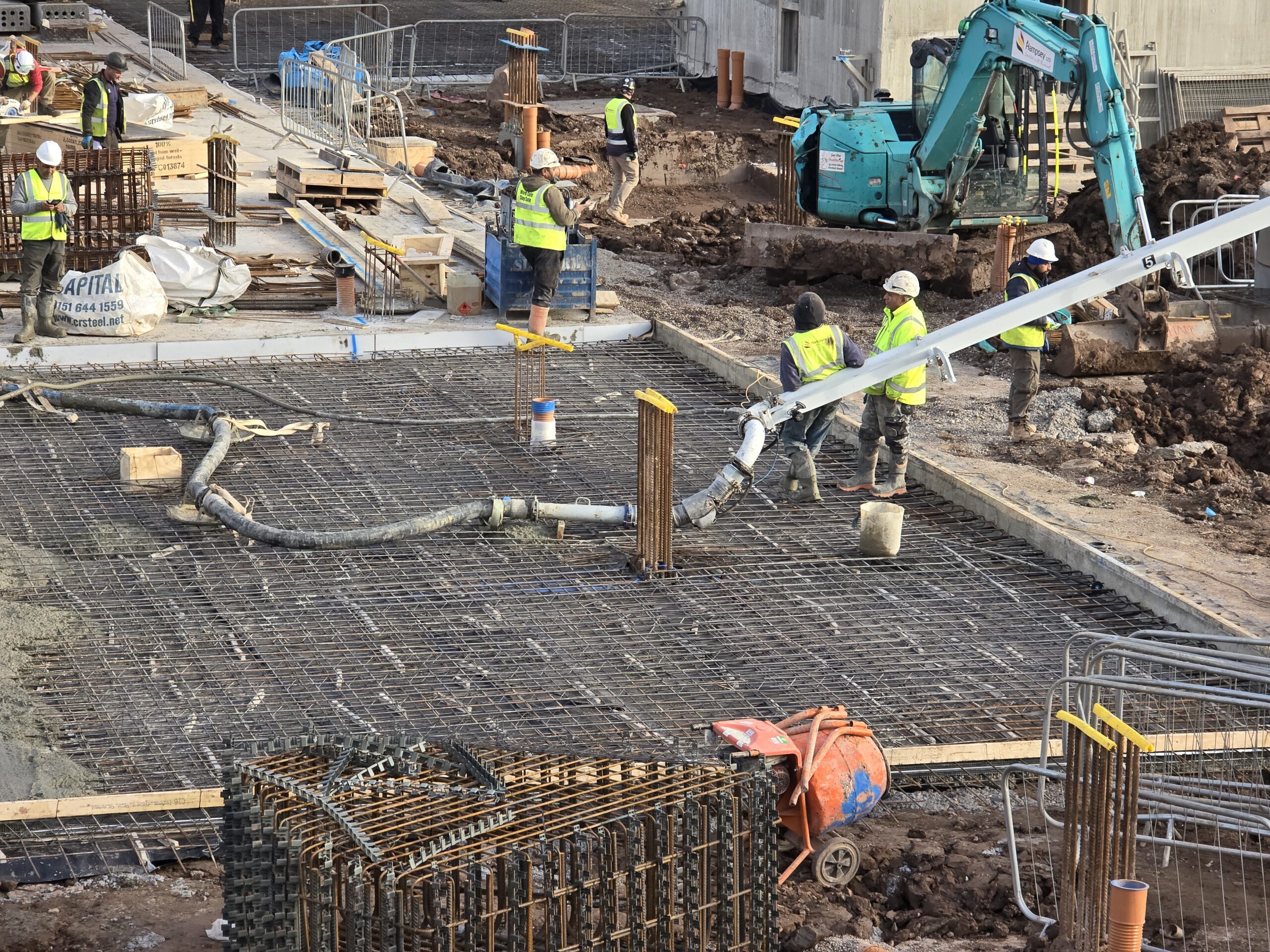

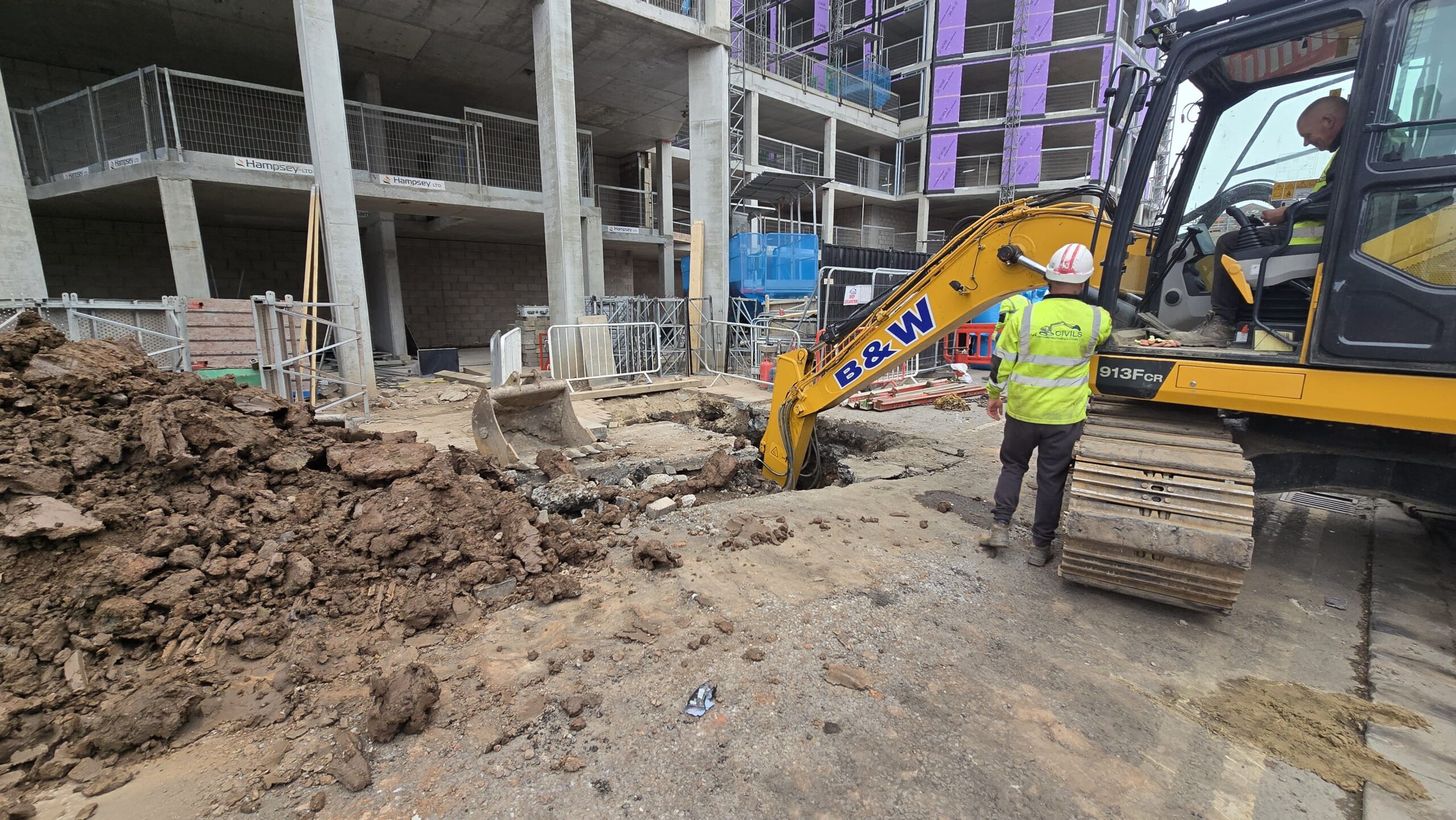

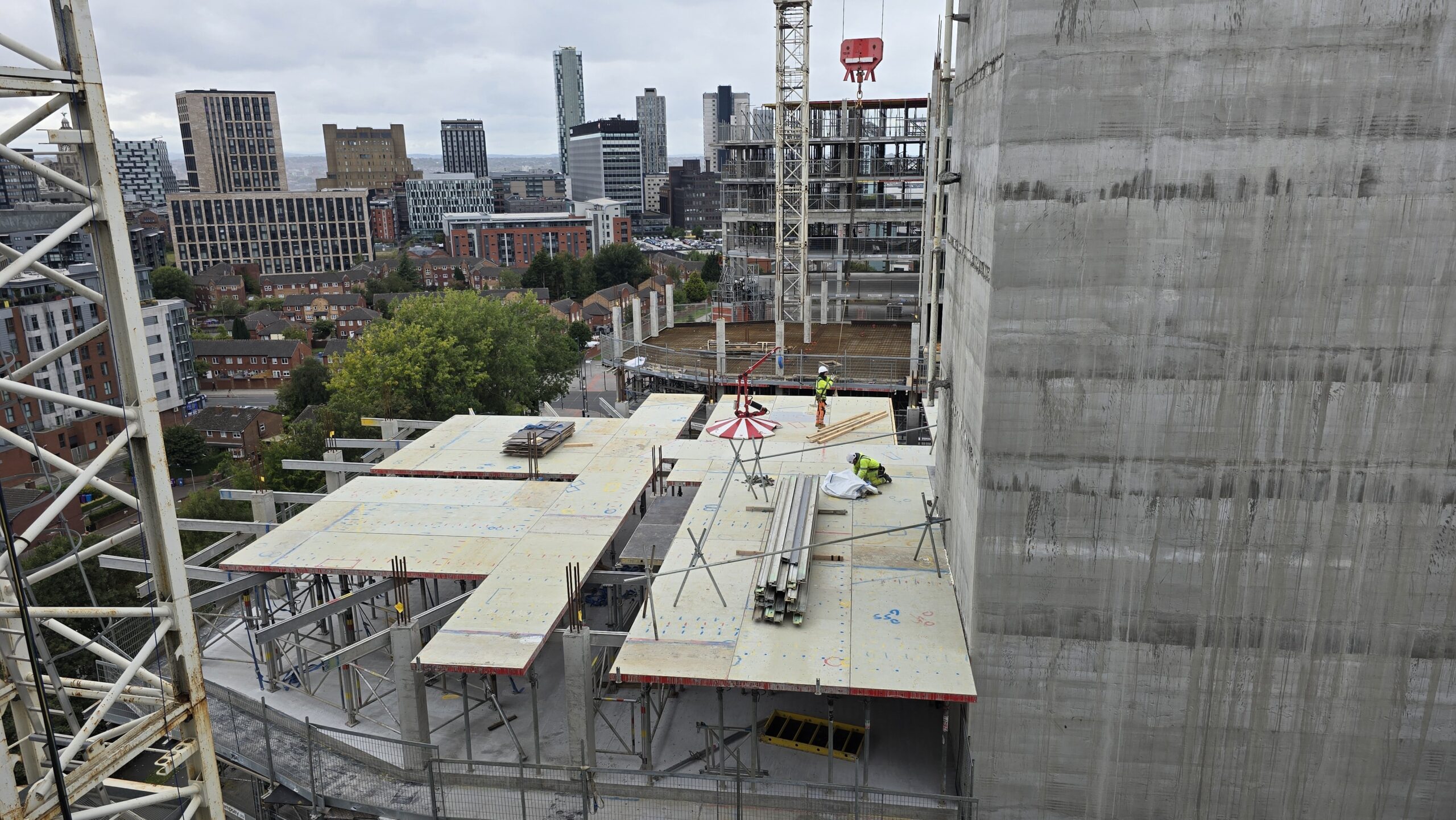

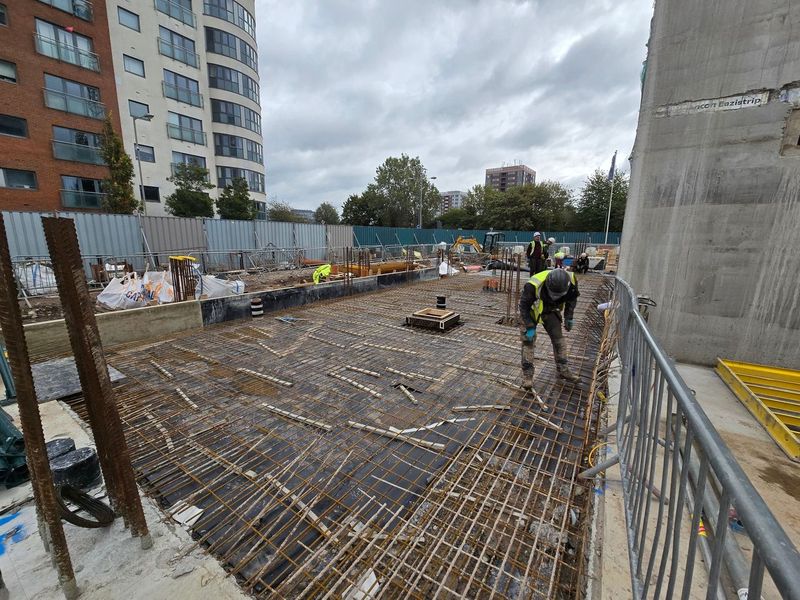

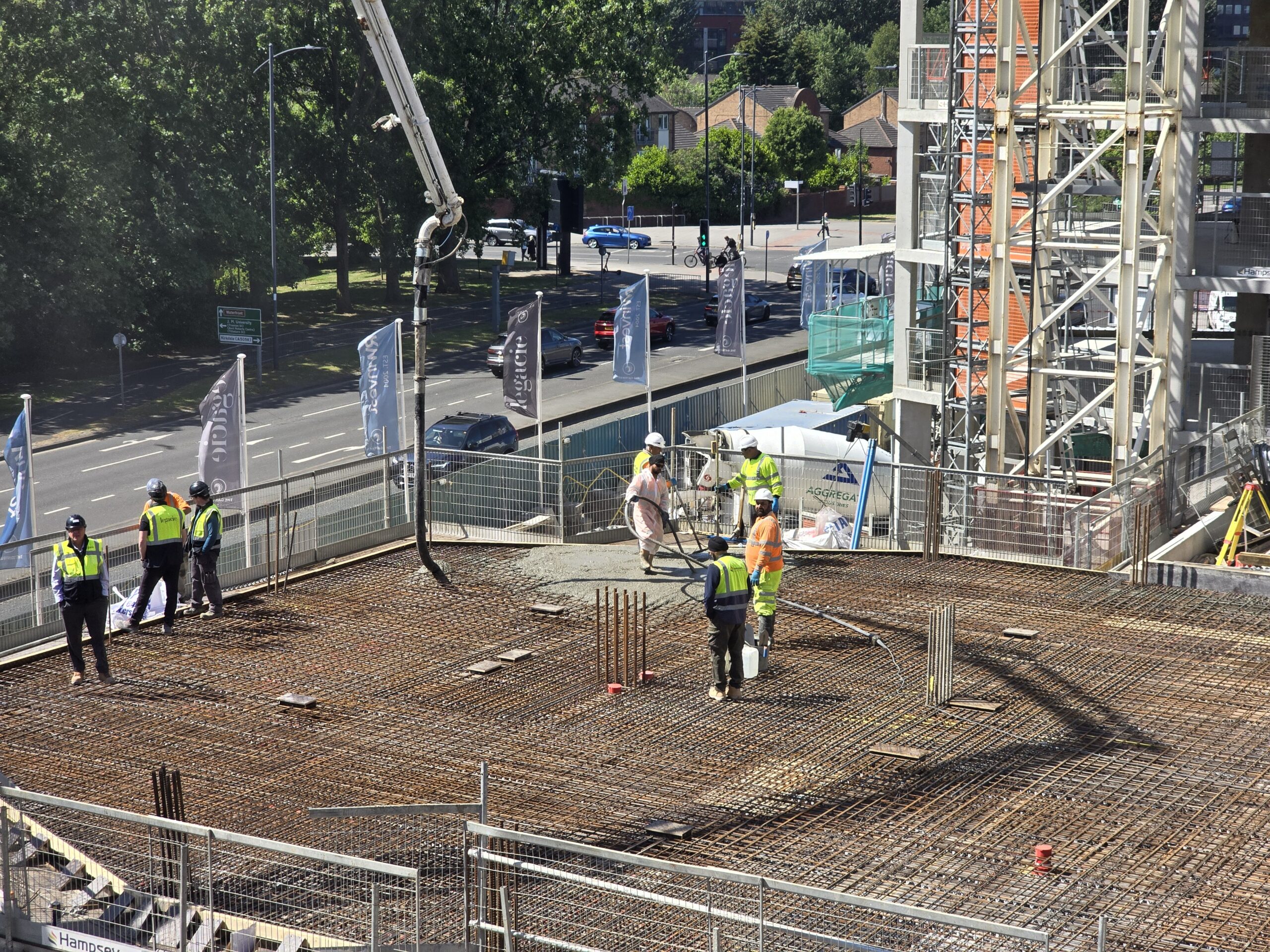

Fantastic progress was made in the opening quarter of 2024 following mobilisation by the developer and groundworks team in the previous period.

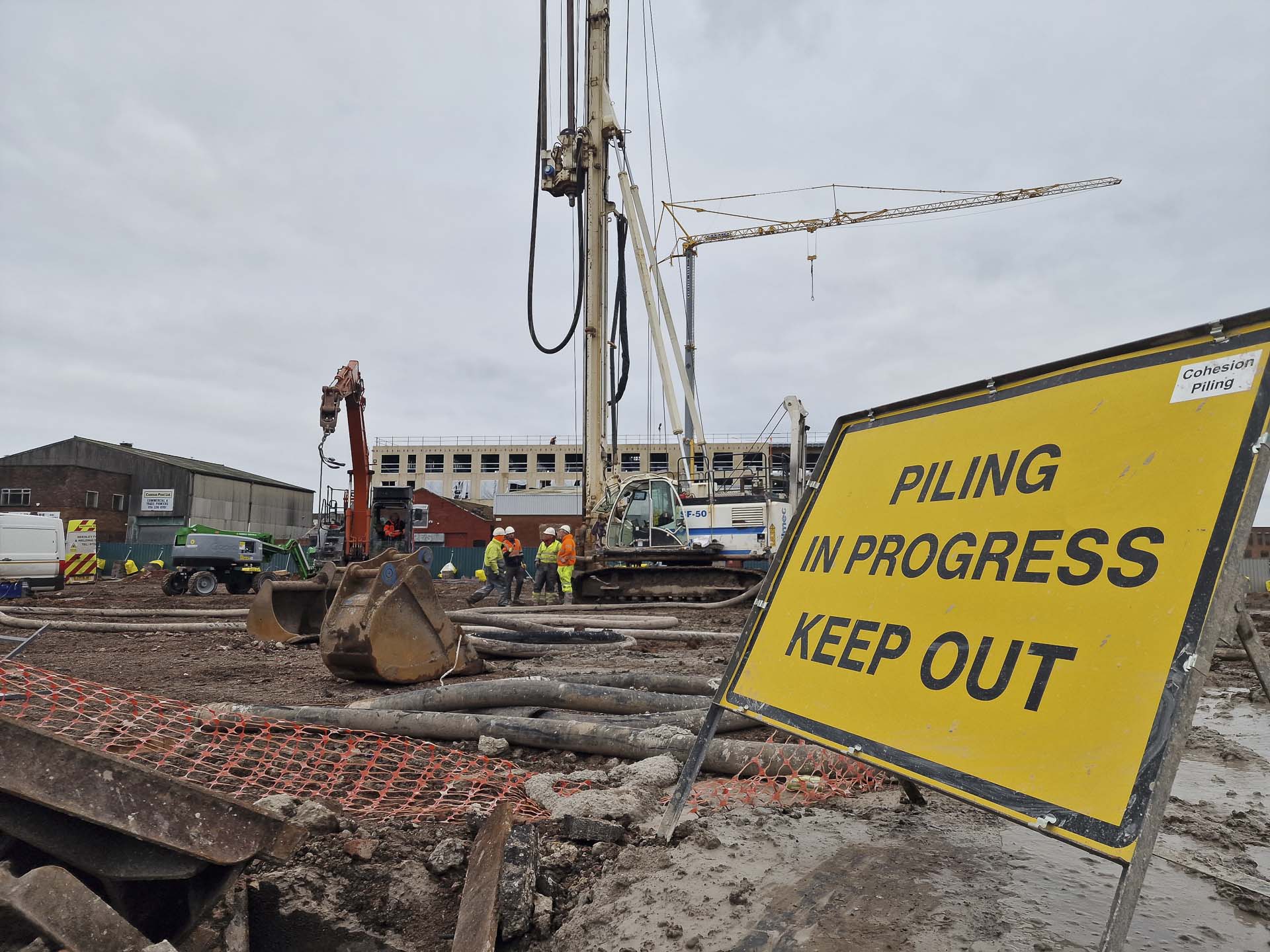

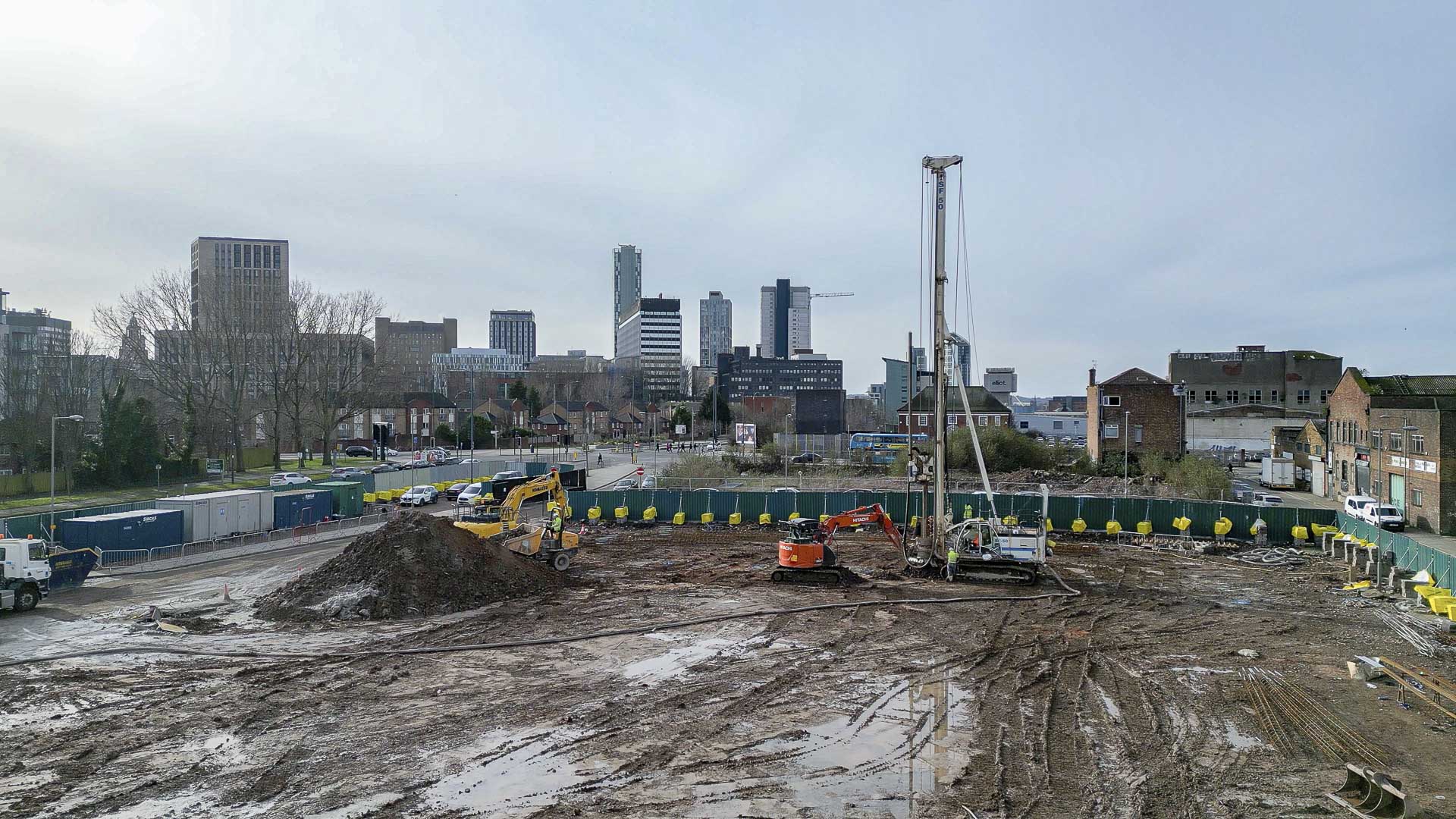

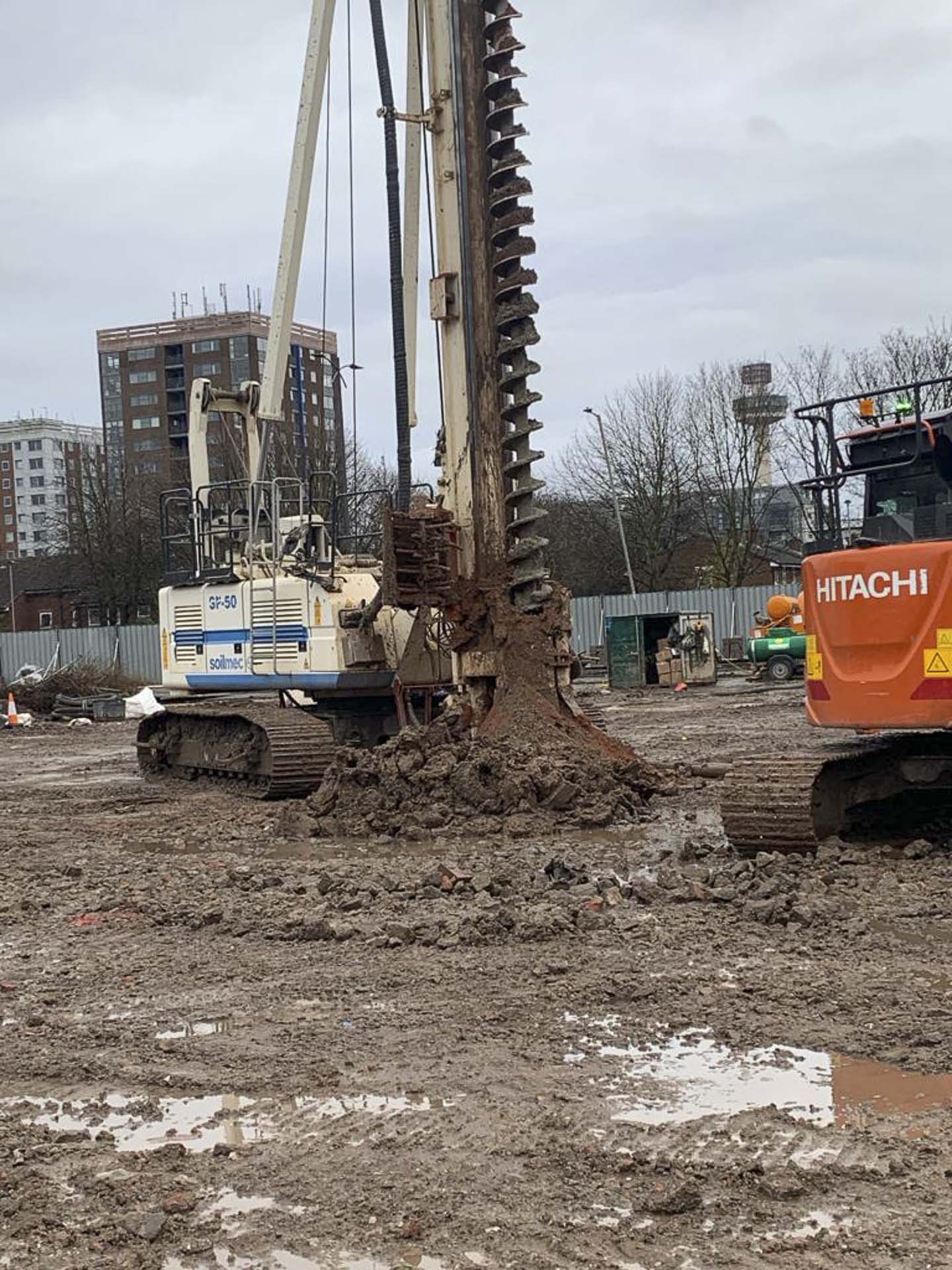

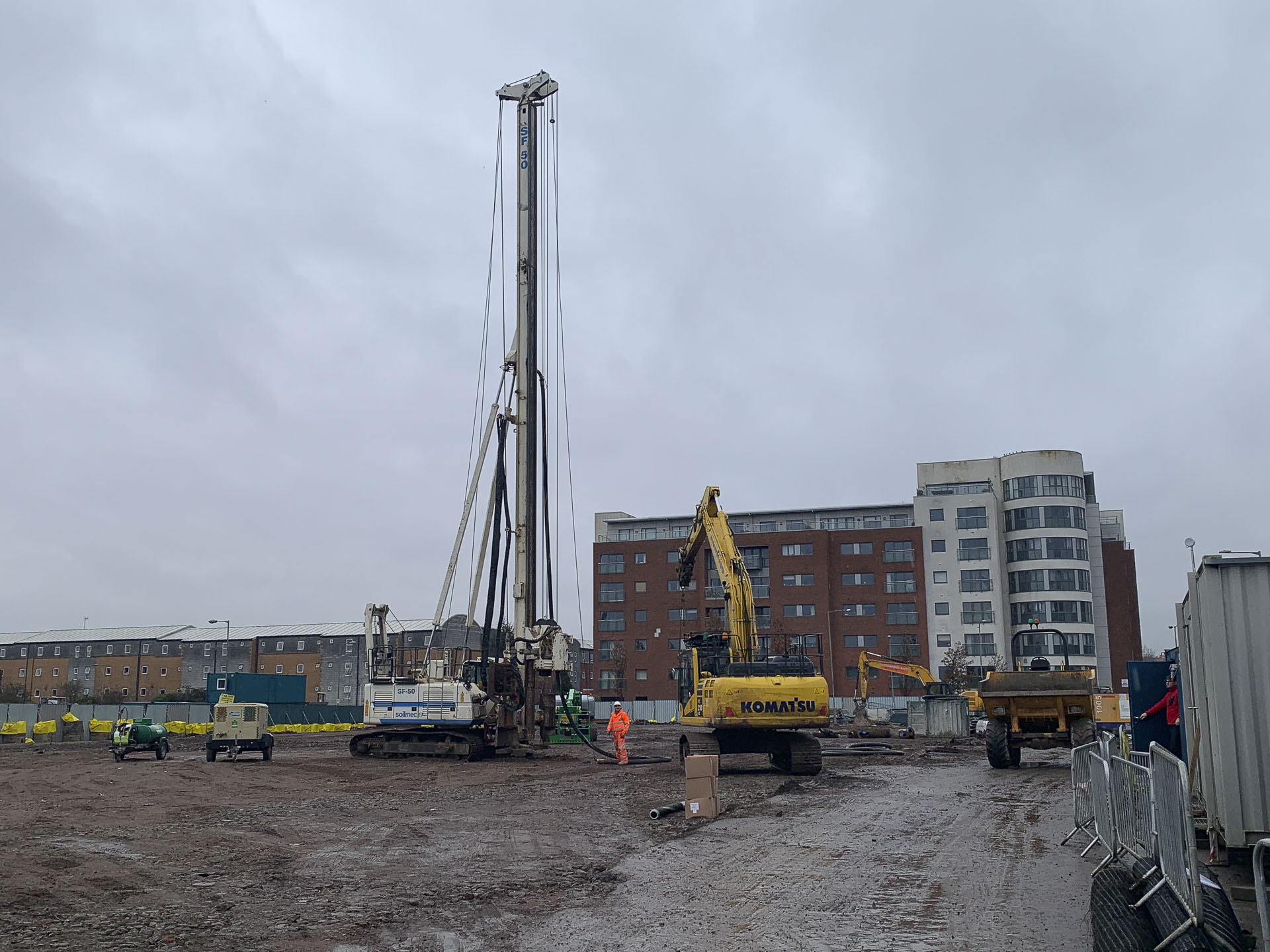

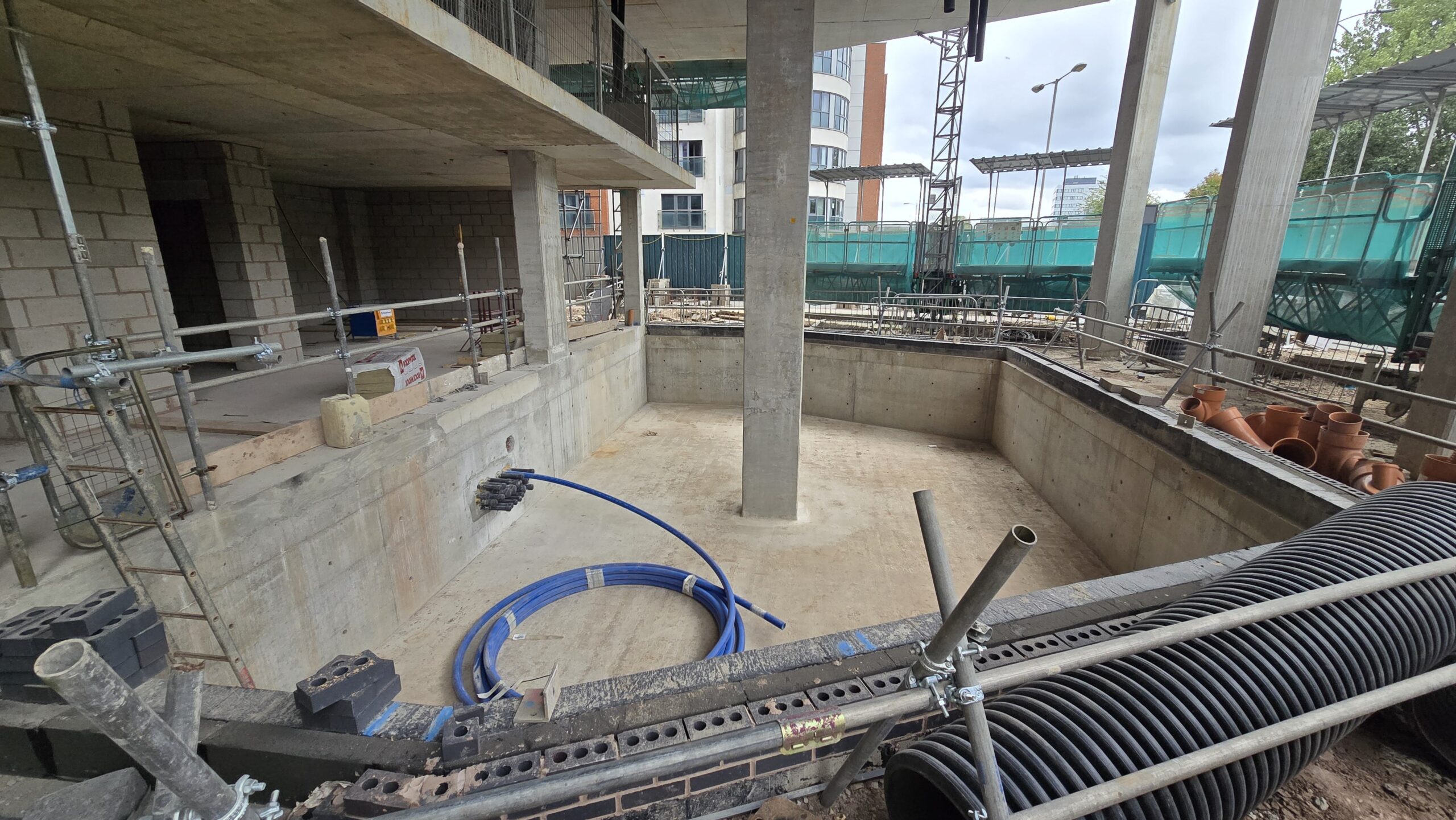

Several milestones have now been surpassed including the completion of the piling mat, water main abandonment and service disconnection. 600 piles were completed in Quarter 1 with progress to continue at a similar pace over the coming months.

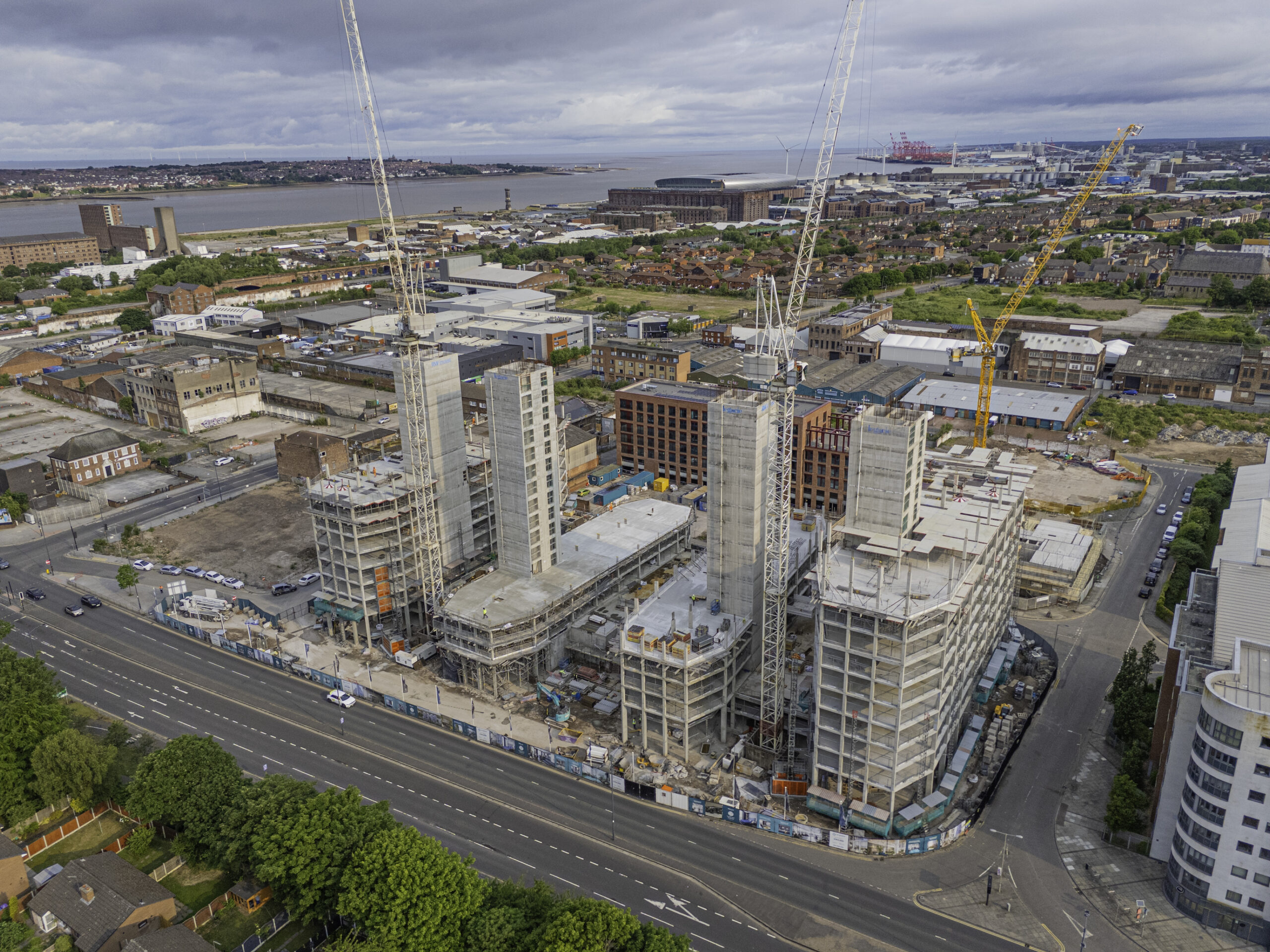

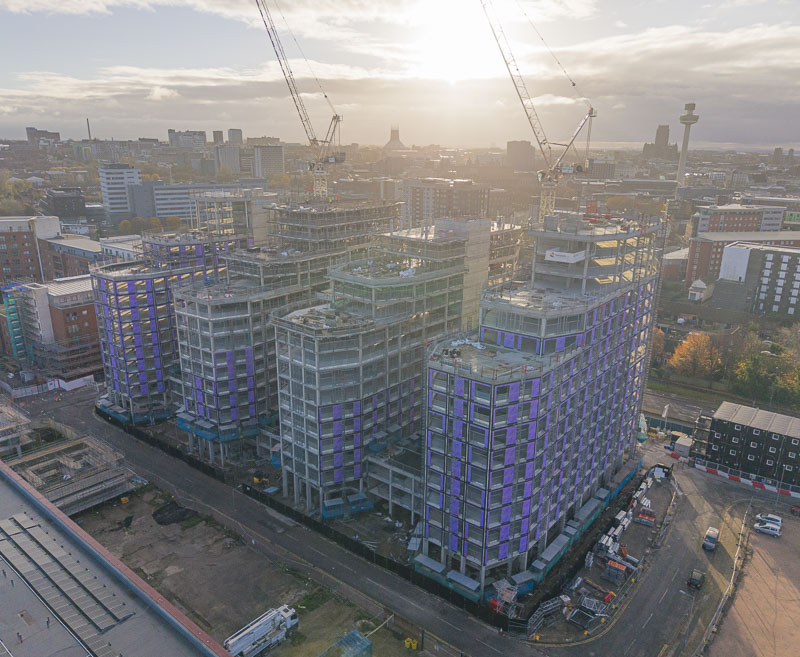

The Gateway - Q1 2024

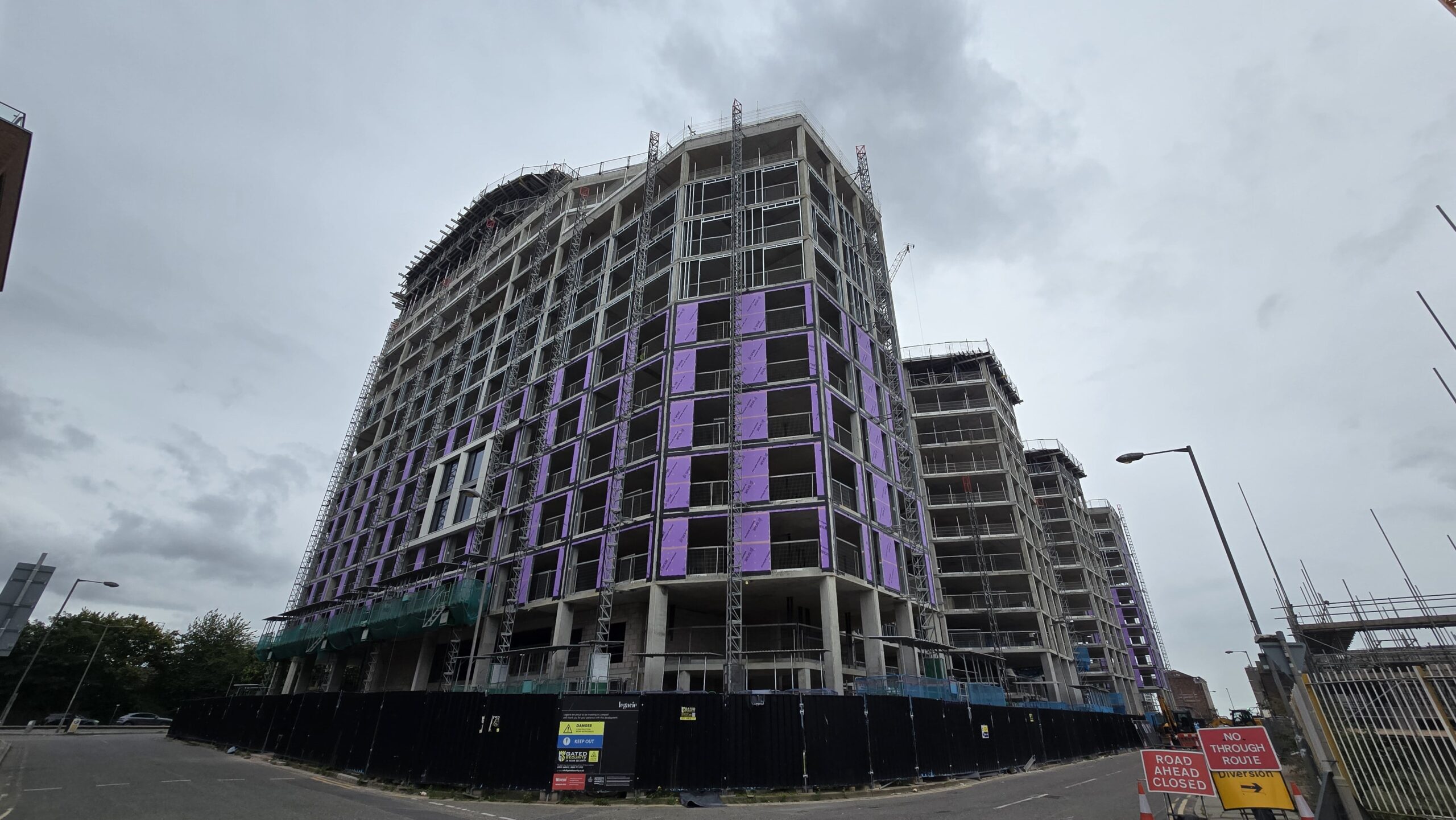

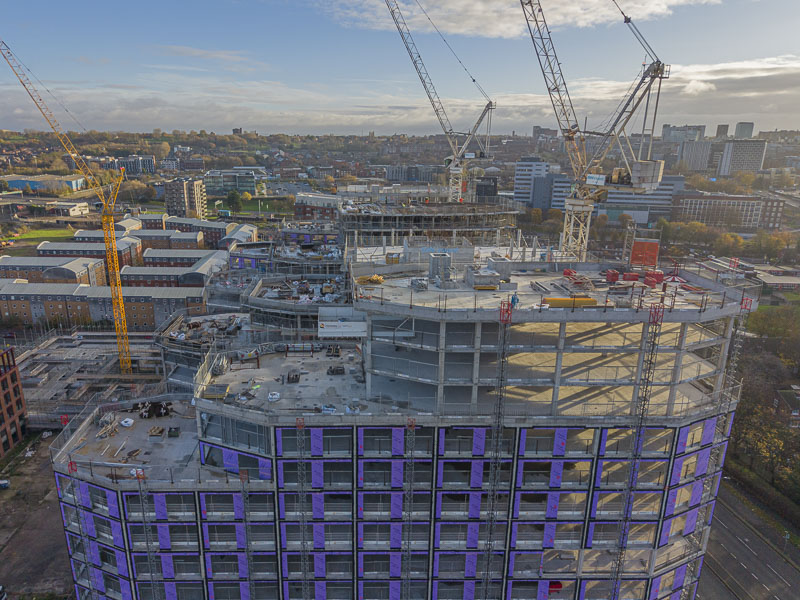

The Gateway - Q1 2024

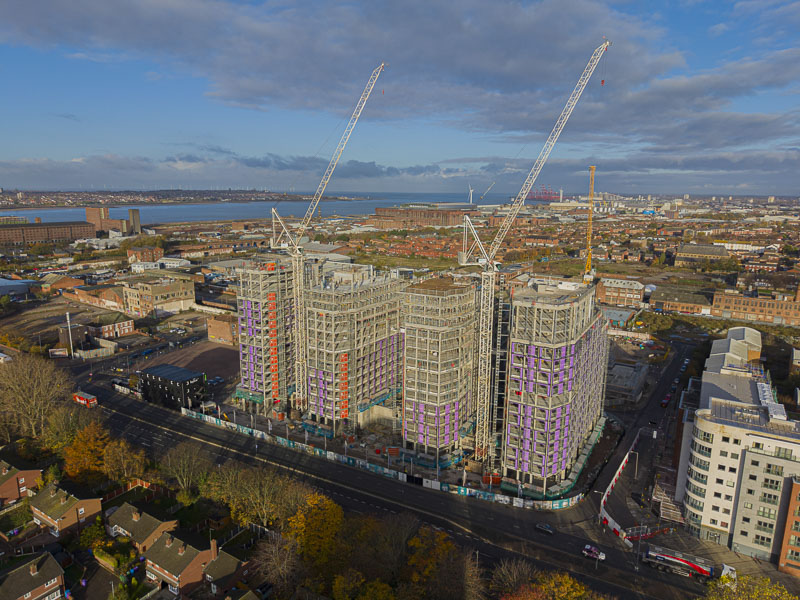

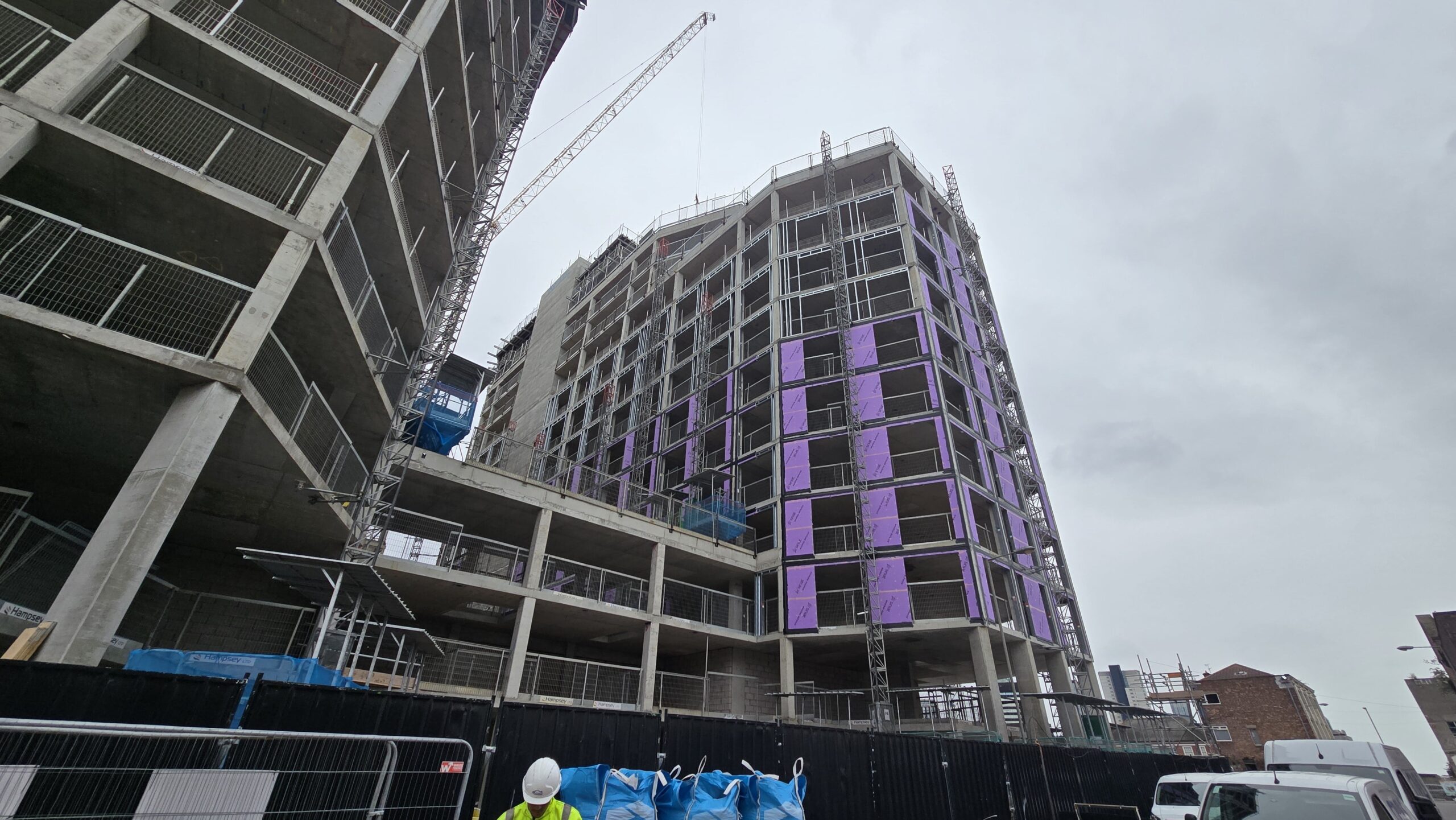

The Gateway - Q1 2024

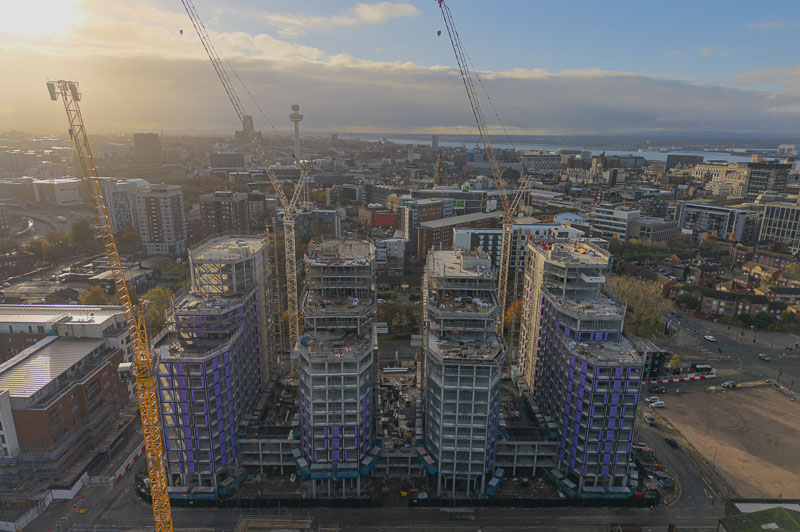

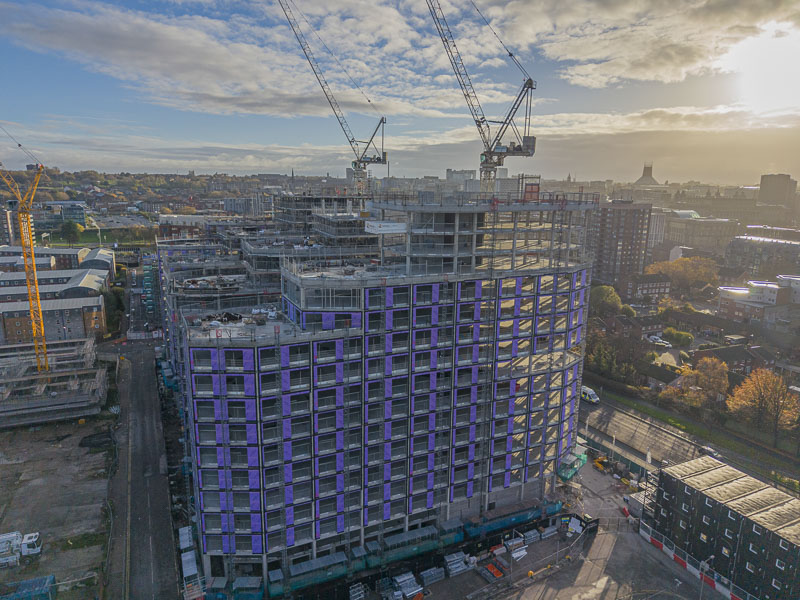

The Gateway - Q1 2024

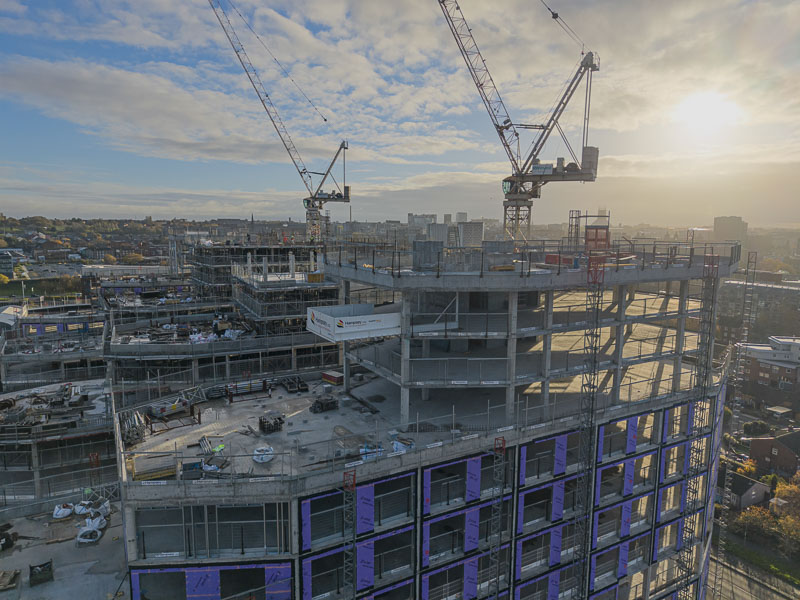

The Gateway - Q1 2024
Arrow left
Arrow right

Just 23-Mins from Central London

Premium London Commuter Belt apartments are securable for just £51,442, thanks to a new payment structure just agreed with the developer!

Q4 2023 Update

October, November & December Construction Progress

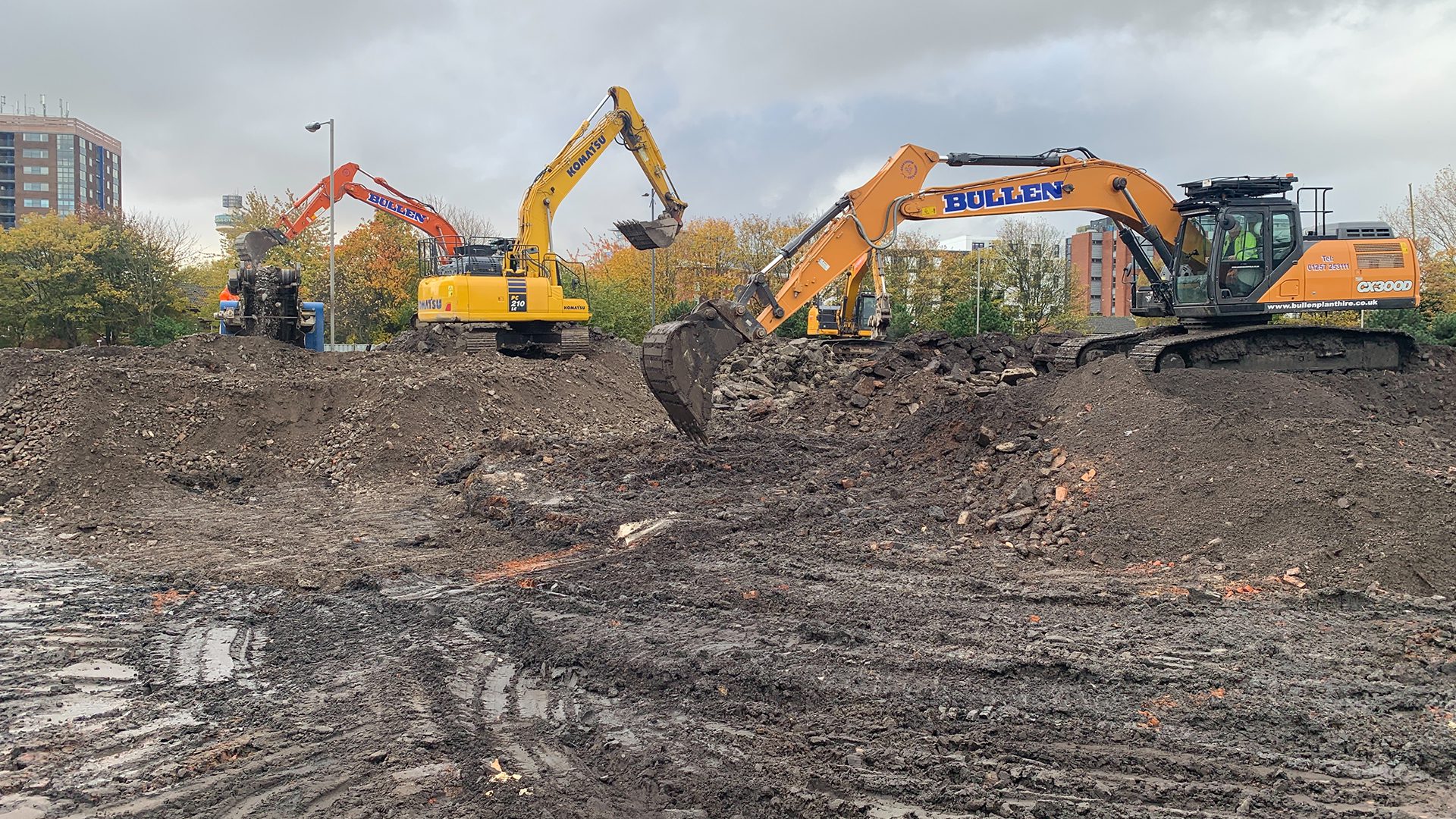

Q4 2023

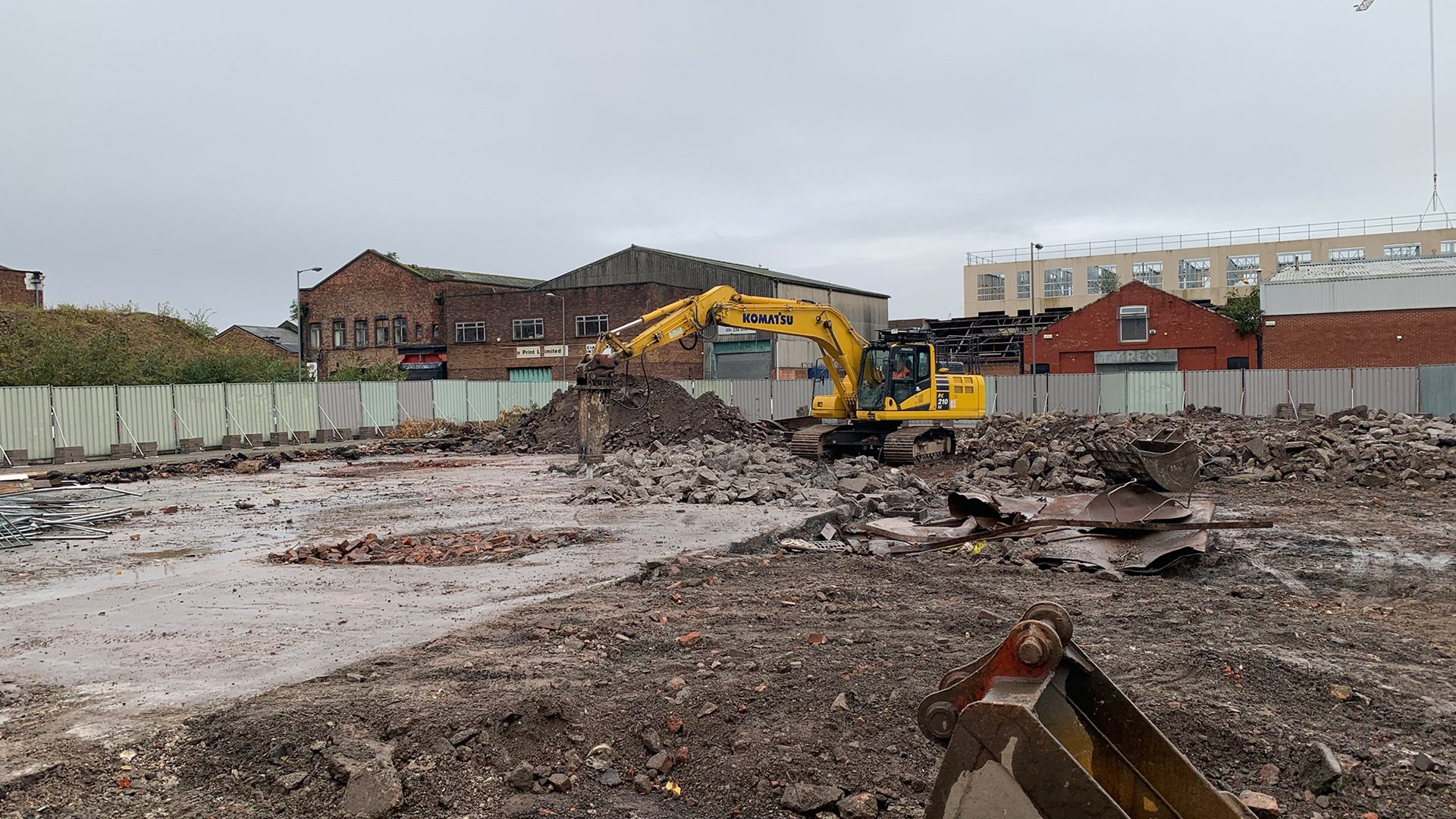

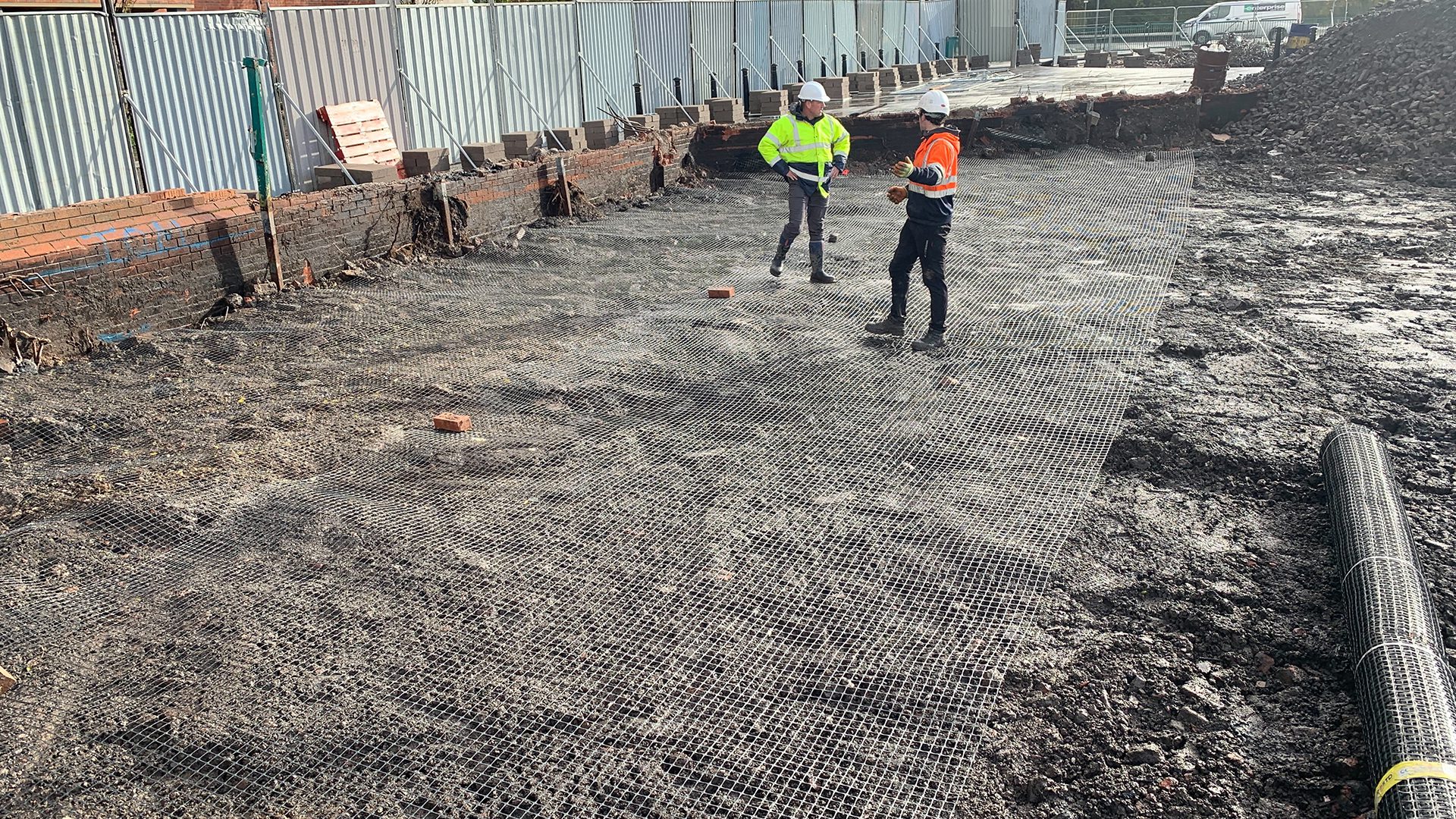

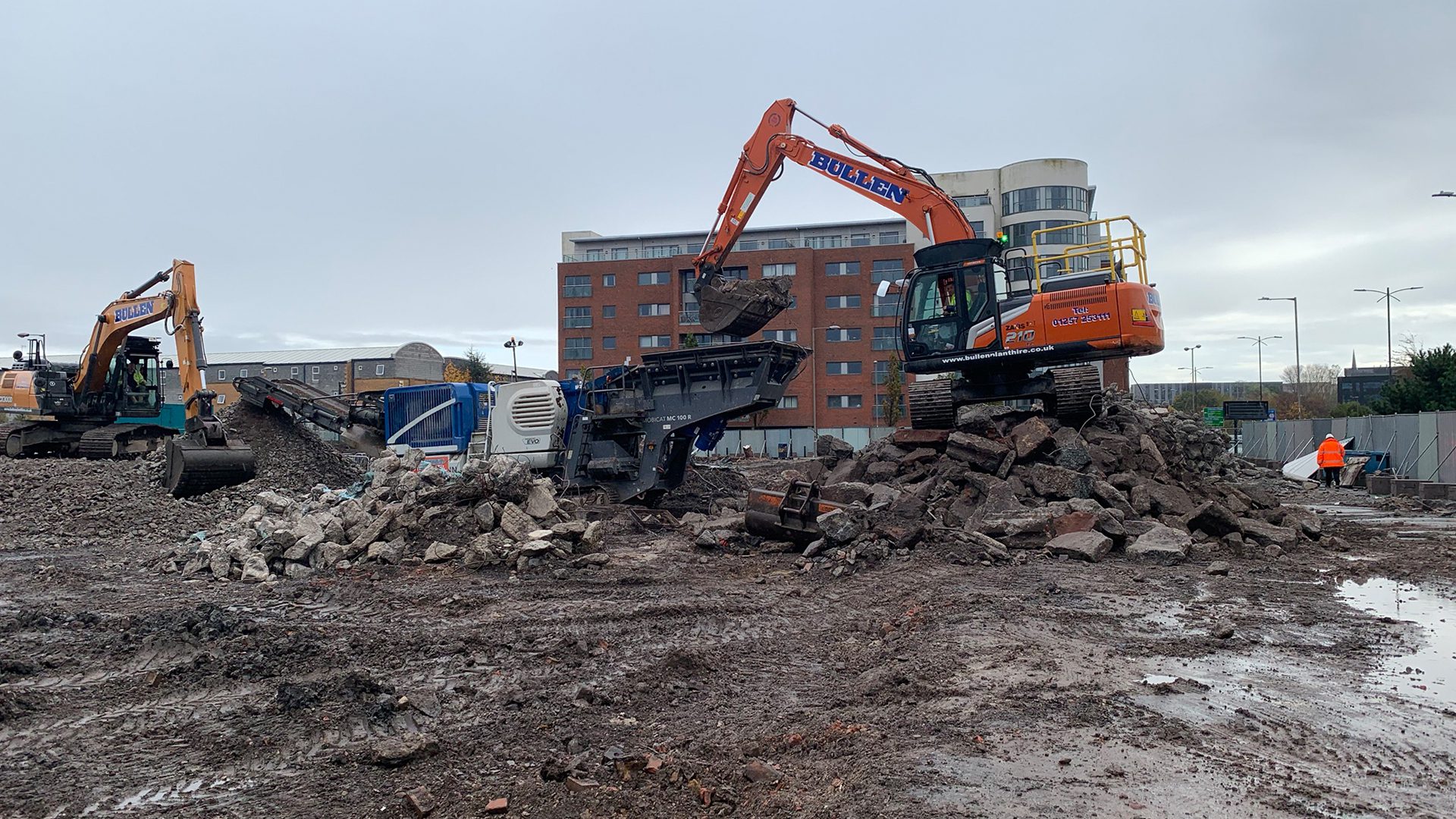

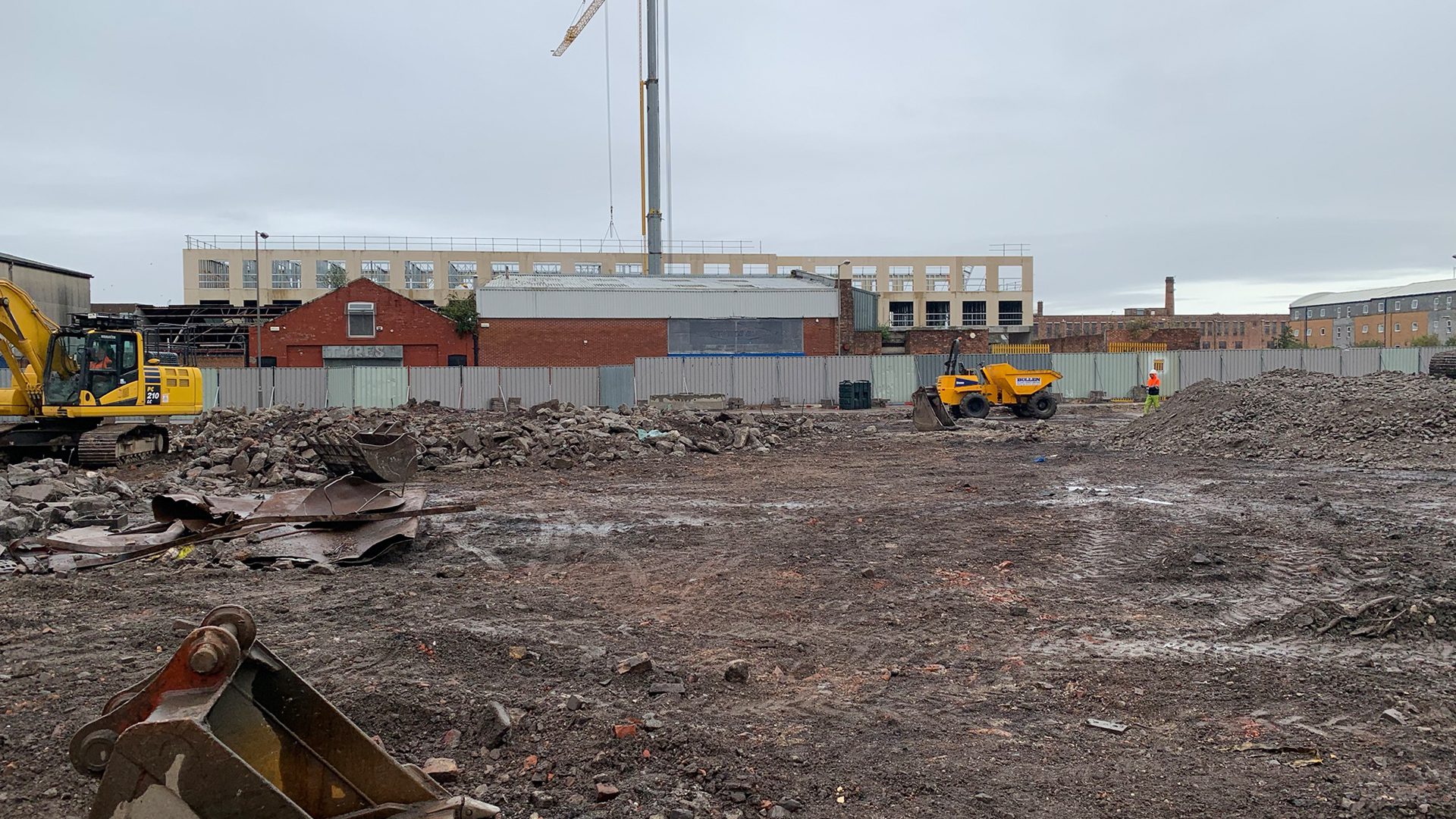

In the final quarter of 2023, several key advancements were made at The Gateway as preparation for onsite mobilisation continued. Site cabins were delivered and piling works continued in preparation for the piling rig. The disconnection of services and the continuation of piling works will be a focus for the site team over the coming months.

Arrow left
Arrow right

Just 23-Mins from Central London

Premium London Commuter Belt apartments are securable for just £51,442, thanks to a new payment structure just agreed with the developer!

Q3 2023 Update

July, August & September Construction Progress

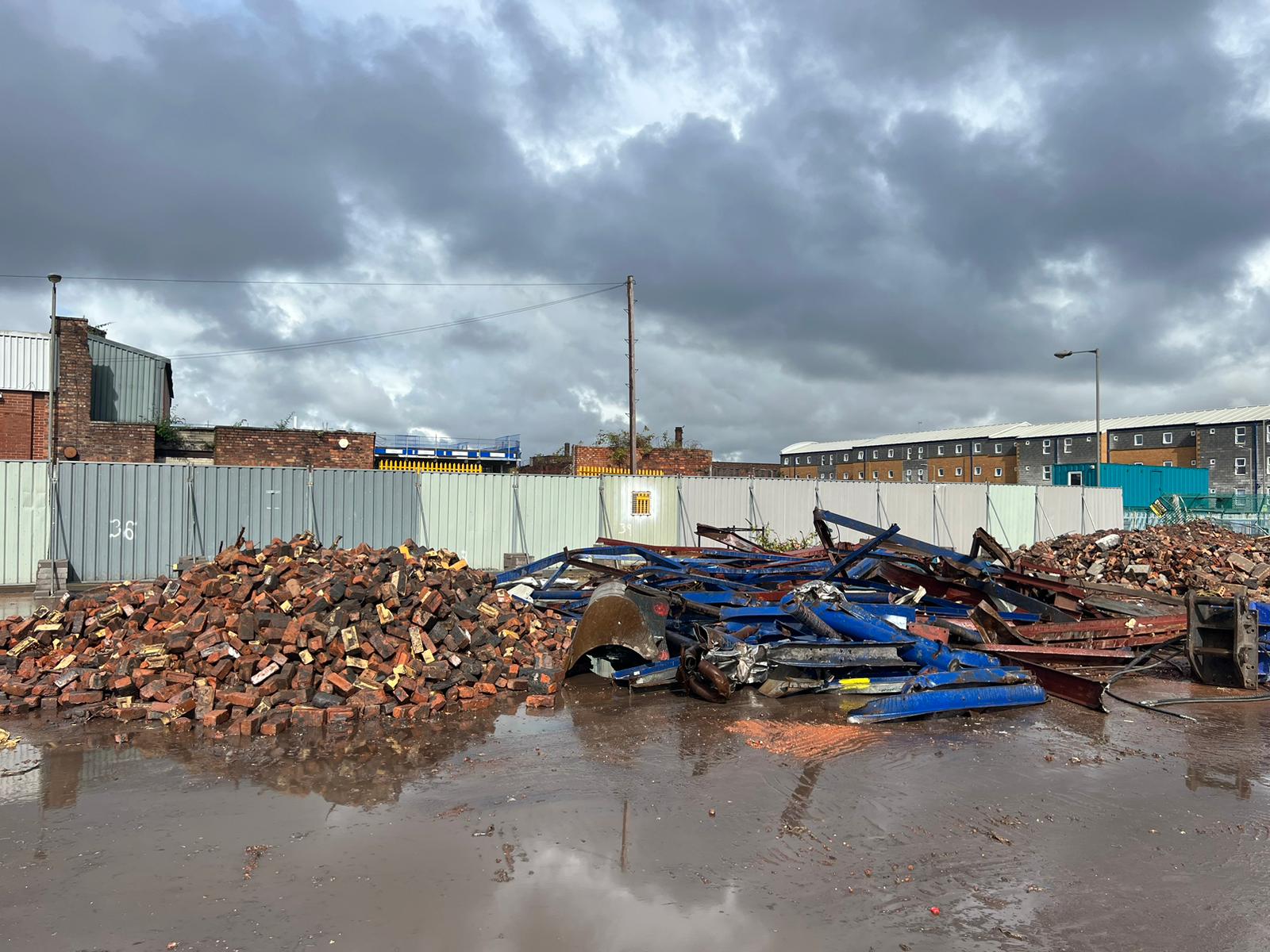

Q3 2023

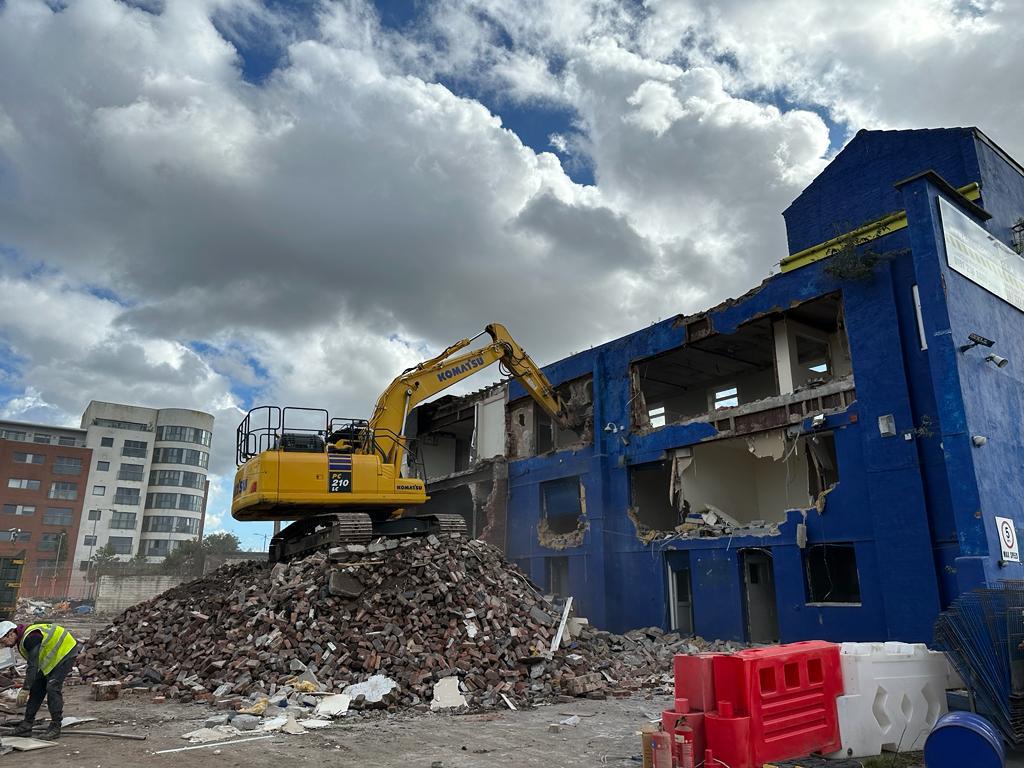

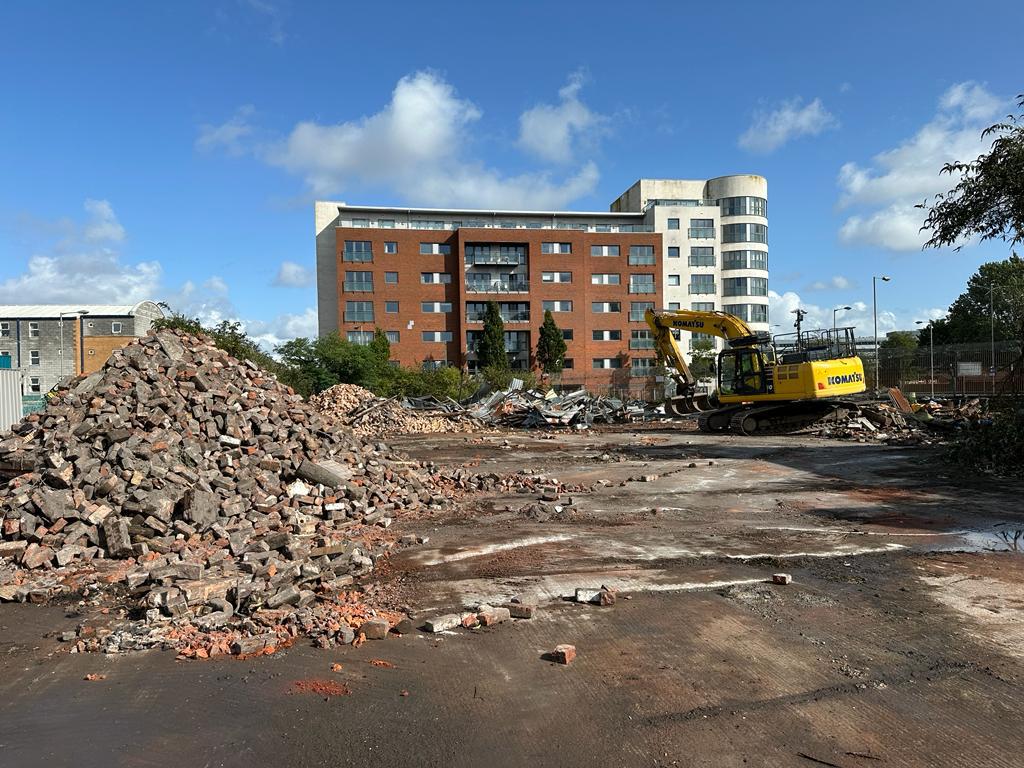

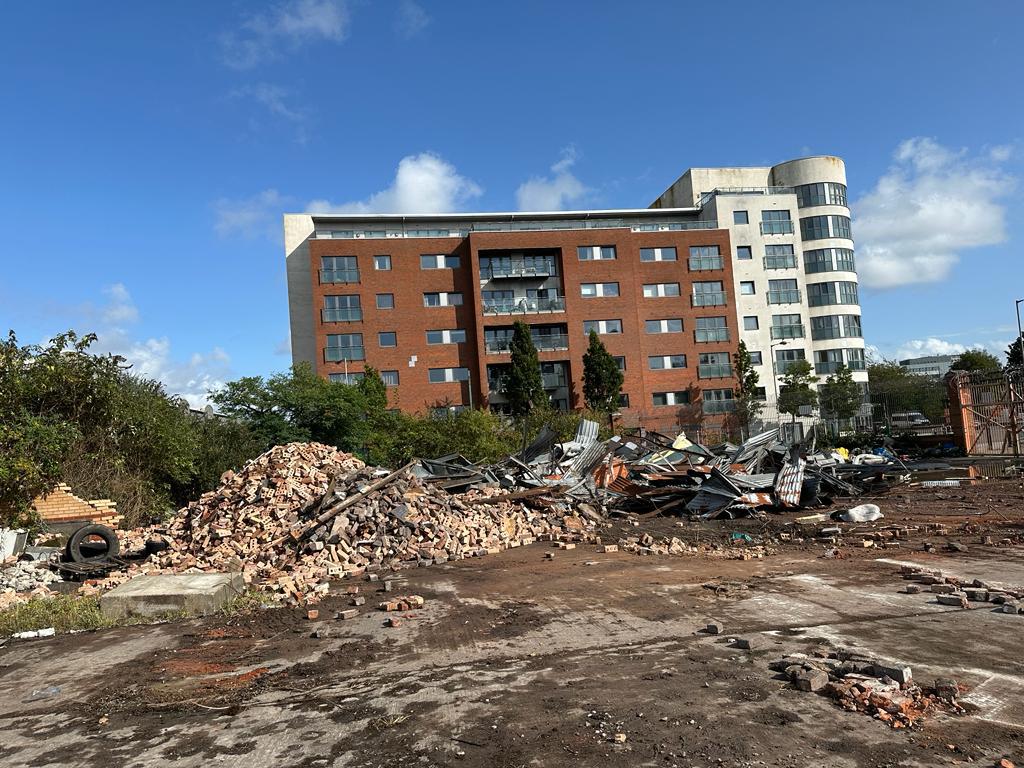

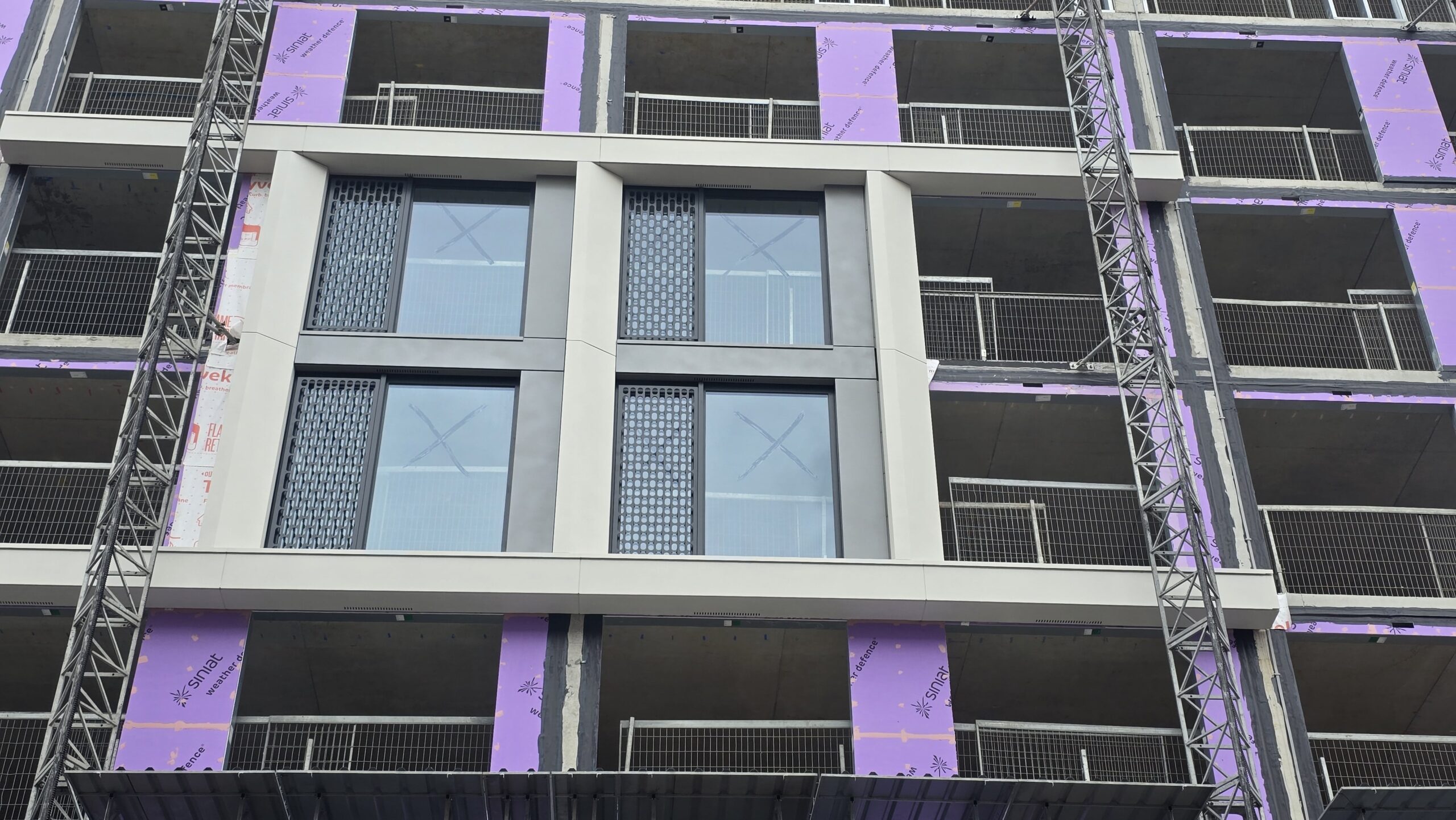

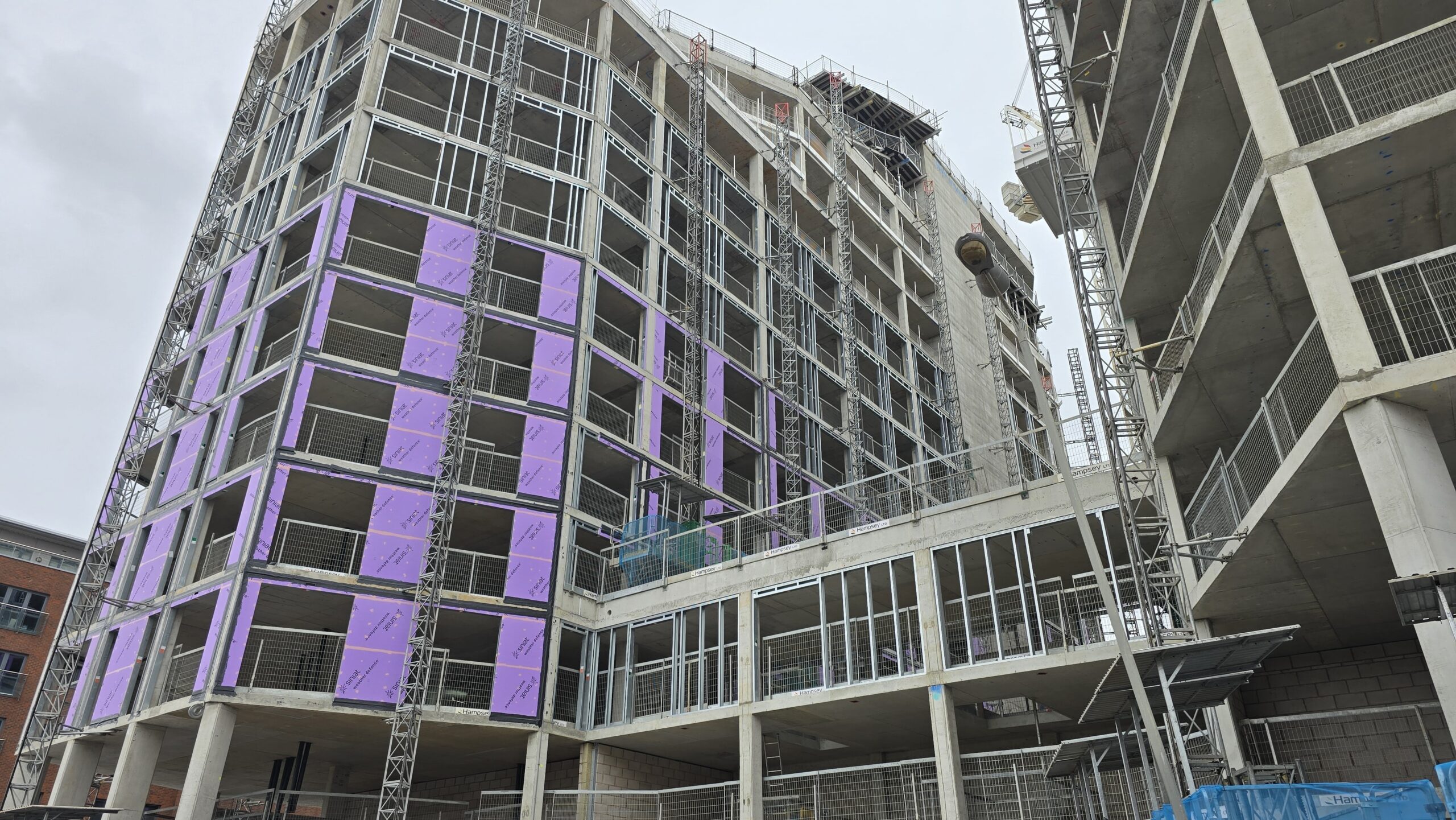

September brought with it a major milestone with the commencement of onsite works at The Gateway. This included the initial demolition of existing buildings and site clearance, as technical meetings between the main contractor and all consultants remain ongoing.

Final works also took place for the RIBA Stage 4 design as the structural engineer continued to review the frame and groundwork across the site.

The Gateway
The Gateway
The Gateway
The Gateway
The Gateway
Arrow left
Arrow right

Looking for a Stress-Free Investment?

Secure a 2-bed townhouse for just £35,495, with nothing to pay until next year!

Why Choose RWinvest?

Here are three reasons to choose RWinvest for your next UK property investment.

We have over 2,000 five-star Trustpilot reviews

Multiple Award Icon

We're a multi-award winning investment company

We offer investments in the best buy to let areas

Arrow left
Arrow right

Contact Us

Want to Get in Touch?

Fill in the form to contact us today and a member of our award-winning property team will be in touch to help.

    Customer Review Customer Review
    trustpilot google
    Liverpool
