Spanning four residential towers in the UK’s largest regeneration zone, The Gateway is an exciting new-build development offering a five-star living experience. Accompanying a range of high-end apartments are unrivalled onsite amenities such as a serene wellness spa, private dining area and fully fitted podcasting studio.
Latest Update
Q1 2026 Update

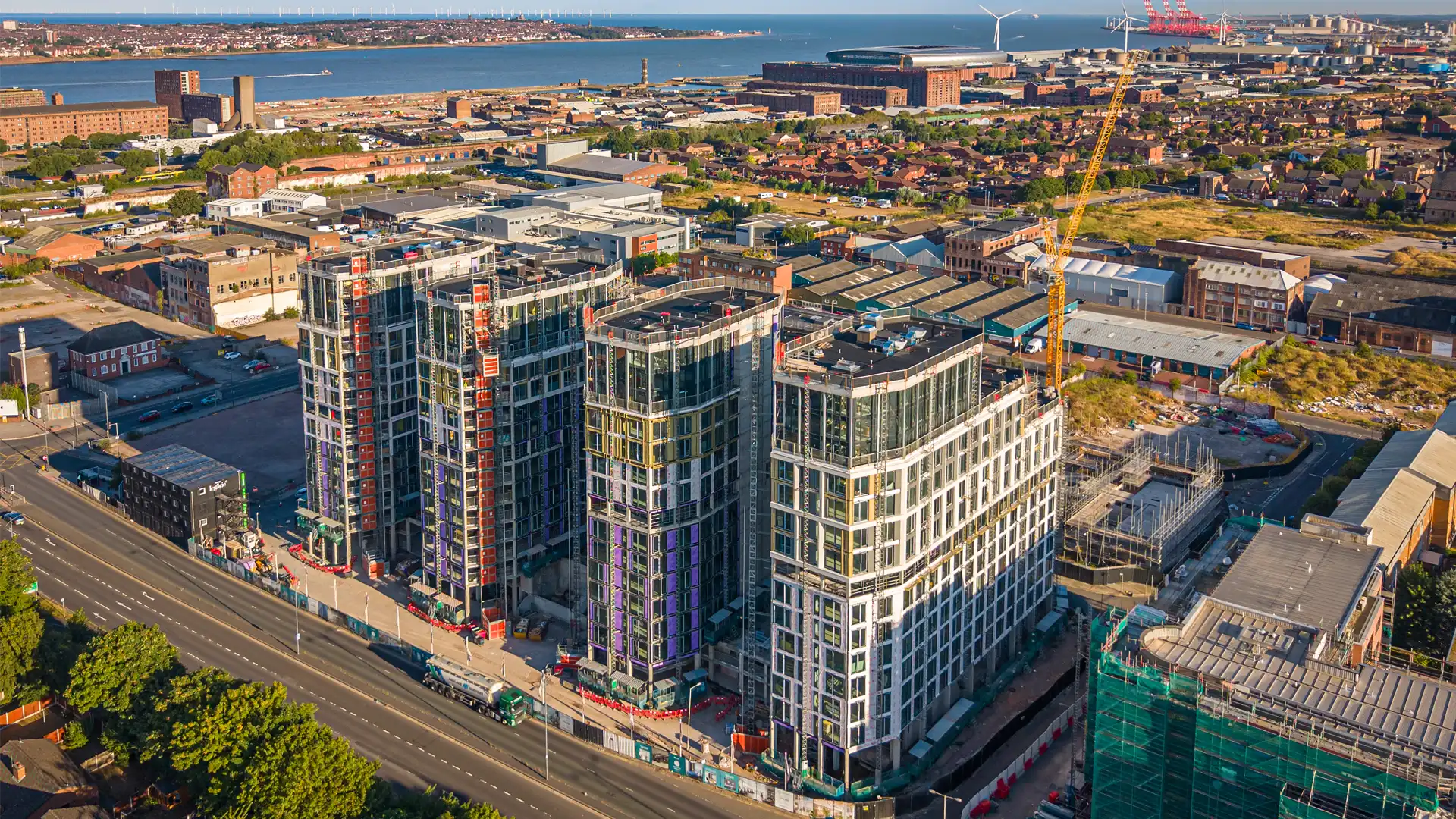

The Gateway, Construction Update – Q1 2026
Key Work Updates

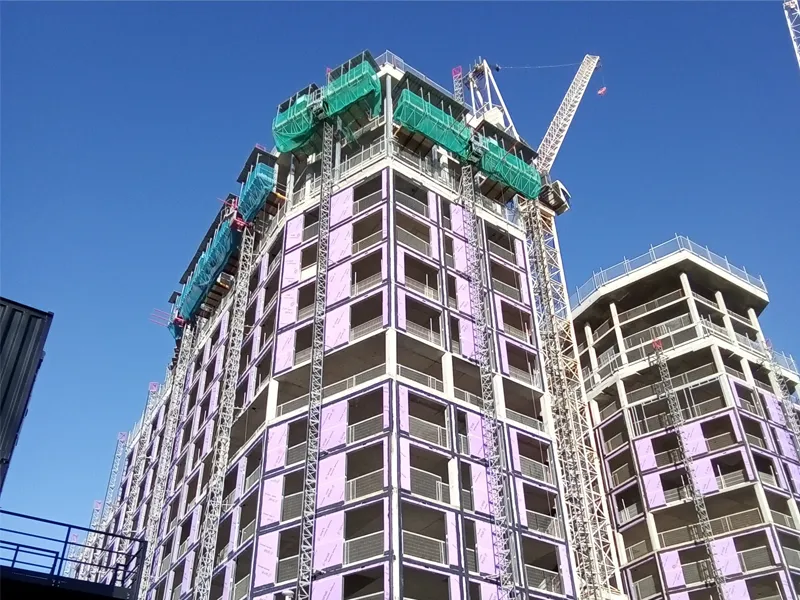

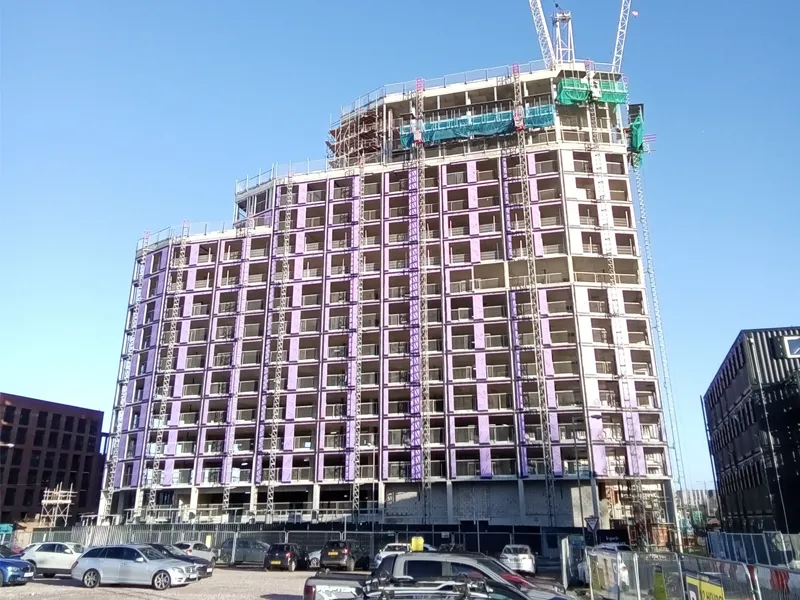

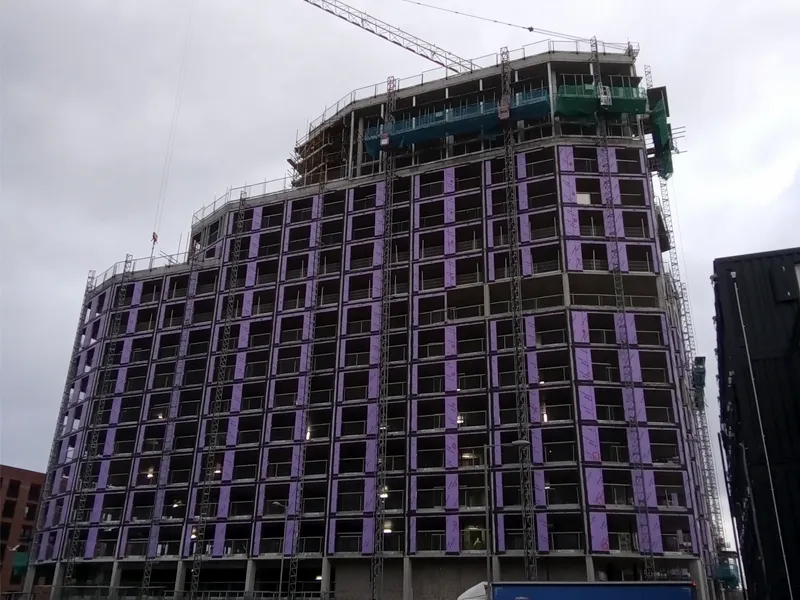

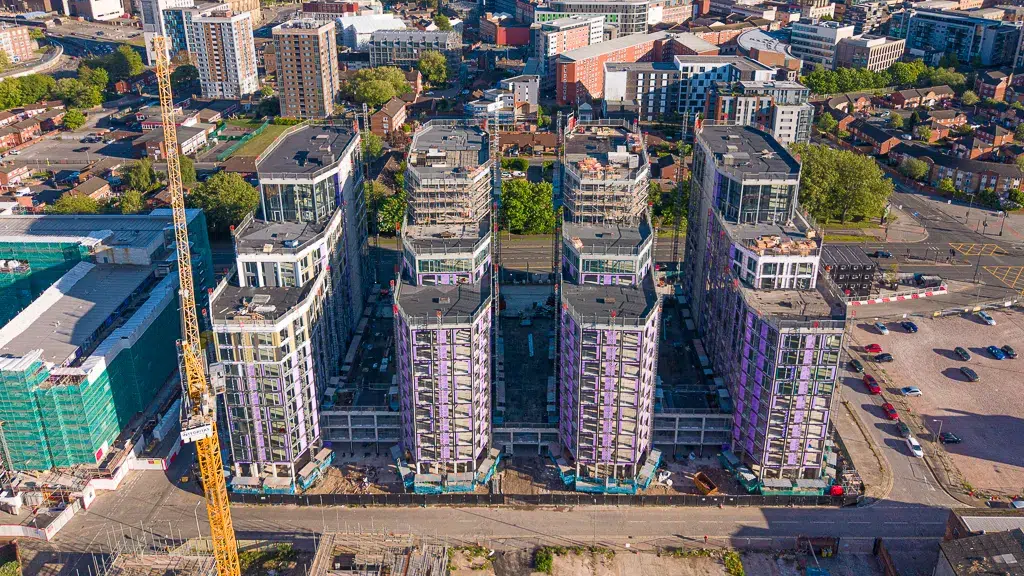

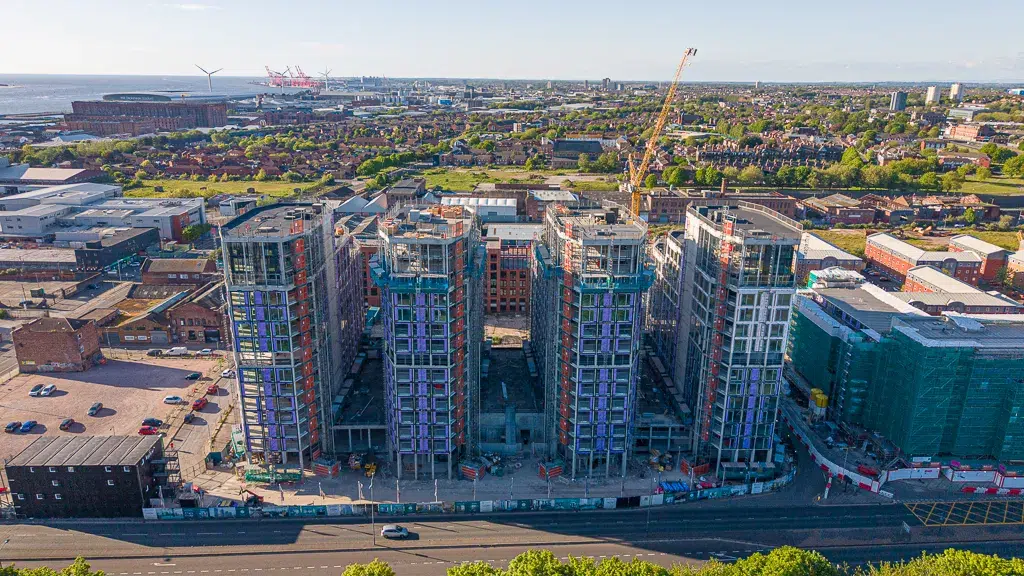

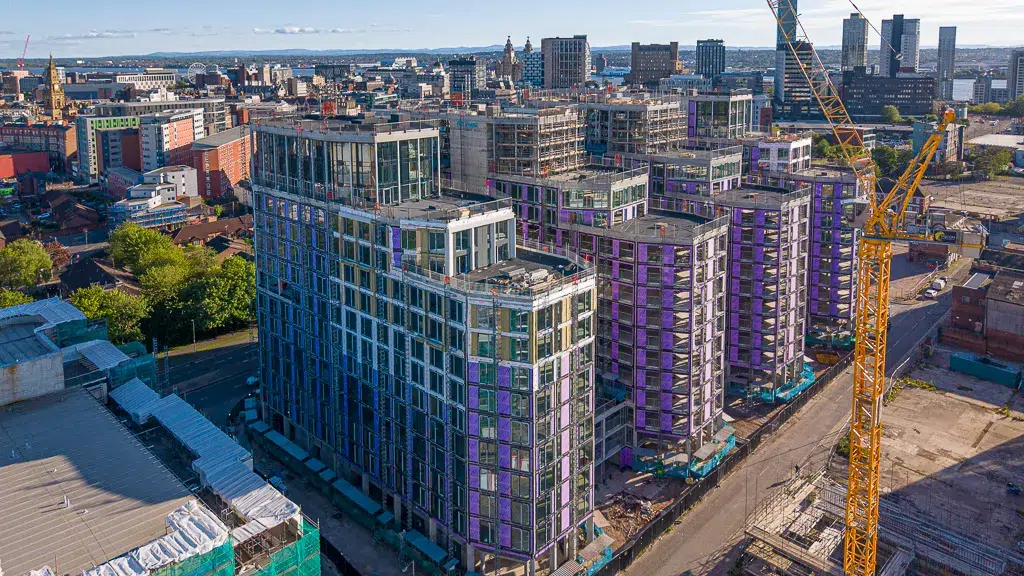

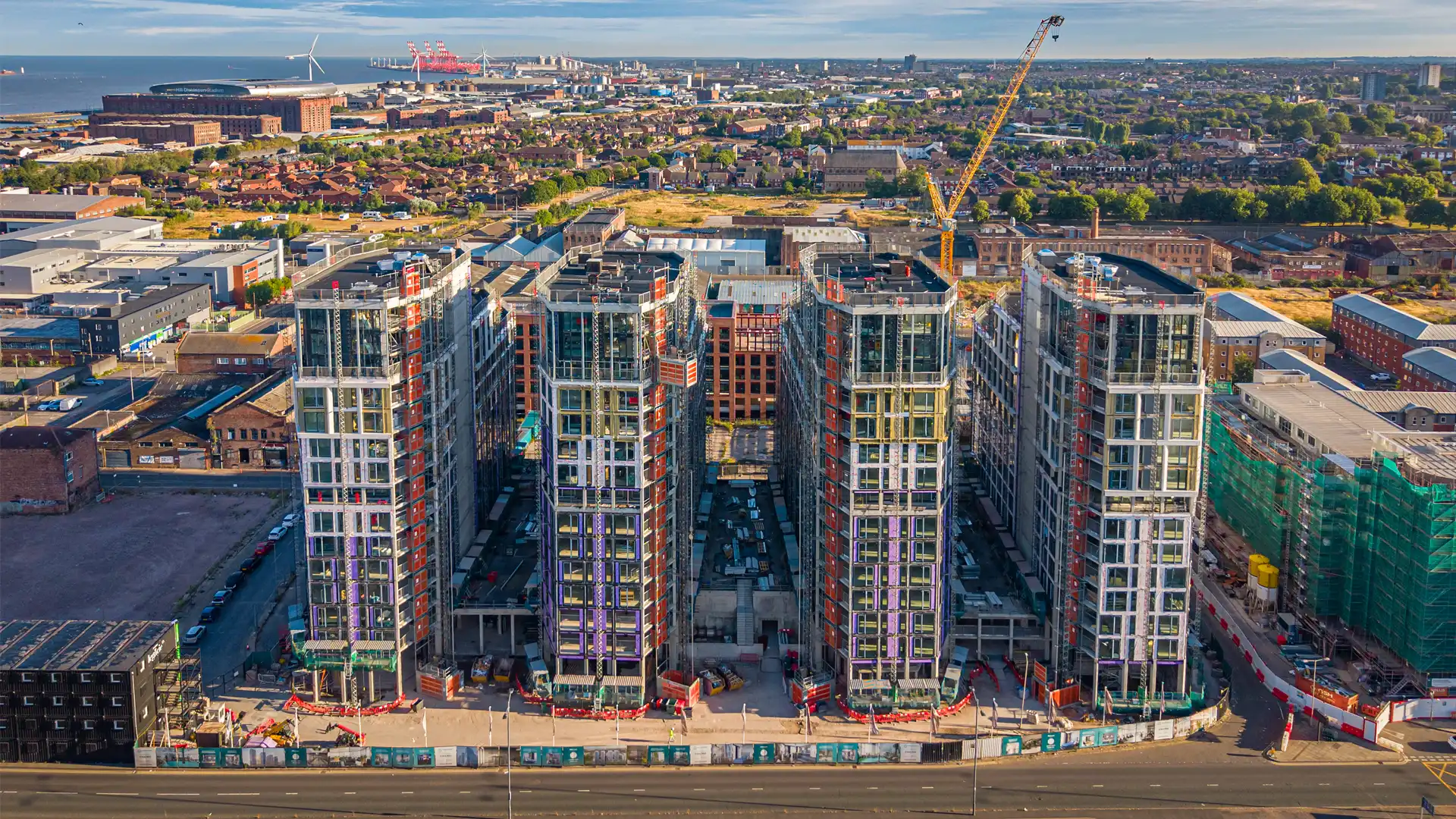

- Structural Framing System Complete

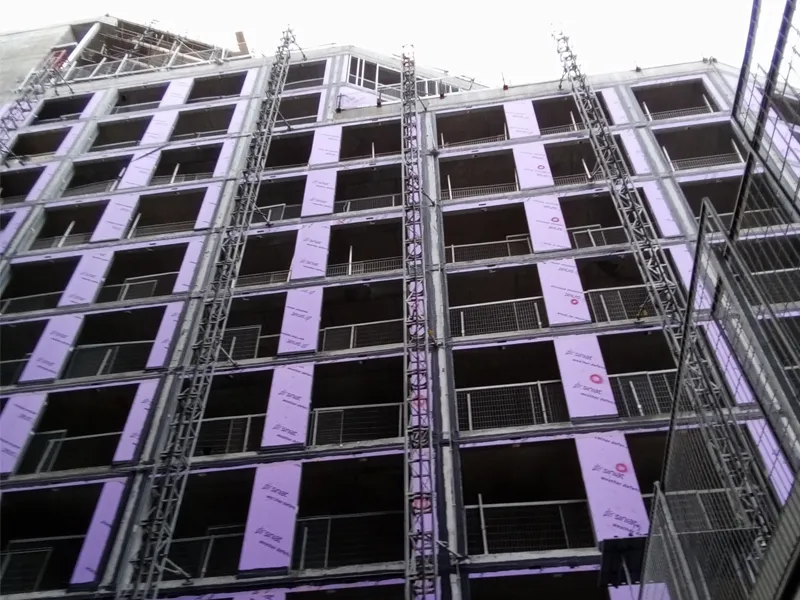

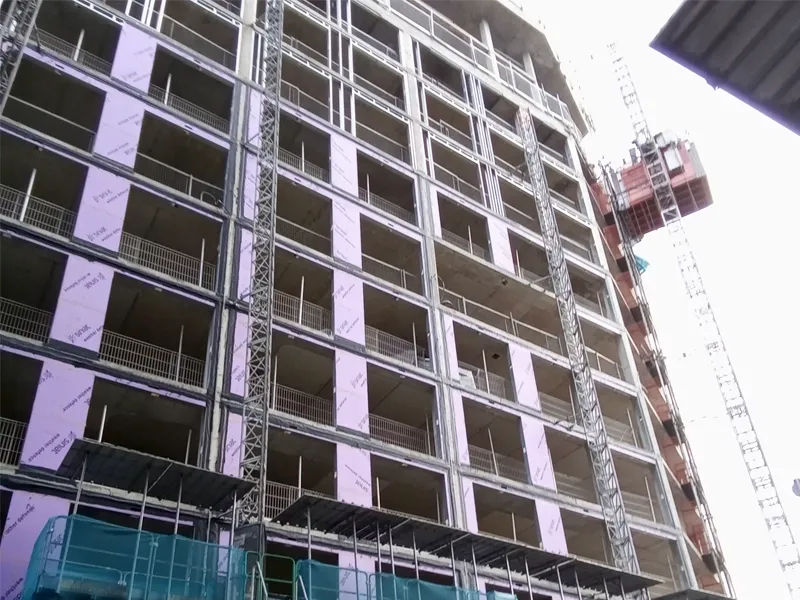

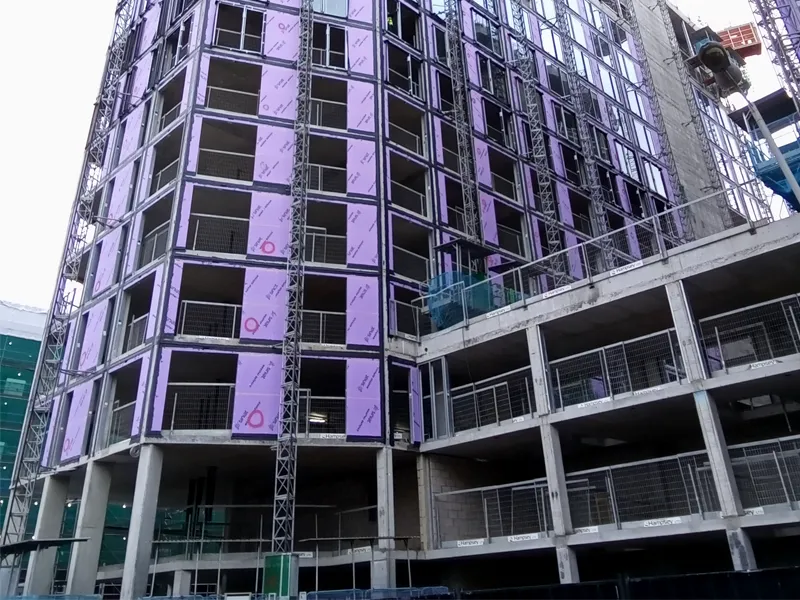

We are delighted to confirm that SFS installation is now complete across all blocks, marking a major milestone for the building envelope. With primary framing works finalised, façade and internal packages are progressing smoothly and on programme. - Roofing & Waterproofing Progress

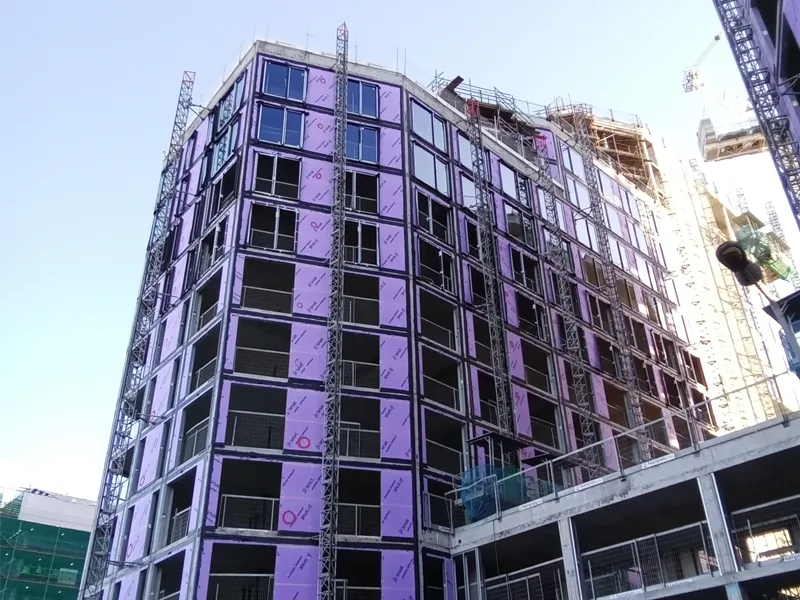

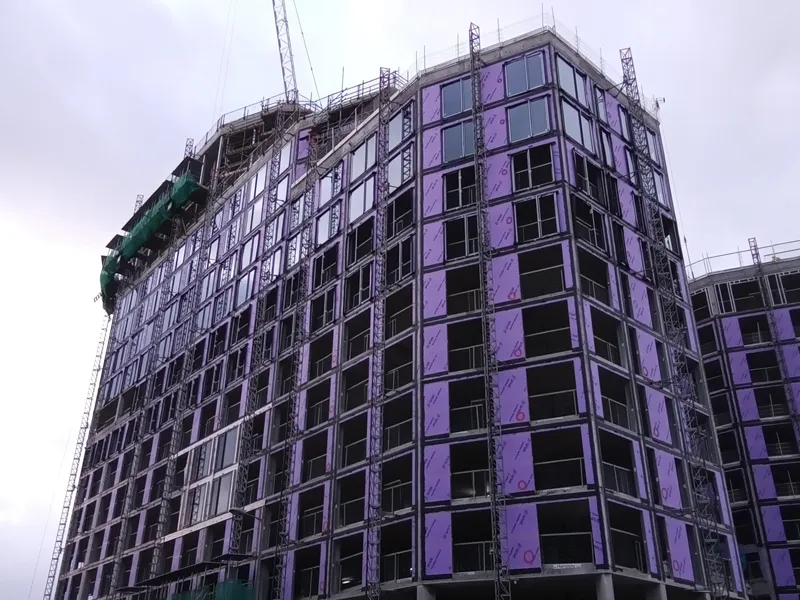

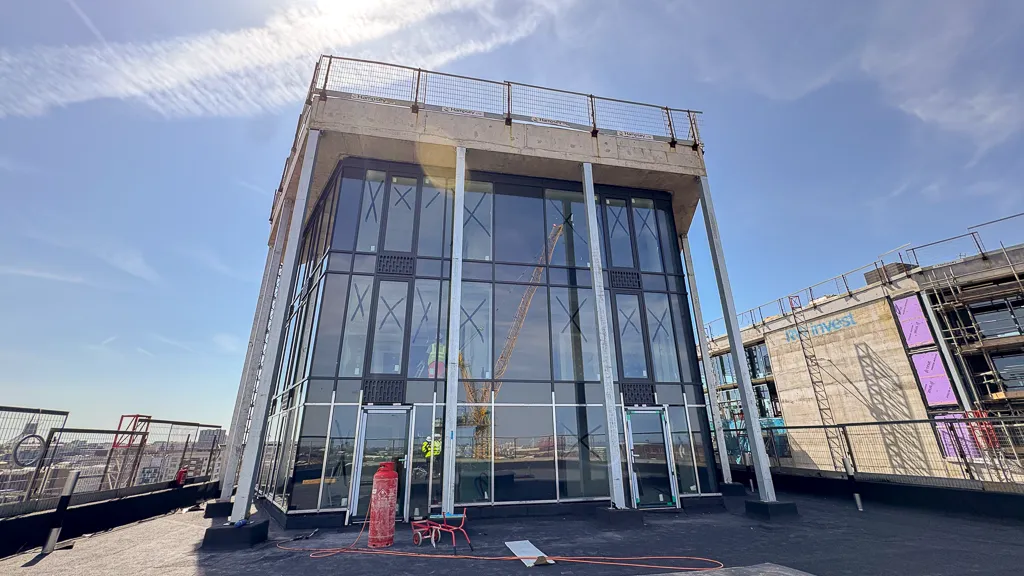

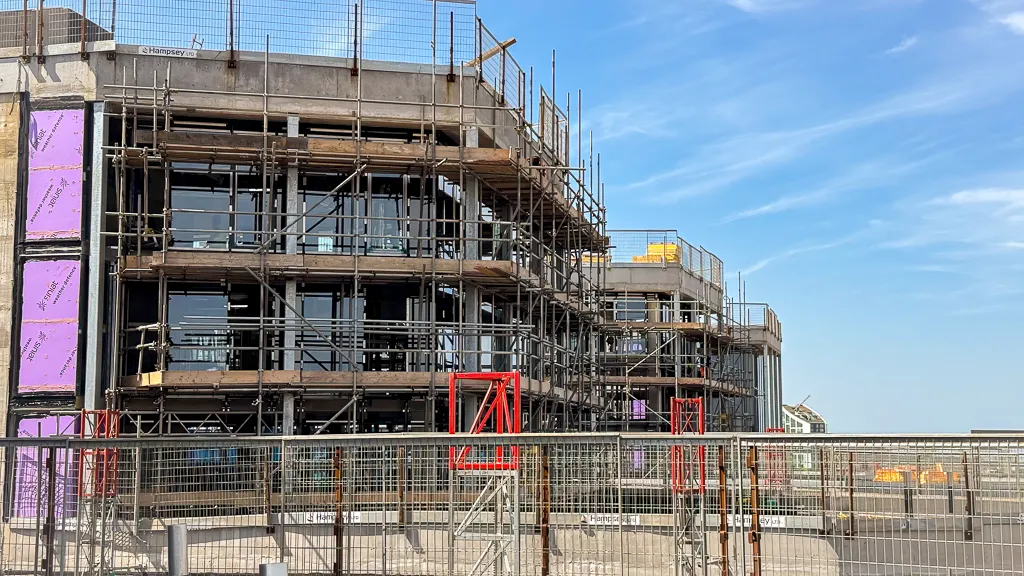

Excellent progress continues across roofing works. Block A Town House roofs are complete, alongside hot melt waterproofing to all Level 01 podiums. Level 10 and Level 12 terraces have also completed hot melt and vapour control layer (VCL) installations, significantly enhancing weather protection across the scheme. - Windows & Curtain Walling Advancing

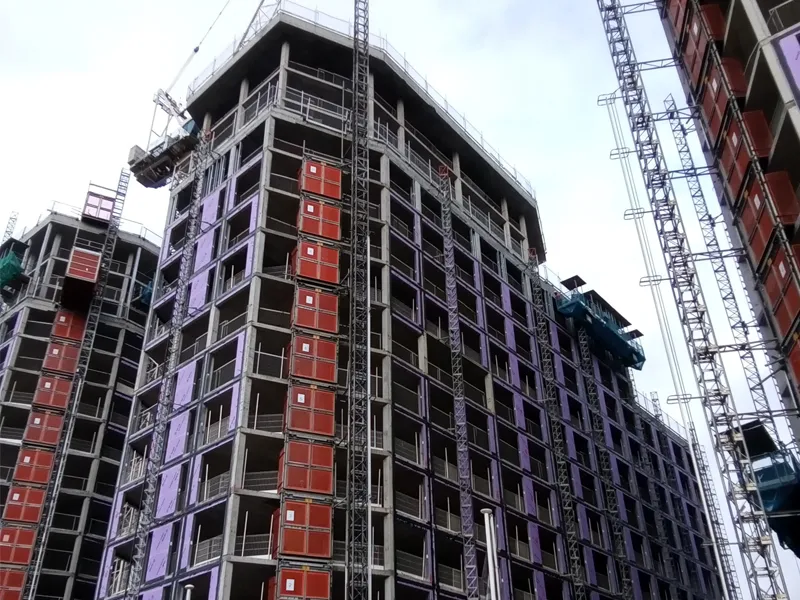

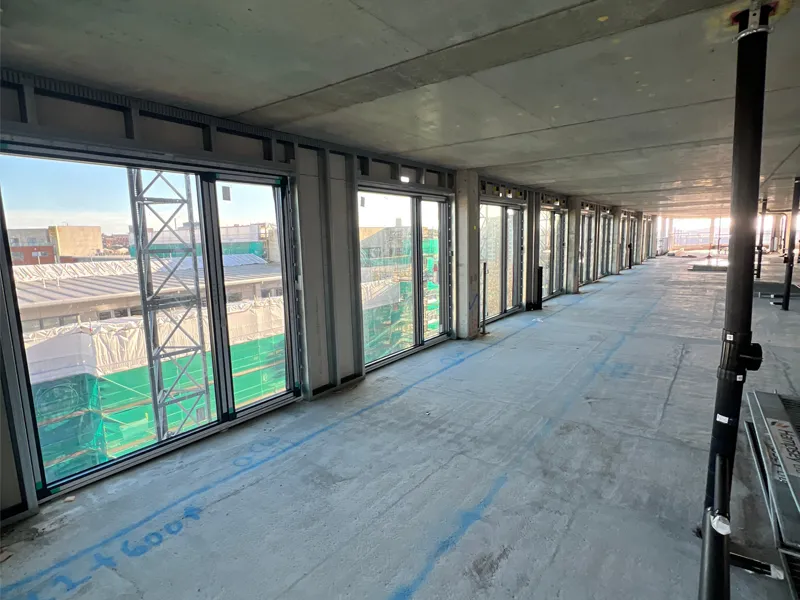

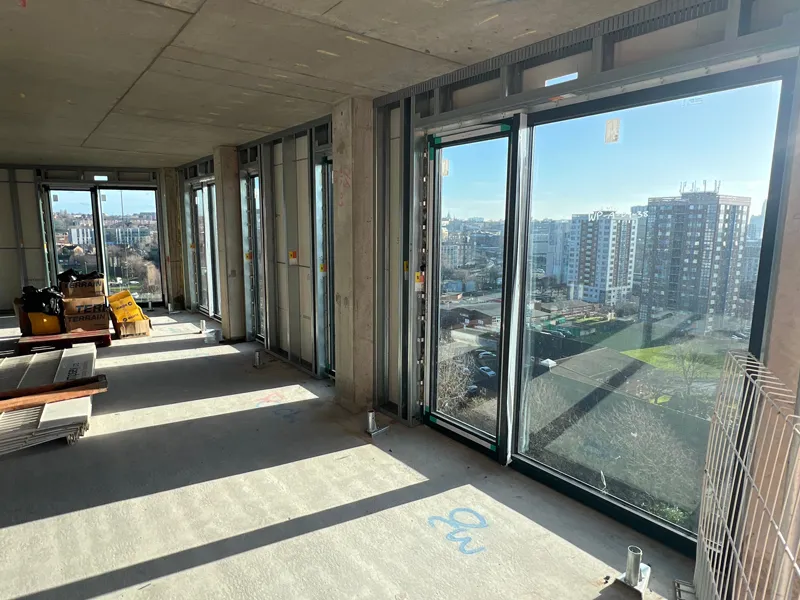

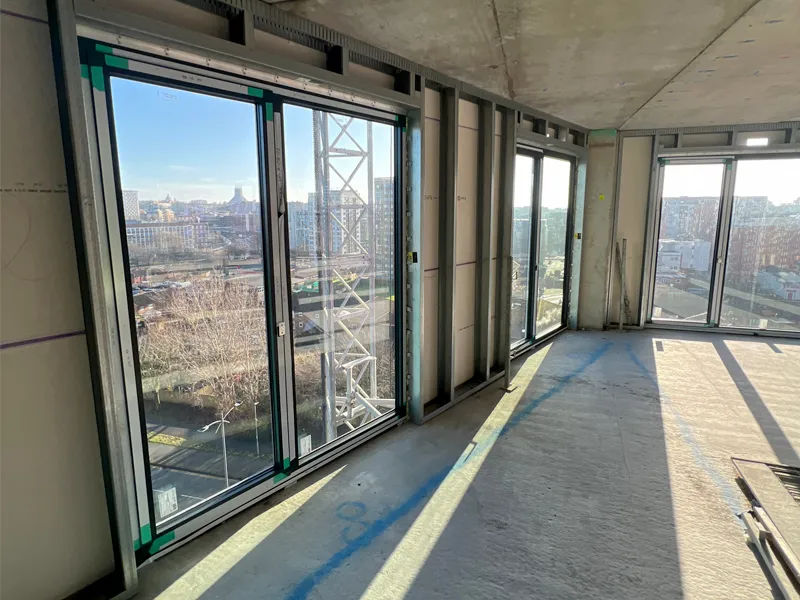

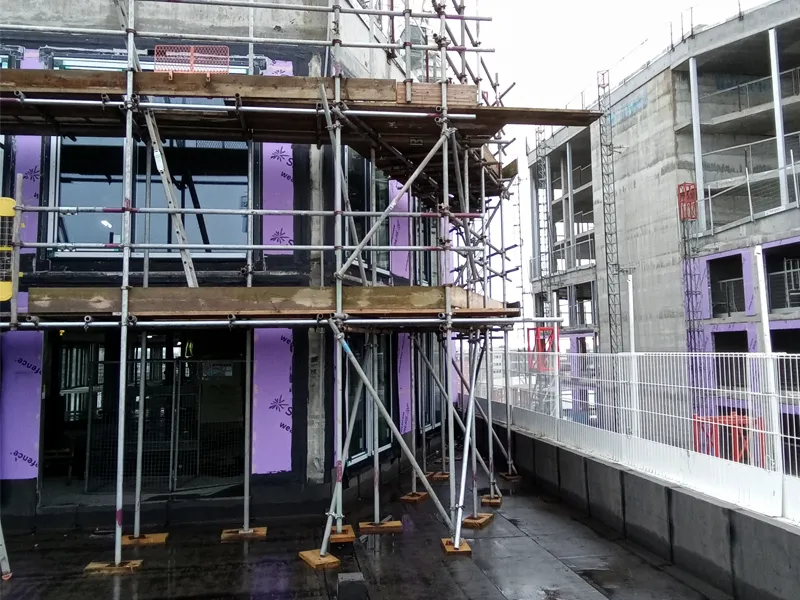

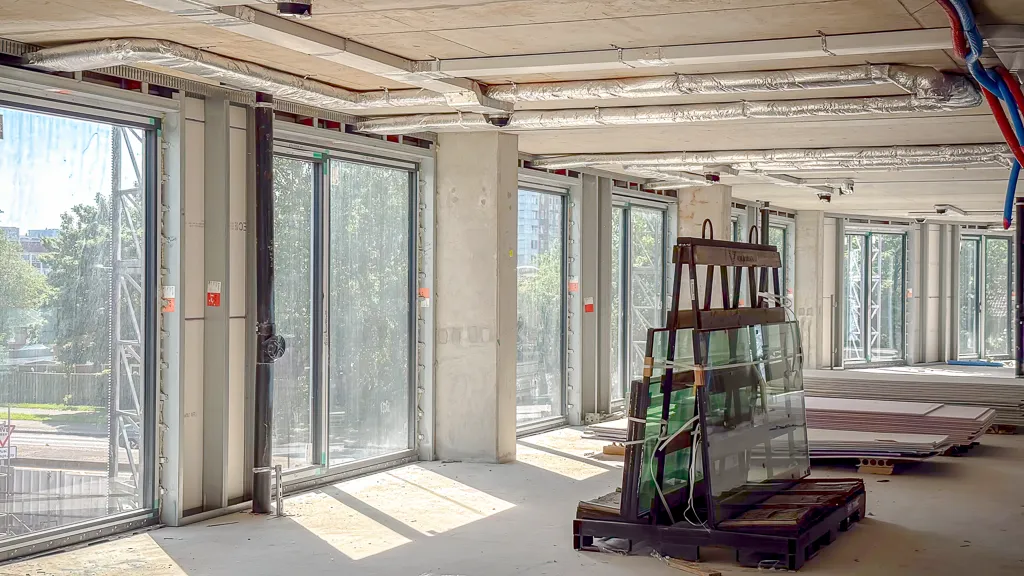

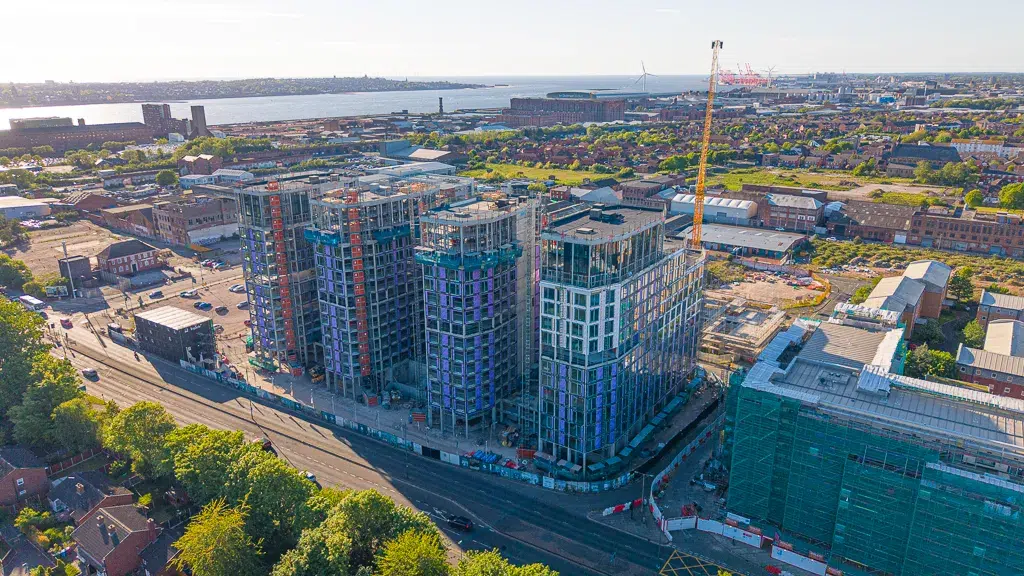

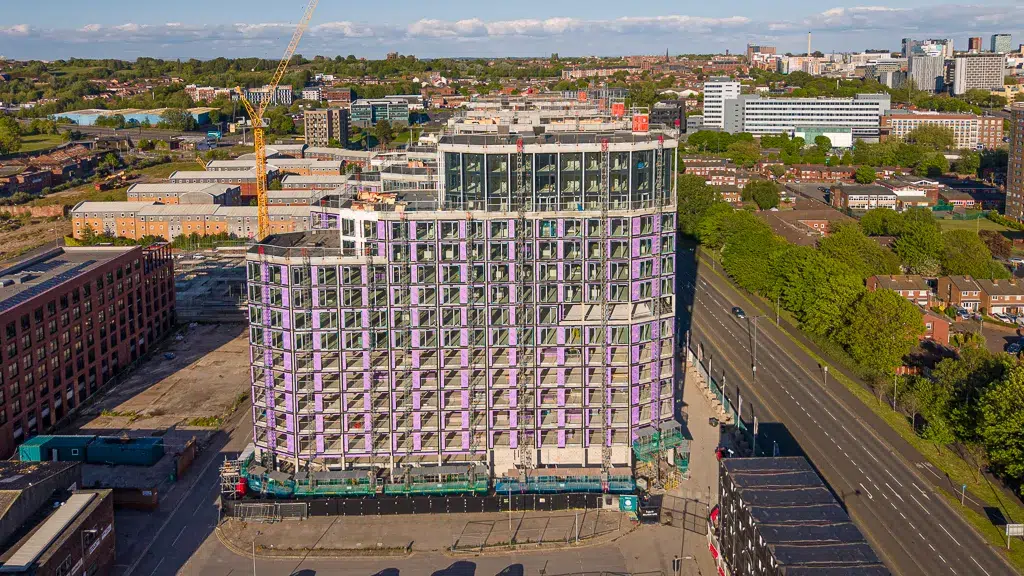

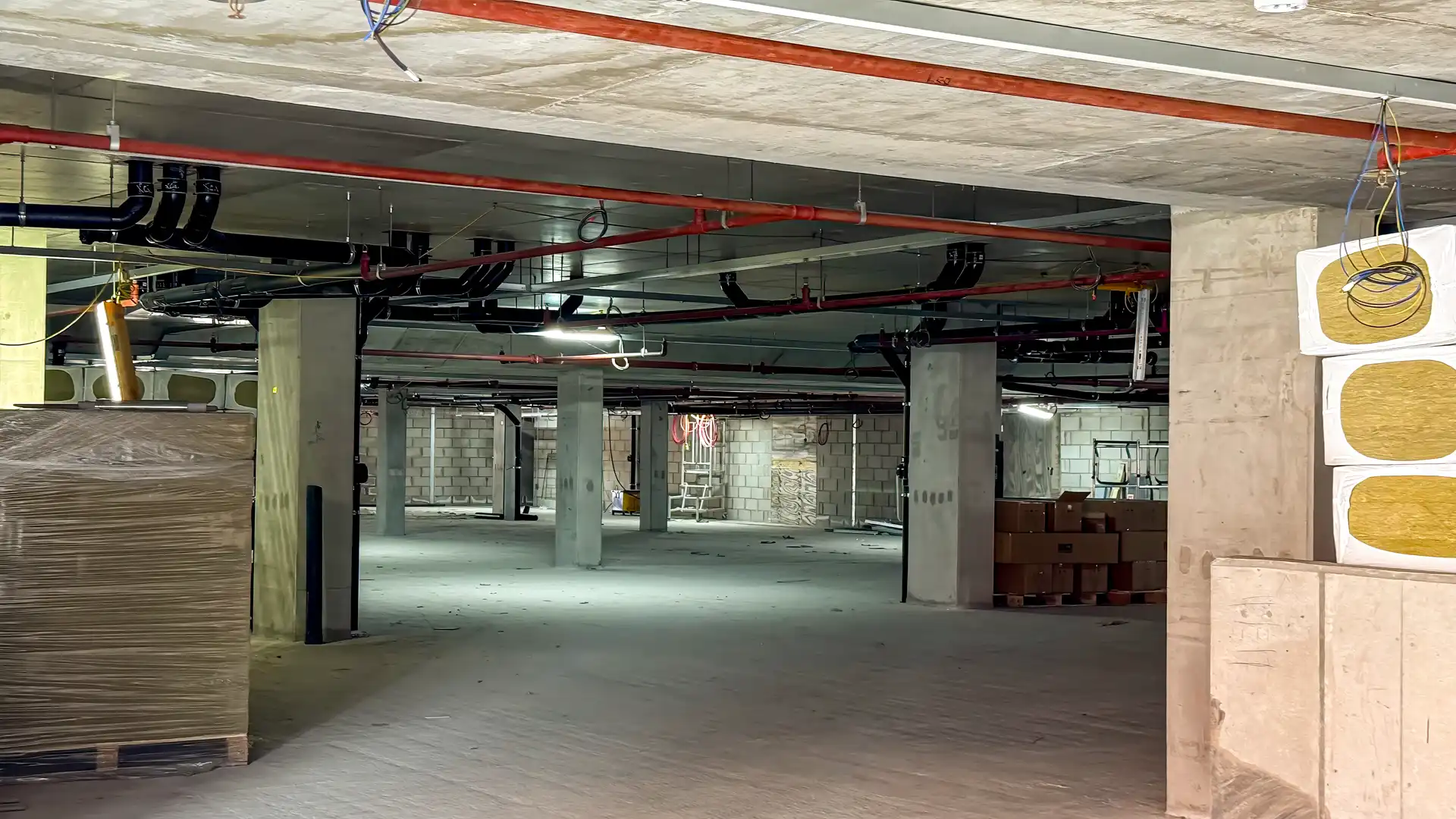

The building façade is rapidly taking shape. Levels 11 to 06 are now fully glazed in block A. High-level curtain walling is progressing well, supported by the completion of scaffolding works. - Rainwater & Drainage Nearing Completion

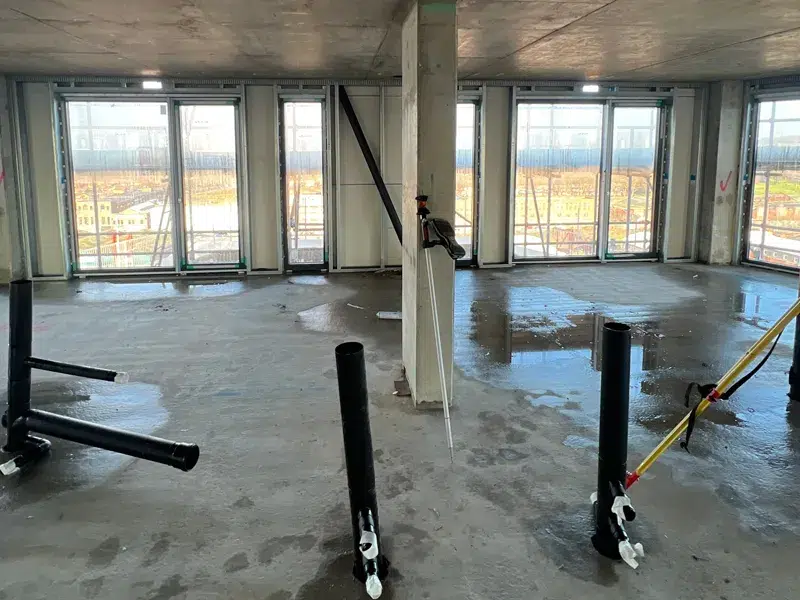

RWP and SWP installations are advancing strongly and are now nearing completion to the upper levels, supporting overall envelope works and maintaining positive site momentum. - Mechanical & Electrical Progress

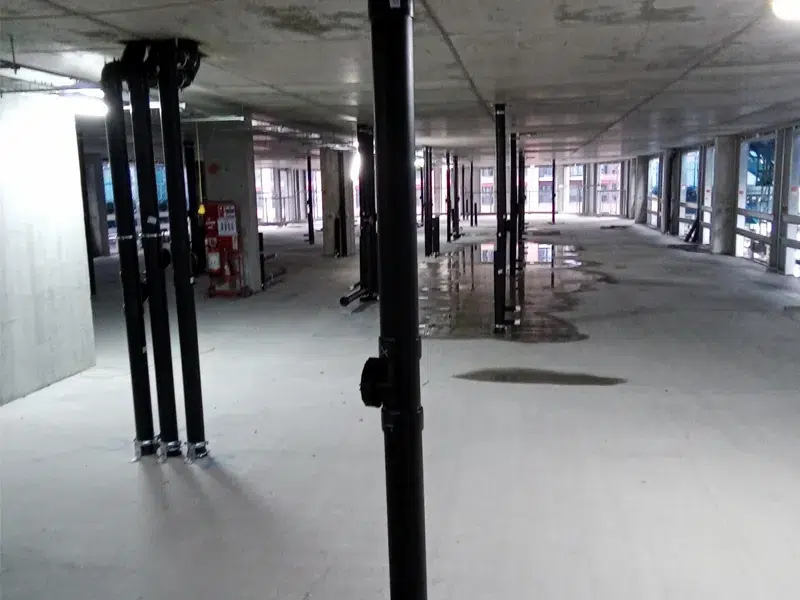

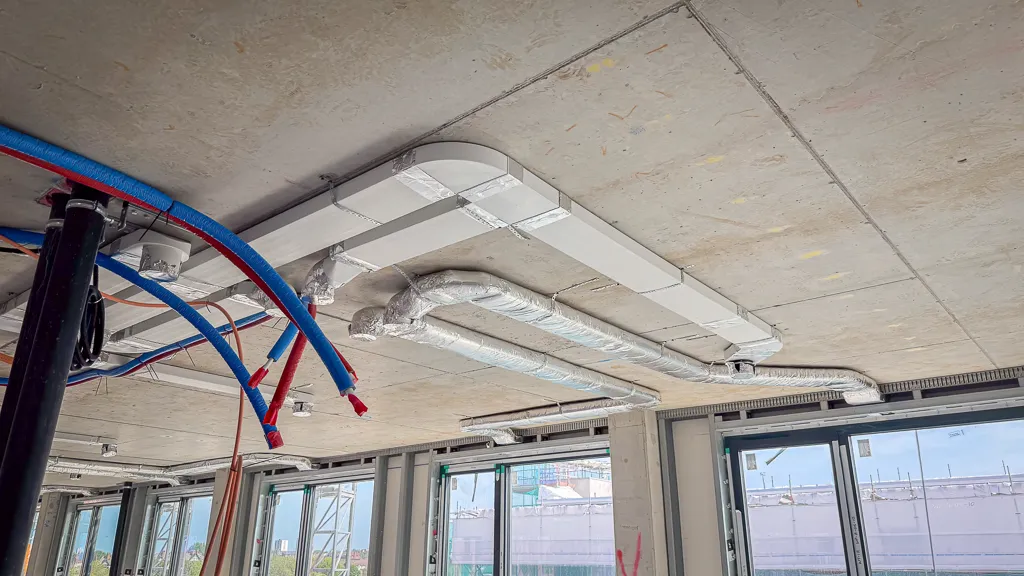

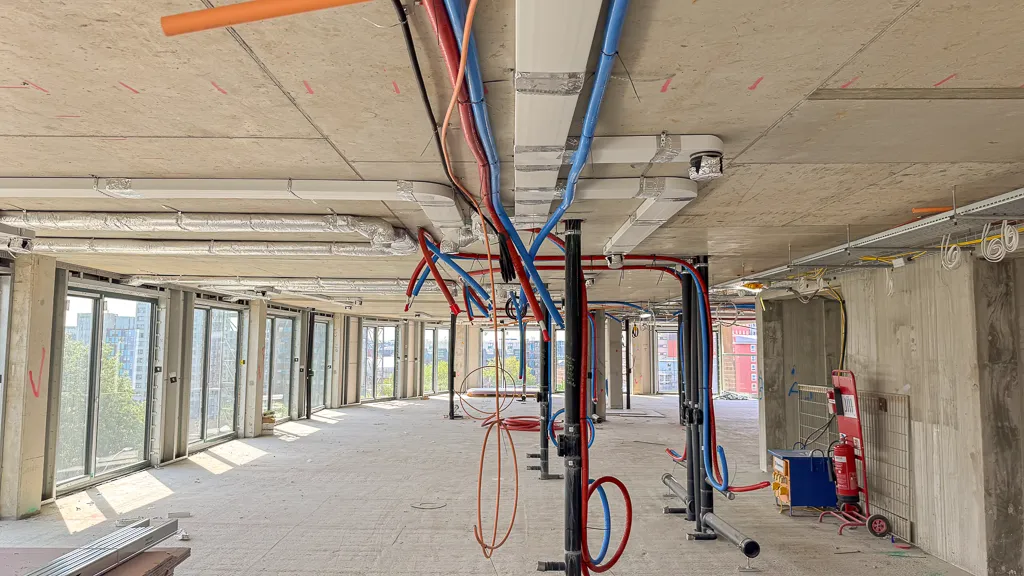

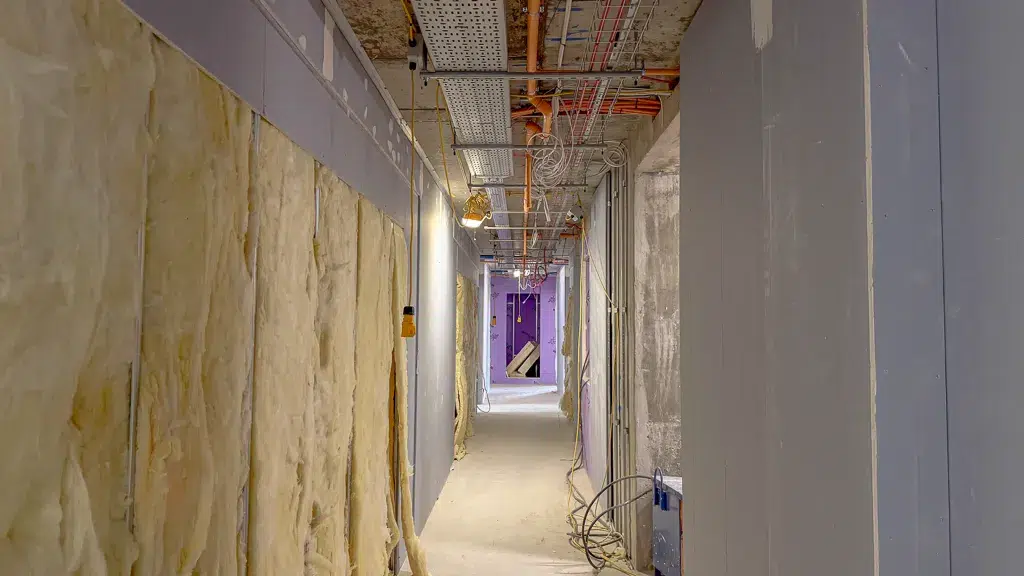

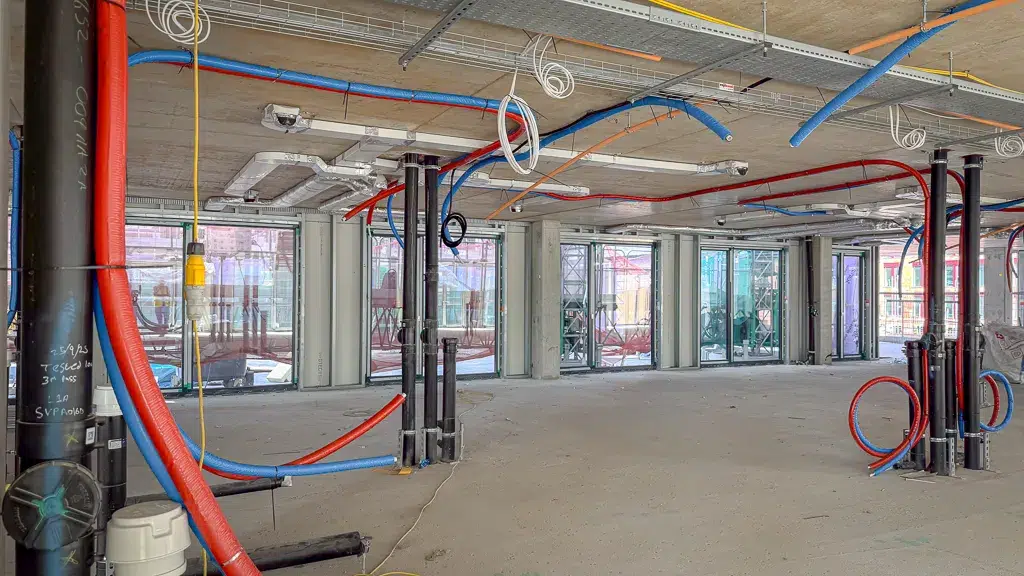

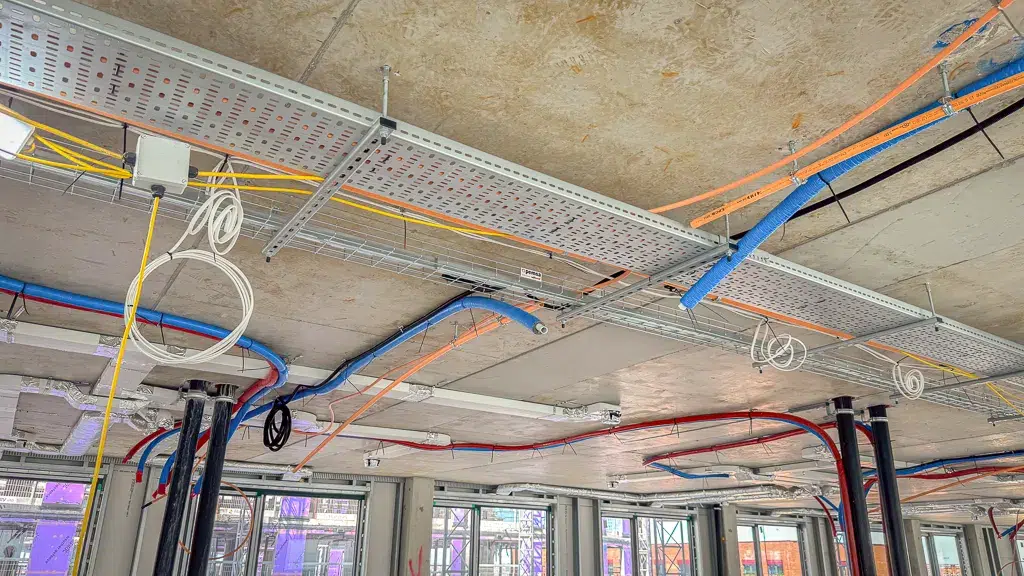

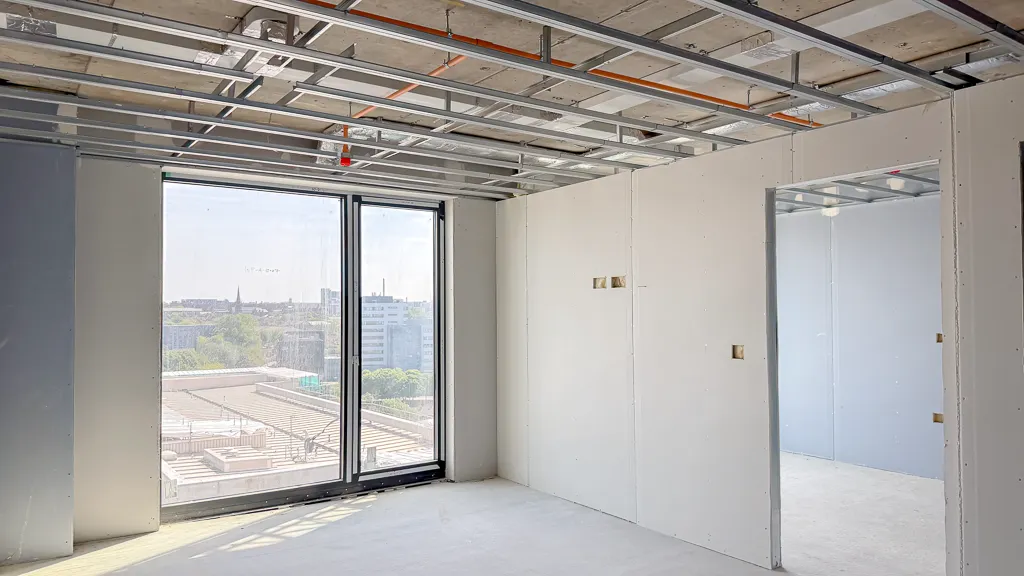

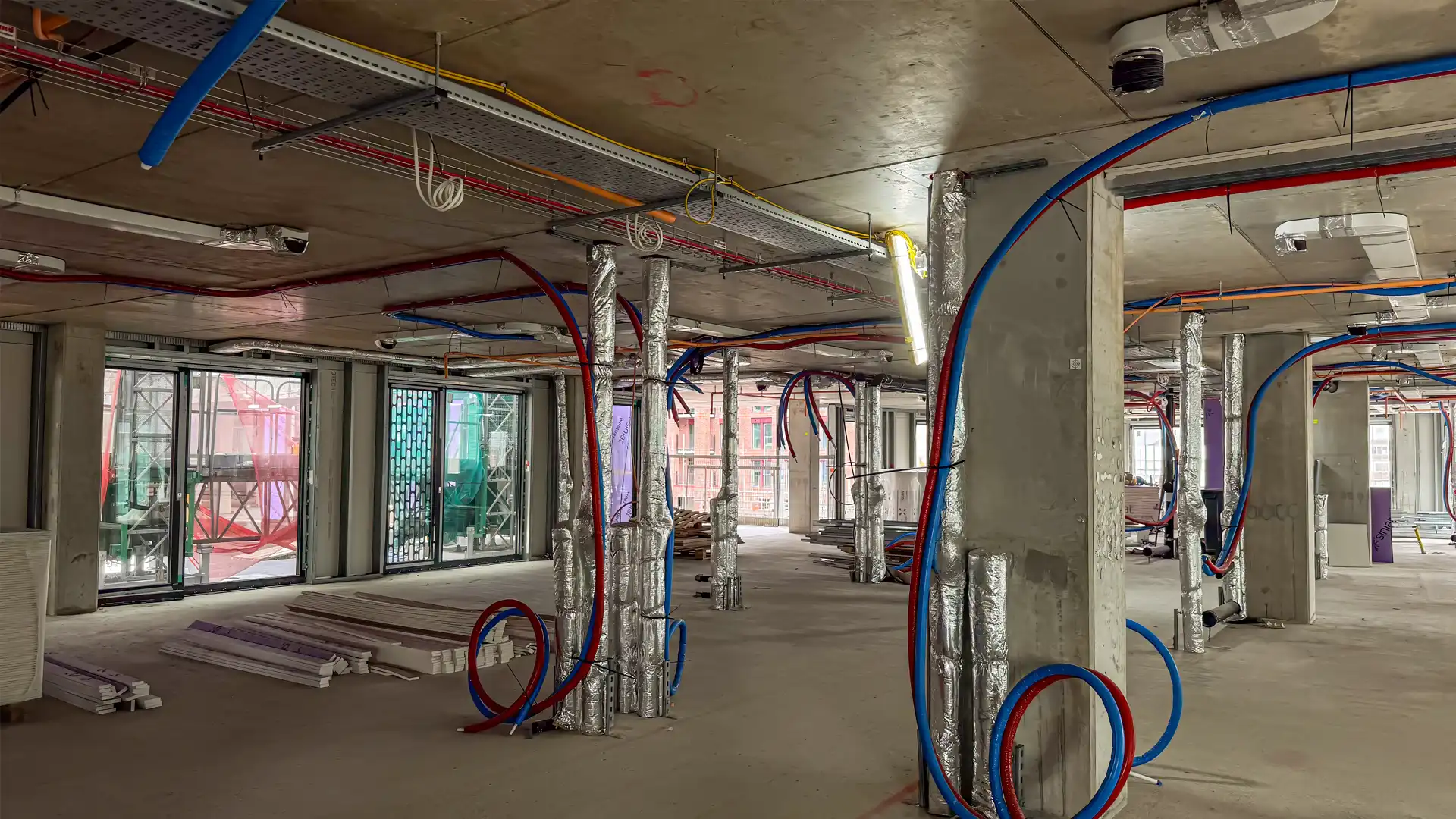

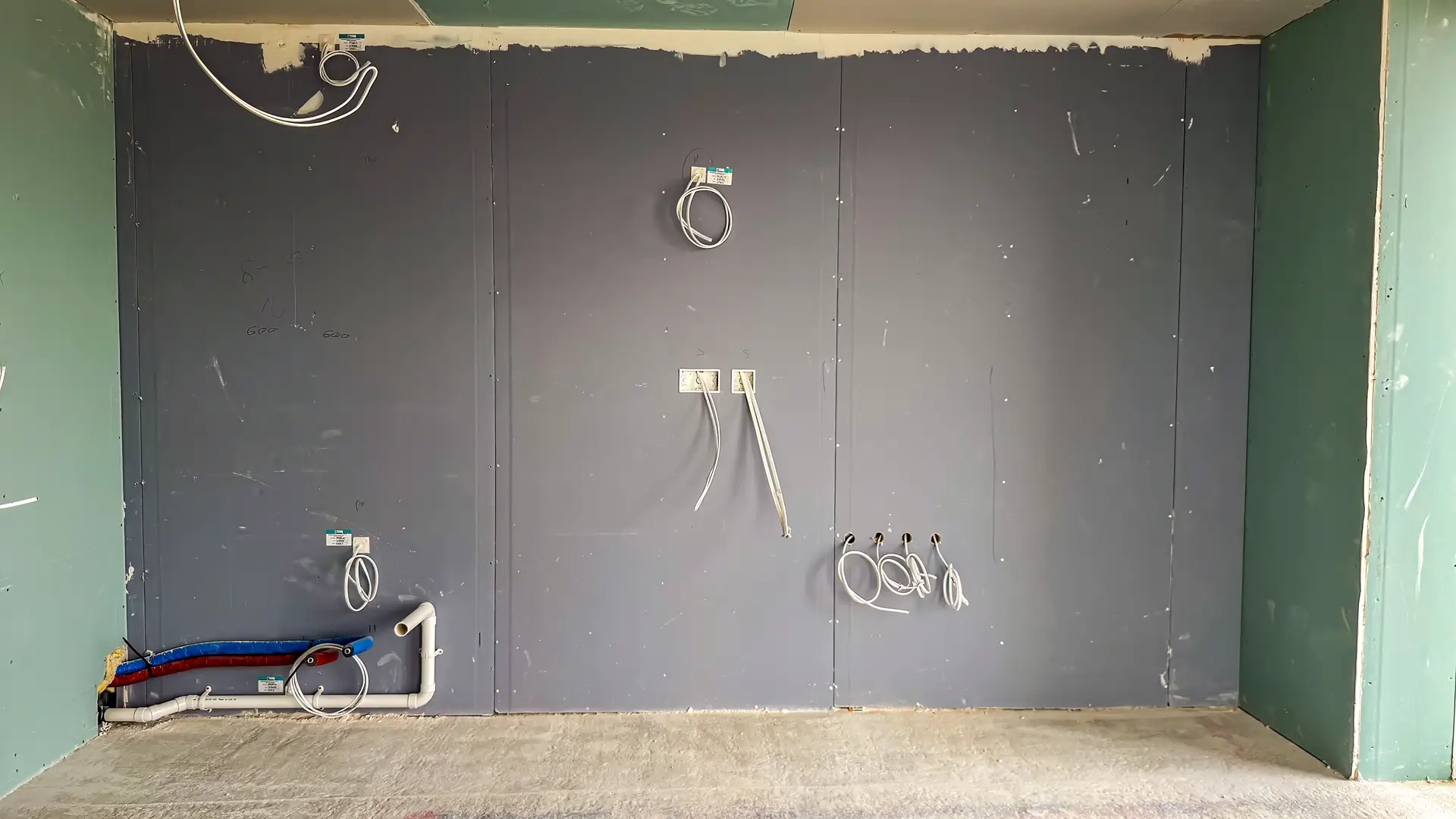

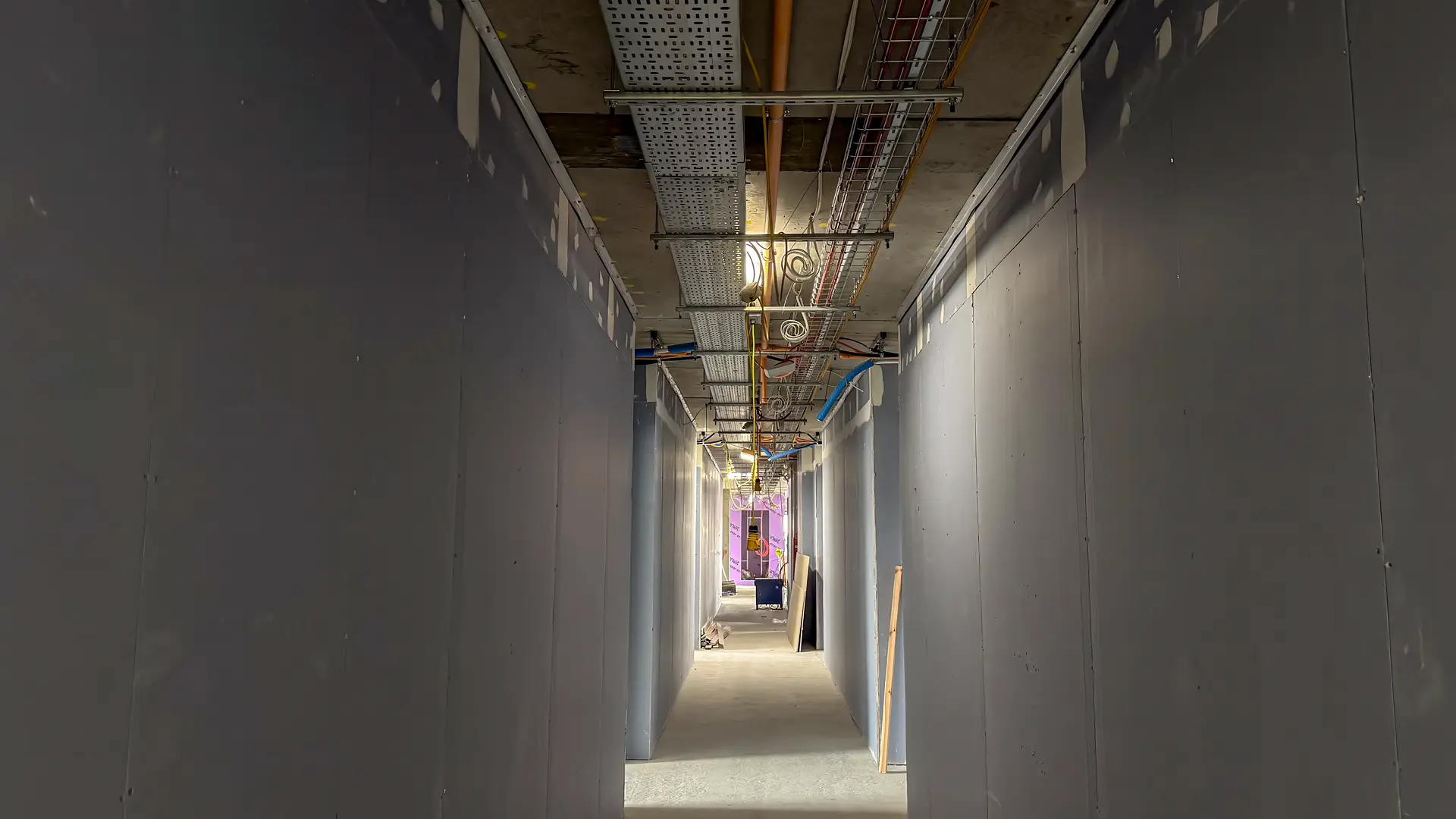

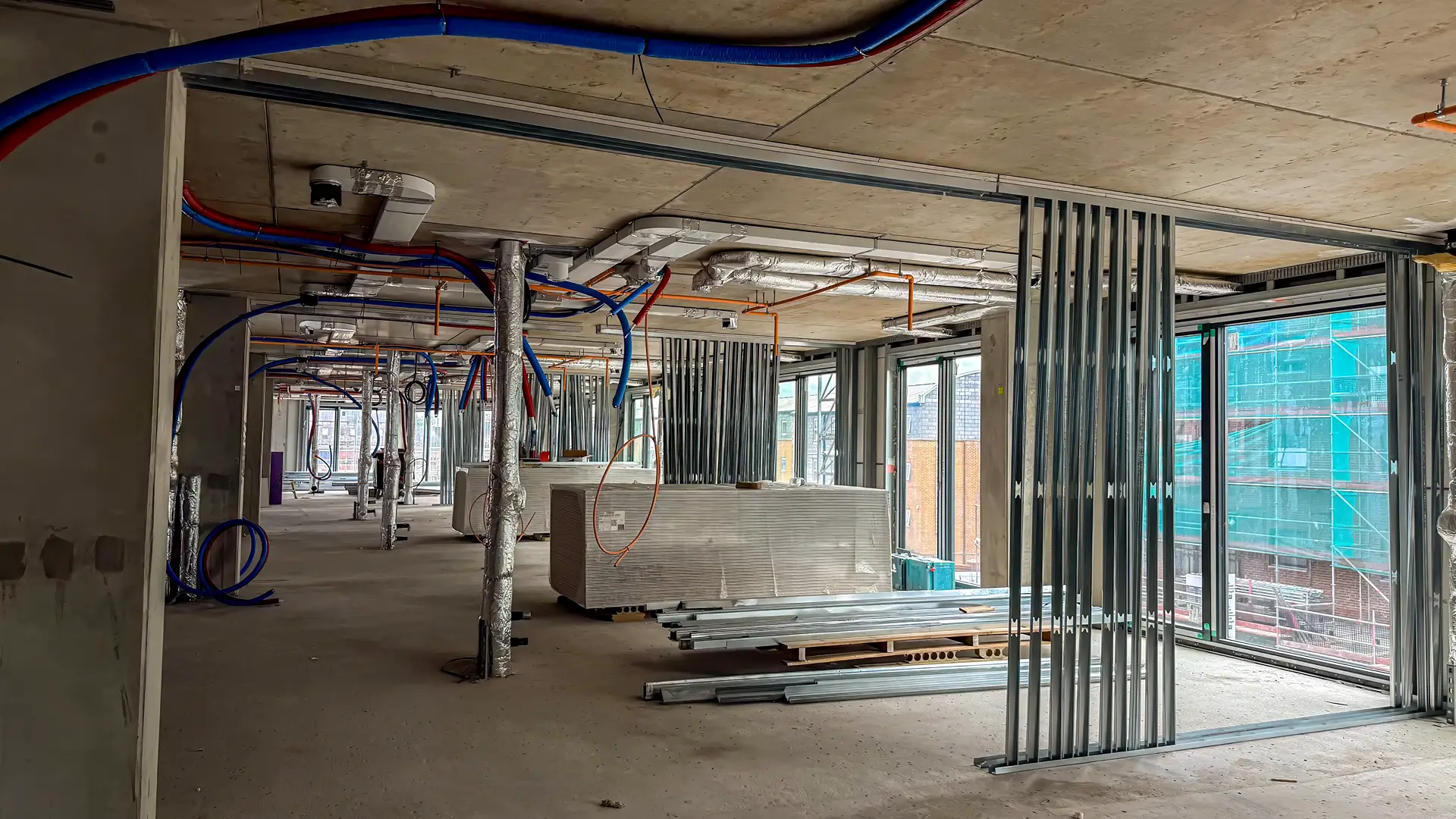

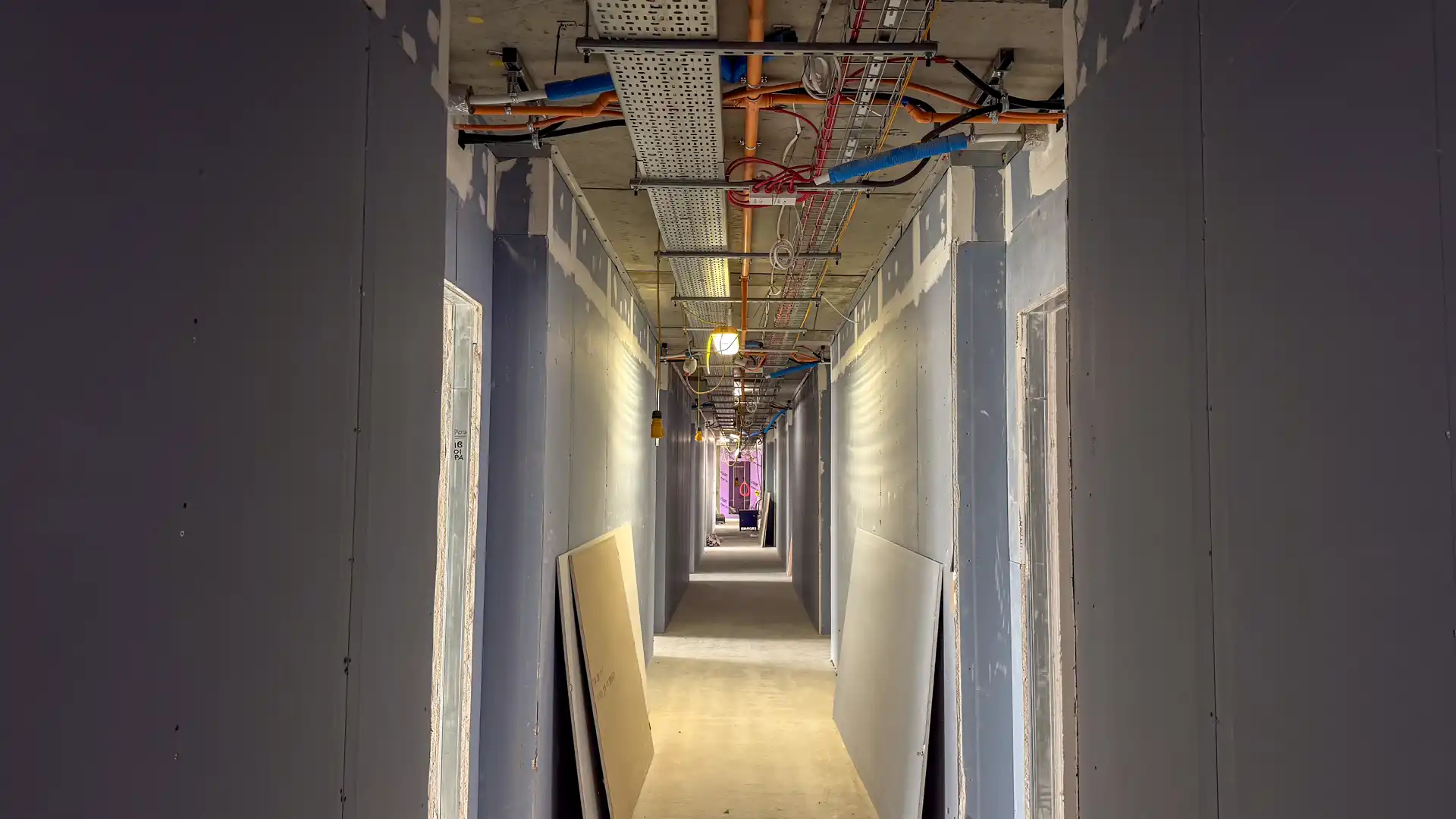

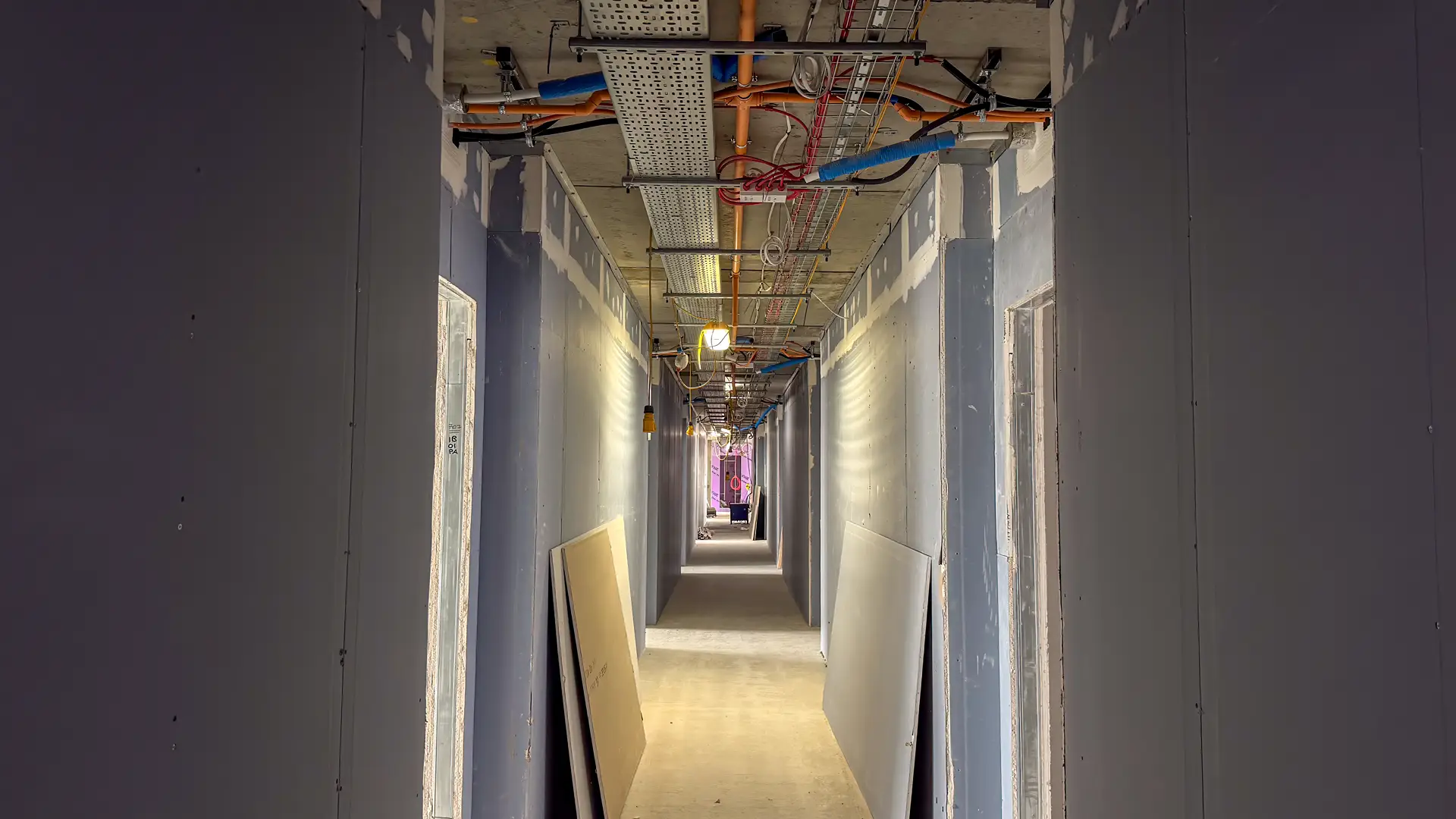

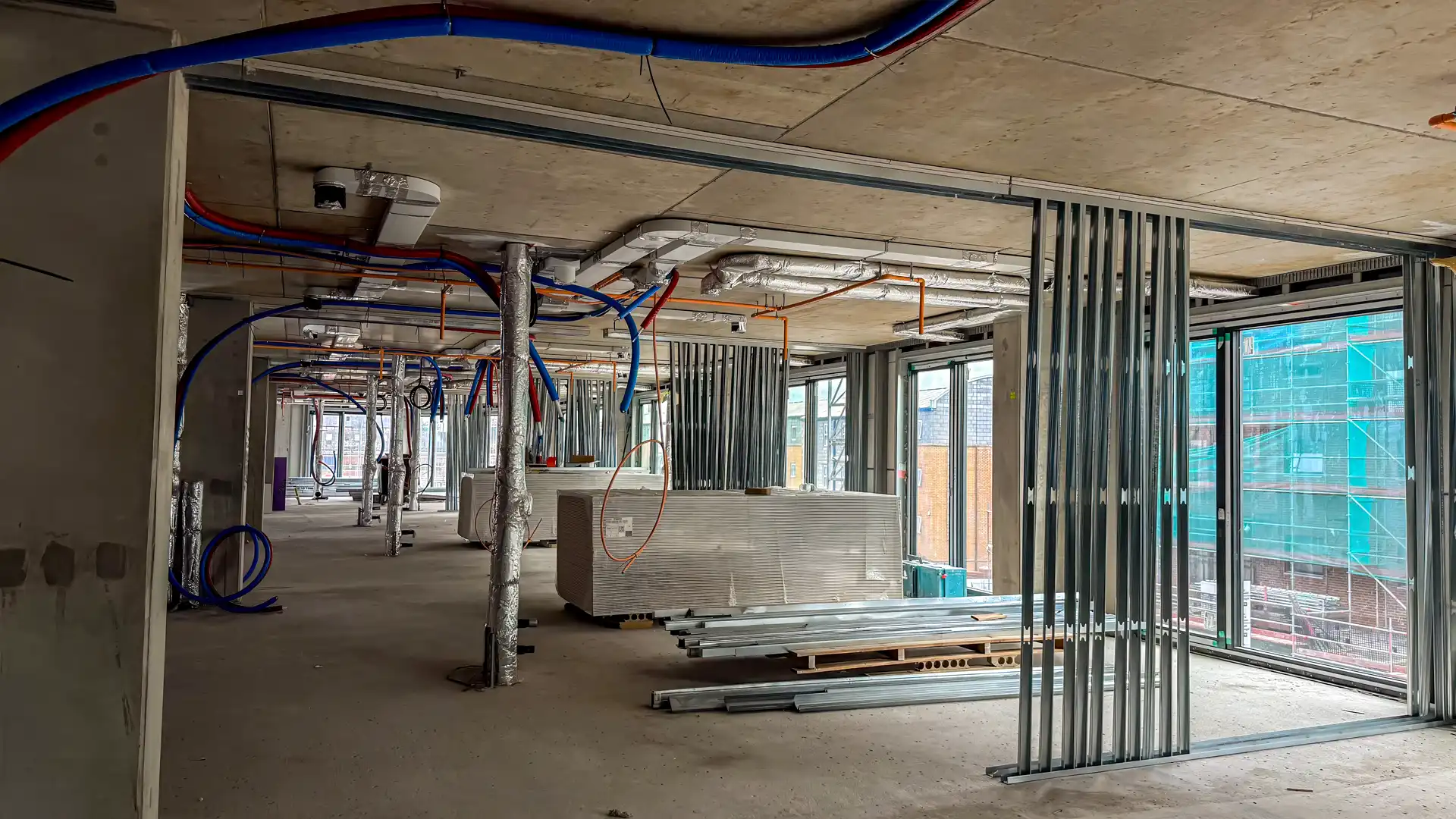

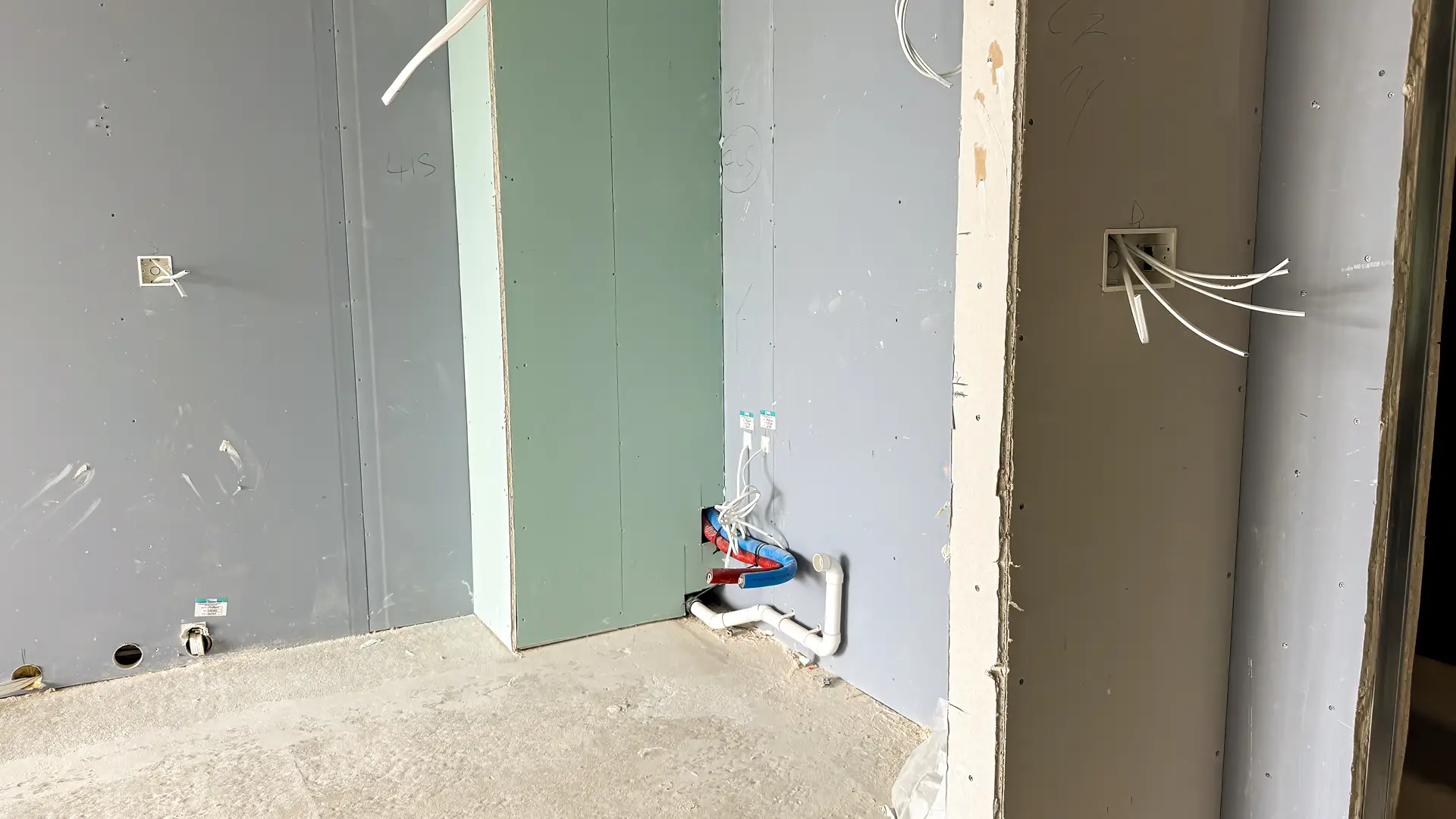

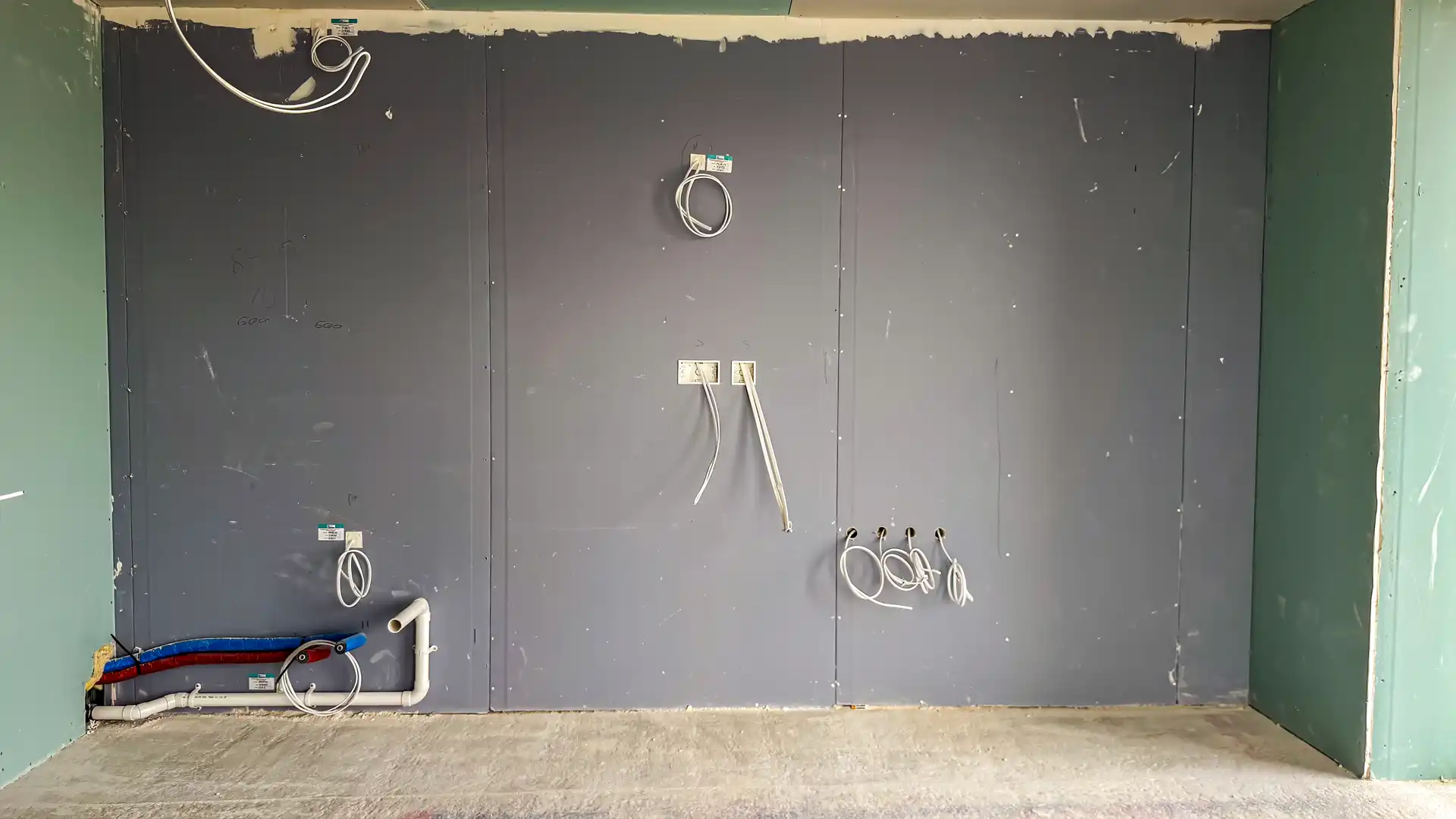

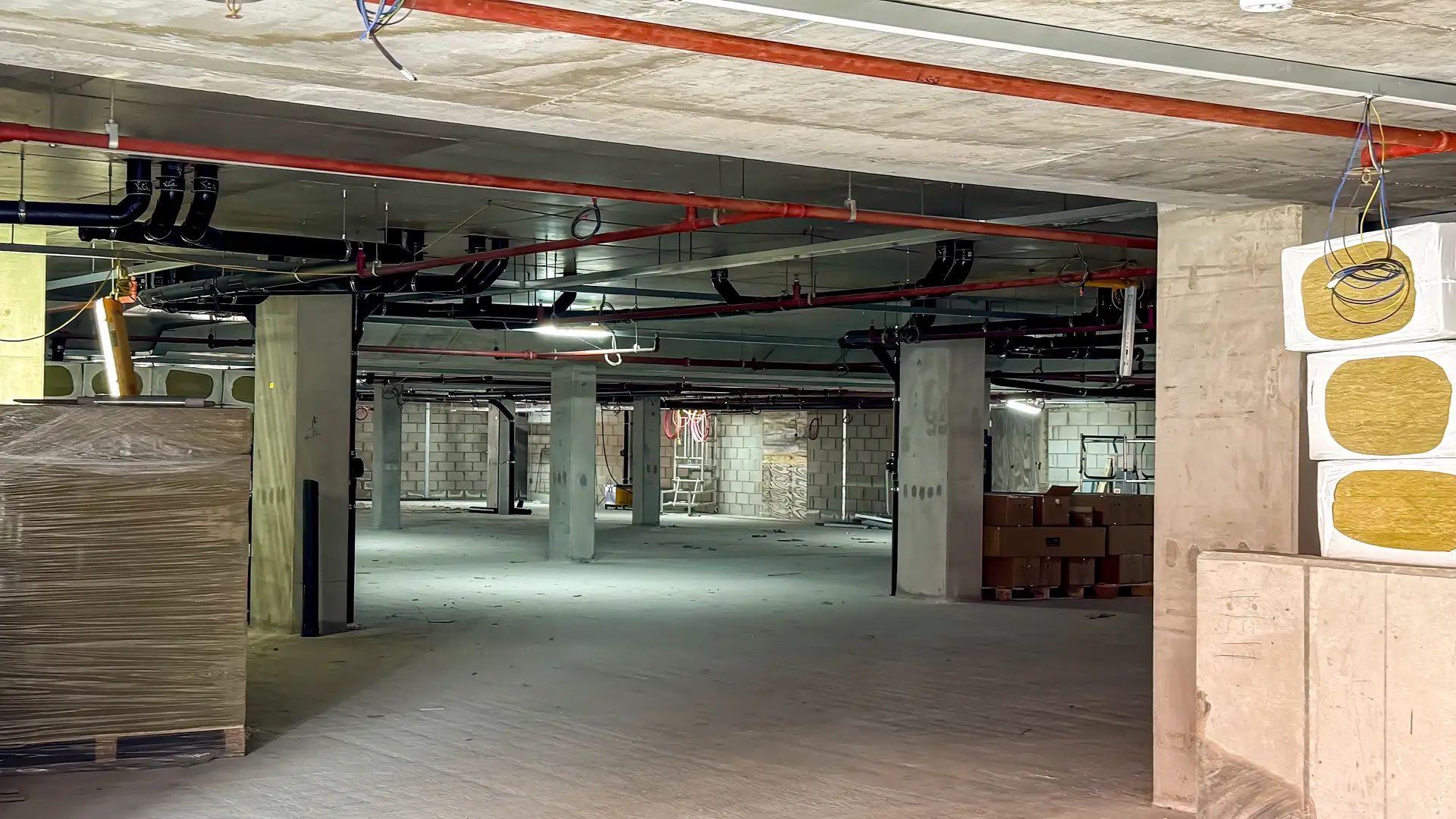

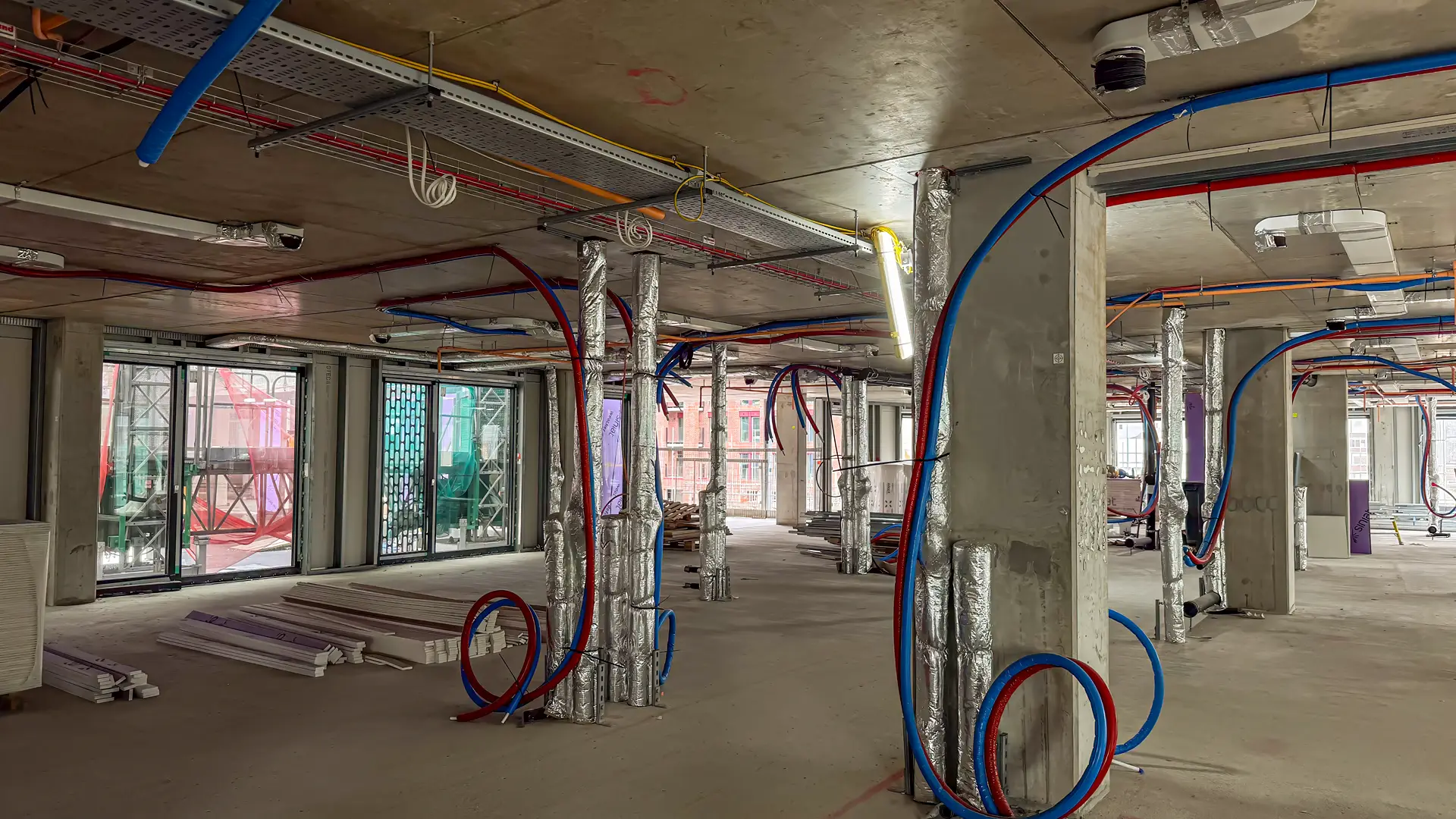

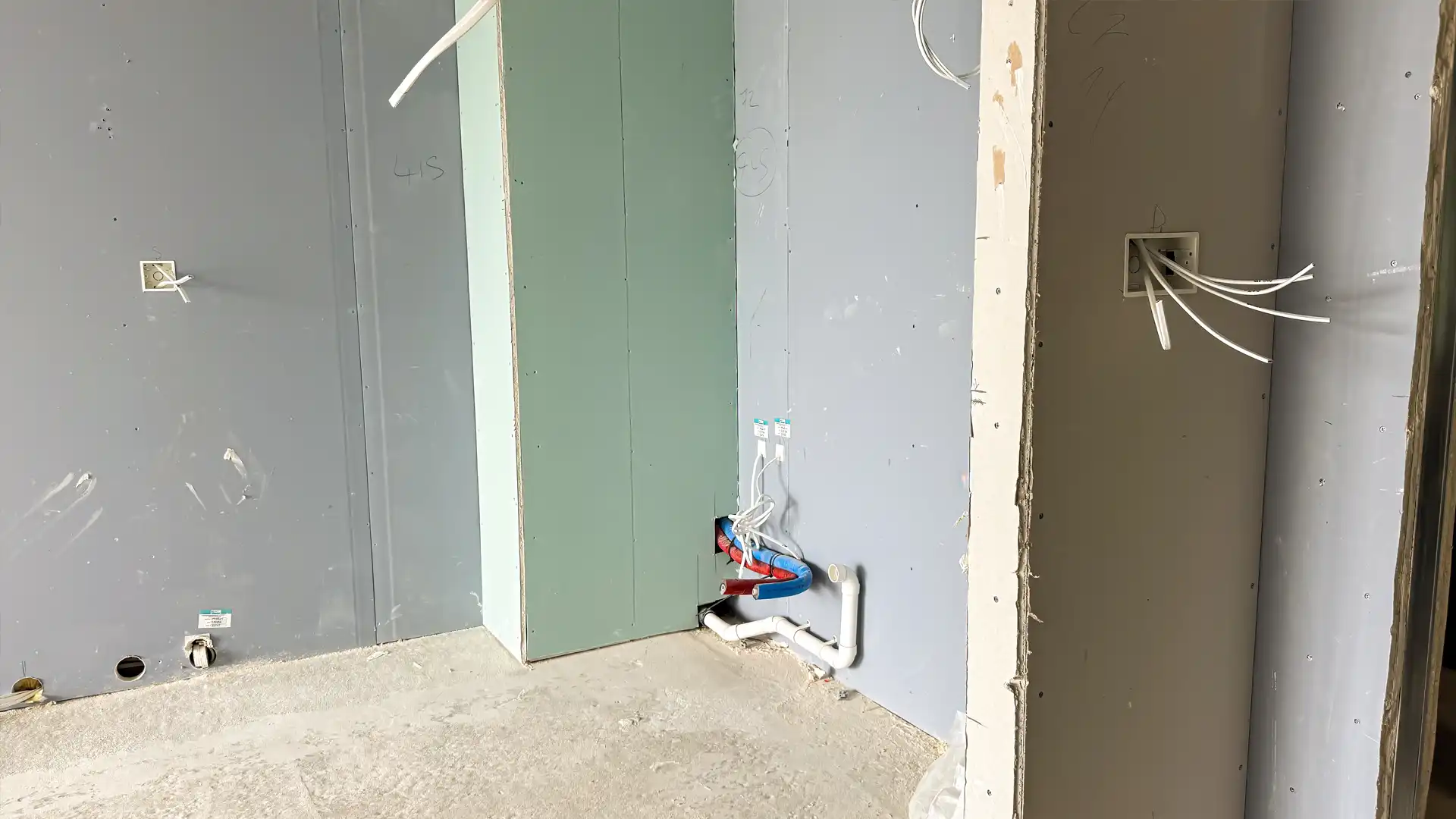

Electrical containment installations are well advanced across the ground floor, corridors, risers, and Levels 01 to 06, ensuring readiness for the next phase of MEP works. - High-Level Structural Milestone

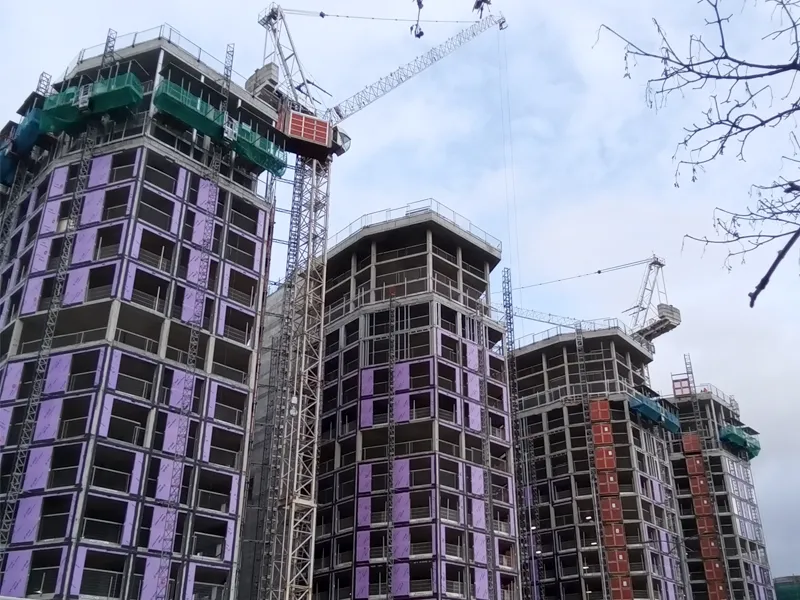

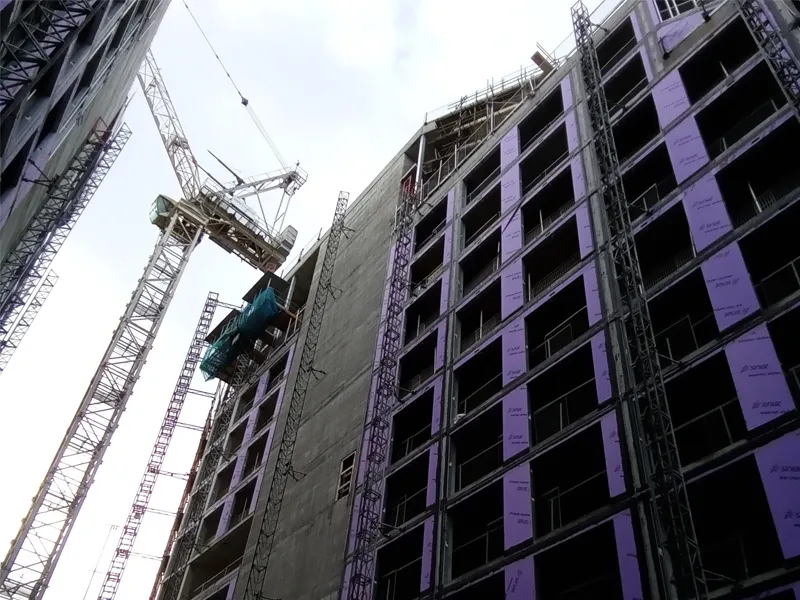

Wind posts from Levels 12 to 14 are now complete across multiple blocks, marking another key structural milestone. These works provide essential support for the façade system and maintain strong momentum across upper levels of the development.
Latest Update
Q4 2025 Update
The Gateway, Construction Update – Q4 2025
Progress in the Period
Key operational infrastructure is now in place. The onsite substation is fully complete, with temporary power now live to support efficient, coordinated activity across the site. Mast climbers are secured to every block, enabling safe, continuous vertical progress, while blockwork continues at the ground floor, mezzanine, and basement levels.
Installation of the Steel Frame System is advancing well on all blocks, with several levels now finished and boarded. Rainwater pipe systems are being installed across multiple areas, and roofing to the townhouse units has been completed.
Overall, the fourth quarter has delivered highly positive momentum, with significant achievements visible in every part of the development. The Gateway is firmly establishing itself as one of Liverpool’s most exciting regeneration schemes.
Latest Update
Q3 2025 Update
The Gateway, Construction Update – Q3 2025
Progress in the Period
Block A (Queens) – Structural works have reached Level 12, with Level 11 now complete and formwork installation underway for Level 13. External drainage is progressing, alongside SFS installation at Level 1 and ongoing blockwork at ground and mezzanine levels.
Block B (Williamsburg) – Level 6 has been completed, with decking now being installed for Level 7. Structural progress continues in line with programme expectations.
Block C (Brooklyn) – Level 5 is now structurally complete with decking works progressing for Level 6. External drainage works are also nearing completion.
Block D (TriBeca) – Structural works have reached Level 10, following the completion of Level 9 and installation of decking to Level 10 now underway.

Podium Works – Structural podium sections linking all blocks (A–B, B–C, and C–D) are now fully complete. Roofing works to the podiums are currently in progress, marking continued development of the integrated ground-level space.
Site Infrastructure – The substation is now fully complete, with all cables and transformers successfully installed. Mast climber installation is ongoing at Blocks A and D, and the car park ramp from basement to ground is structurally in place. Shuttering is underway for the next phase connecting ground to mezzanine level.
Additional Works – Precast stair installations continue across all cores, with wind post and blockwork installation ongoing at ground and mezzanine levels. SFS and boarding works are progressing, particularly at Block A, and roof works have commenced on the podiums and townhouses.
Progress in the Period
Block A (Queens) – Structural works have reached Level 12, with Level 11 now complete and formwork installation underway for Level 13. External drainage is progressing, alongside SFS installation at Level 1 and ongoing blockwork at ground and mezzanine levels.
Block B (Williamsburg) – Level 6 has been completed, with decking now being installed for Level 7. Structural progress continues in line with programme expectations.
Block C (Brooklyn) – Level 5 is now structurally complete with decking works progressing for Level 6. External drainage works are also nearing completion.
Block D (TriBeca) – Structural works have reached Level 10, following the completion of Level 9 and installation of decking to Level 10 now underway.
Podium Works – Structural podium sections linking all blocks (A–B, B–C, and C–D) are now fully complete. Roofing works to the podiums are currently in progress, marking continued development of the integrated ground-level space.
Site Infrastructure – The substation is now fully complete, with all cables and transformers successfully installed. Mast climber installation is ongoing at Blocks A and D, and the car park ramp from basement to ground is structurally in place. Shuttering is underway for the next phase connecting ground to mezzanine level.
Additional Works – Precast stair installations continue across all cores, with wind post and blockwork installation ongoing at ground and mezzanine levels. SFS and boarding works are progressing, particularly at Block A, and roof works have commenced on the podiums and townhouses.
Works Anticipated Moving Forward
Block A (Queens) – Construction will advance through Levels 12 and 13, alongside ongoing blockwork, wind posts, and façade preparation works including SFS and boarding.
Block B (Williamsburg) – Works will progress through Level 7 and 8, with continued development of vertical elements and internal core activities.
Block C (Brooklyn) – The structure will continue to rise through Levels 6 and 7, with reinforcement, decking and services coordination ongoing.
Block D (TriBeca) – Installation of Levels 10 and 11 is scheduled in the upcoming period, along with continued blockwork and mast climber installation to support envelope works.
Additional Works – The following activities will also continue across the site:
- Ongoing shuttering and installation of the car park ramp from ground to mezzanine
- Continued installation of precast stairs to all block cores
- Progressive installation of mast climbers across all buildings
- SFS and boarding to Block A and continued façade preparation
- Roofing installation to podiums and townhouse units
- RWP and SVP installations at Blocks A and D
Q2 2025 Update
The Gateway, Construction Update – Q2 2025
Q1 2025 Update
The Gateway, Construction Update – Q1 2025
Q4 2024 Update
The Gateway Construction Update Q4 2024
Q3 2024 Update
The Gateway – Construction Update Q3 2024
Q2 2024 Update
The Gateway – Construction Update Q2 2024
Q1 2024 Update
The Gateway – Construction Update Q1 2024
Q4 2023 Update
Q3 2023 Update
Best Prices Available Now in Horizon Manchester!
Act fast to snap up a unit from just £259,950. Short-term lets approved with projected yields from 9%+ and luxury onsite facilities including spa.
Why Choose RWinvest?
Here is why you should choose RWinvest as your UK property investment company:
Contact Us
Want to Get in Touch?
Fill in the form to contact us today and a member of our award-winning property team will be in touch to help.
